Talegaon Chakan Shikrapur Corridor

PMRDA

Other

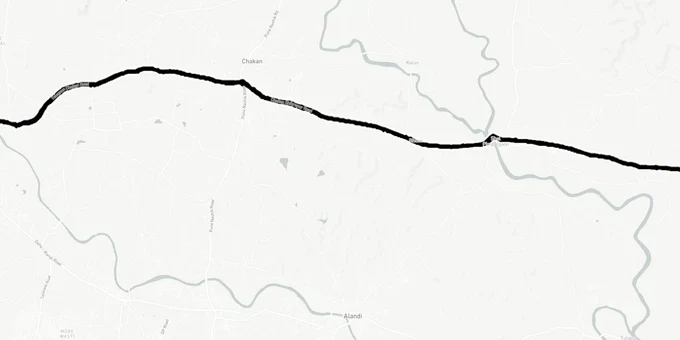

Talegaon Chakan Shikrapur Corridor map

Overview

The Talegaon Chakan Shikrapur corridor land investment case became concrete when the Maharashtra Cabinet gave administrative approval in April 2025 for a Rs 3,923.89 crore highway project on NH-548D. MSIDC is executing the 53.2 km route on a build-operate-transfer model: a four-lane elevated road from Talegaon to Chakan and a six-lane at-grade widening from Chakan to Shikrapur. The corridor connects NH-48 (Mumbai-Pune Highway) to NH-753 (Pune-Sambhajinagar Highway), bypassing Pune city entirely.

Land Acquisition Along NH-548D and the PMRDA Zone Trap Buyers Miss at Ranjangaon

The MSIDC DPR, as handed over by NHAI, specifies 38.79 hectares of land to be acquired across the 53.2 km corridor. That number is specific, and it is not yet matched to publicly disclosed village-level notification maps. Any plot directly abutting the existing two-lane NH-548D alignment between Talegaon and Shikrapur sits inside a potential acquisition footprint until MSIDC publishes its Section 3A notification under the National Highways Act. Buying before that notification appears means buying without knowing if your land is in the take zone.

Overview

Agricultural (Green Zone)

Governing Authority

PMRDA (Pune Metropolitan Region Development Authority)

Permitted Use

Farming only

Conversion Required?

Yes - SDO order for NA; PMRDA for non-agricultural development

Industrial (MIDC-notified)

Governing Authority

MIDC Maharashtra

Permitted Use

Industrial units, warehousing, ancillary use

Conversion Required?

No conversion; MIDC allotment process applies

Freehold Industrial

Governing Authority

Revenue Department / PMRDA

Permitted Use

Industrial or residential depending on local DP

Conversion Required?

NA conversion order from SDO required for residential use

The agricultural-to-industrial conversion route along Ranjangaon and Sanswadi is the most commonly misrepresented category on this corridor. Brokers advertise agricultural plots as "convertible to industrial at additional cost." That is technically true ,PMRDA is the sanctioning authority for most of this belt ,but the conversion process requires an SDO order, PMRDA clearance, and changes in the 7/12 mutation entries before any construction can legally begin. A plot listed as "agriculture with potential to convert" is agricultural land until those orders exist in writing. Do not treat broker assurances of future conversion as equivalent to a current non-agricultural order.

Chakan MIDC, Talegaon Freehold, and Shikrapur: Which Sub-Market Is Actually Investable Today

Talegaon MIDC (Navlak-Umbre, Akurdi, Ambi)

Position on Corridor

NH-48 end, Talegaon start

Key Driver

MIDC 585 ha in five phases; Hyundai (acquired GM) plant driving ancillary demand

Specific Risk

Phase I and II fully allotted; limited fresh availability

Freehold land, Talegaon-Chakan road

Position on Corridor

Talegaon to Chakan stretch

Key Driver

Cheaper alternative to MIDC; large developers building built-to-suit and leasing long-term

Specific Risk

Elevated road alignment cuts through existing 2-lane; acquisition risk on highway-adjacent parcels

Chakan MIDC Phases I-VII, Khed

Position on Corridor

Mid-corridor

Key Driver

Established auto cluster; Khed City PPP with Kalyani Group and MIDC

Specific Risk

MIDC secondary transfers require MIDC approval; Khed Logistics Park impersonating Khed City brand

Shikrapur, Ranjangaon, Shirur

Position on Corridor

NH-753 end, Shikrapur terminus

Key Driver

Agricultural land near Ranjangaon MIDC priced for industrial conversion

Specific Risk

Agriculture-to-industrial conversion process through PMRDA needed; no gazette notification for acquisition yet

The Khed City brand impersonation is documented and specific. Khed City, the 1,900-acre integrated industrial township developed by the Kalyani Group and MIDC, has formally stated that Khed Logistics Park India LLP has no association with Khed Economic Infrastructure Private Limited. Buyers purchasing plots marketed under any "Khed City" branding must verify directly with KEIPL at their Pune office whether the plot is inside the actual Khed City project boundary. One phone call to the right office eliminates this risk entirely.

Frequently Asked Questions

What is the Talegaon Chakan Shikrapur corridor land investment case based on?

Maharashtra Cabinet gave administrative approval in April 2025 for the Rs 3,923.89 crore NH-548D upgrade. MSIDC executes it on a BOT model. The 53.2 km route links NH-48 to NH-753, bypassing Pune city and cutting logistics travel times across the industrial belt.

How much land is being acquired for the Talegaon Chakan Shikrapur elevated highway?

The MSIDC DPR specifies 38.79 hectares. State government funding covers this acquisition upfront. No village-level Section 3A notification has been publicly disclosed yet; plots abutting the existing alignment carry risk until that notification is issued.

Can agricultural land near Ranjangaon and Shikrapur be converted to industrial use?

Yes, through PMRDA, which is the sanctioning authority for most of the Shirur taluka belt. Conversion requires an SDO NA order and PMRDA clearance. A broker's verbal assurance of "convertible land" is not a legal conversion. Verify all orders on the 7/12 extract.

What is the difference between MIDC land and freehold land along the Talegaon Chakan road?

MIDC land is leasehold, allotted by Maharashtra Industrial Development Corporation under specific industrial end-use conditions. Freehold land is privately owned and trades freely but still requires NA conversion for non-agricultural construction. Both exist along this corridor.

Is there a Khed City brand fraud risk near Chakan MIDC?

Yes. Khed Logistics Park India LLP has been using the Khed City name without any association with the actual developer, Khed Economic Infrastructure Private Limited. Verify directly with KEIPL before paying any advance on plots marketed as Khed City land.

What is the BOT model for the NH-548D and does it involve tolling?

Yes. MSIDC is executing the project on a build-operate-transfer basis, with financing through toll securitization or loans. Tolling will follow NHAI policy. The DPR also proposed developing the route as a green corridor to generate carbon credits for financial sustainability.

Which Talegaon MIDC phases still have land available?

MIDC has developed 585 hectares in five phases at villages Navlak-Umbre, Akurdi, and Ambi. Phases I and II are fully allotted. Fresh industrial plot availability exists mainly through the MIDC secondary market, which requires MIDC transfer approval and cannot bypass the MILAAP portal process.

Disclaimer

Alignment and corridor information shown here is indicative. Users should verify details with Maharashtra State Road Development Corporation (MSRDC) or relevant highway authorities before any transaction or investment decision.

Talegaon Chakan Shikrapur Corridor is only accessible with Premium Subscription.

Free layer preview
Check 1acre Premium

Data Source & Verification

Source

Official Maharashtra State Road Development Corporation (MSRDC) documents

Official Website

msrdc.in

Coordinate Reference System

EPSG:4326 (WGS 84)

Geometry Type

Polygon / MultiPolygon

Data Format

Vector (GeoJSON) + Raster Tiles

Last Verified

2026

Status

Active
