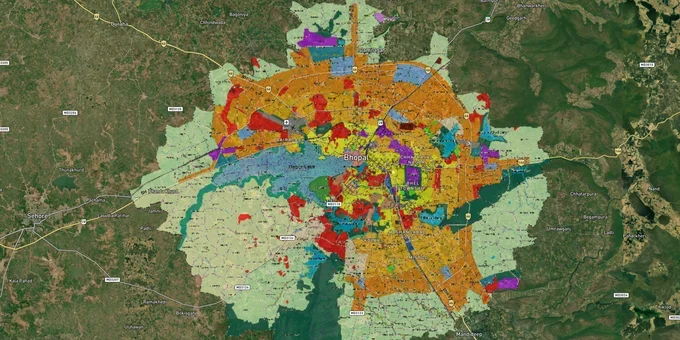

Bhopal Masterplan Preview
Try the Bhopal Masterplan 2031 on the map
Sign in once and explore the layer for a full day.

Bhopal Masterplan Preview
Try the Bhopal Masterplan 2031 on the map
Sign in once with your mobile number and explore the layer for a full day.
The Bhopal masterplan 2031 land zone framework, prepared by the Directorate of Town and Country Planning (DT&CP, widely searched as TNCP Bhopal) under the Madhya Pradesh Nagar Tatha Gram Nivesh Adhiniyam 1973, covers 1,016.90 sq. km across 248 villages. Released as a draft in June 2023 after an 18-year gap, it was meant to replace the expired Bhopal Development Plan (BDP) 2005, but it was never notified. As of October 2026 the state has moved on: a new draft, the Bhopal Development Plan 2047, was released on 26 September 2026 for claims and objections, and until a new plan is approved the BDP 2005 still governs land use. The 2031 draft introduced eight sub-cities, a Transit Oriented Development (TOD) corridor of 100 m width along metro lines, and hard construction bans around Kerwa Dam and Upper Lake catchment areas. Because brokers still quote the 2031 zones, this page explains its zone rules, regulatory traps, and the corridors where zone classification directly affects what you can build and what you cannot, along with the current plan status, the role of TNCP Bhopal, what the 2047 draft proposes and where the official documents are published.
Searches for a Bhopal master plan 2026, or for the latest news on BDP 2031, lead to one answer: there is no 2026 plan, and the 2031 plan never became law. Bhopal's last notified plan is the Bhopal Development Plan 2005, notified in June 1995. A draft plan for 2021 was prepared in August 2009, a draft for 2031 was presented in 2020, and an amended 2031 draft was released in June 2023 with 30 days for claims and objections. The state did not notify it. By February 2024 the government had directed that a new draft be prepared for 2047. The latest update came on 26 September 2026, when the state government released the draft Bhopal Development Plan 2047. It followed a Supreme Court hearing on 22 September 2026 on commercial activity in residential areas. The state has told the court it will not finalise the plan without the court's permission, and the next hearing is listed for 23 November 2026. Until a new plan is approved, the existing master plan and building regulations govern construction.
Plan
Status as of October 2026
What it means for a buyer
BDP 2005 (notified June 1995)
Expired in 2005 but still applied
Land use is still checked against this plan
Draft BDP 2031 (amended draft, June 2023)
Never notified; replaced by the 2047 draft
Zones quoted from it carry no legal force
Draft BDP 2047 (released 26 September 2026)
Claims and objections stage; Supreme Court hearing on 23 November 2026
Proposed zones may change before approval
Plan
Status as of October 2026
What it means for a buyer
BDP 2005 (notified June 1995)
Expired in 2005 but still applied
Land use is still checked against this plan
Draft BDP 2031 (amended draft, June 2023)
Never notified; replaced by the 2047 draft
Zones quoted from it carry no legal force
Draft BDP 2047 (released 26 September 2026)
Claims and objections stage; Supreme Court hearing on 23 November 2026
Proposed zones may change before approval
TNCP Bhopal is the name most people search for the Directorate of Town and Country Planning, Madhya Pradesh (Nagar Tatha Gram Nivesh), the state department headquartered in Bhopal. Under the Madhya Pradesh Nagar Tatha Gram Nivesh Adhiniyam 1973, its Director prepares the development plans for planning areas such as Bhopal. The plan is often called the BDA plan, but it is prepared by the Directorate, not by the Bhopal Development Authority. The department's website is mptownplan.gov.in. An MP TNCP land use map shows each parcel's proposed use by colour and code. In the 2047 draft the codes include RG-1 to RG-5 (residential), CMU-1 to CMU-3 (commercial and mixed use), I-1 and I-2 (industrial), PSP (public and semi-public), G-1 to G-5 (green areas), W/BIZ (water bodies), T (transport) and TOD along the metro. How to read a TNCP Bhopal map before you buy:
Step
What to check
Why it matters
1
Find the khasra number on the revenue map, then the same parcel on the land use plan
The zone applies to the parcel, not the colony name
2
Read the zone colour and code
Green, water body or transport zones cannot be built on
3
Check the road width shown in front of the plot
Mixed use and higher FAR in Bhopal depend on road width
4
Note which plan the map is from: BDP 2005, the 2031 draft or the 2047 draft
Only an approved plan is binding
5
Ask the Town and Country Planning office for a written land use statement
A screenshot or broker's map is not proof
Step
What to check
Why it matters
1
Find the khasra number on the revenue map, then the same parcel on the land use plan
The zone applies to the parcel, not the colony name
2
Read the zone colour and code
Green, water body or transport zones cannot be built on
3
Check the road width shown in front of the plot
Mixed use and higher FAR in Bhopal depend on road width
4
Note which plan the map is from: BDP 2005, the 2031 draft or the 2047 draft
Only an approved plan is binding
5
Ask the Town and Country Planning office for a written land use statement
A screenshot or broker's map is not proof
The draft Bhopal Development Plan 2047 covers an investment area of 1,016.90 sq km and 254 villages, against about 601 sq km and 146 villages under the BDP 2005. It plans for a population of about 45 lakh in three phases: to 2033, 2033 to 2040, and to 2047. It is a draft, so every zone below is a proposal until the plan is approved.
Proposal
Draft BDP 2047
Earlier position
Planning area
1,016.90 sq km, 254 villages
BDP 2005: about 601 sq km, 146 villages
TOD along the metro
500 m on either side of metro corridors
2031 draft: 100 m
Growth corridor
51 km from Narmadapuram Road to Indore Road on a 75 m road, mixed use up to 300 m each side, 1.0 extra FAR free
Not in earlier plans
High-rise FAR
Base 1.50, rising with road width to 4.00 on 60 m roads; no ceiling on 75 m roads
Not set in BDP 2005
Green area
About 27% of the plan
About 16% in the 2005 plan
Roads
About 791 km of proposed roads, 9 m to 75 m wide
—
Bypasses
Outer Bhopal-Bhauri bypass within 10 years; 60 m greenfield bypass with 50 m green zones on both sides
—
Proposal
Draft BDP 2047
Earlier position
Planning area
1,016.90 sq km, 254 villages
BDP 2005: about 601 sq km, 146 villages
TOD along the metro
500 m on either side of metro corridors
2031 draft: 100 m
Growth corridor
51 km from Narmadapuram Road to Indore Road on a 75 m road, mixed use up to 300 m each side, 1.0 extra FAR free
Not in earlier plans
High-rise FAR
Base 1.50, rising with road width to 4.00 on 60 m roads; no ceiling on 75 m roads
Not set in BDP 2005
Green area
About 27% of the plan
About 16% in the 2005 plan
Roads
About 791 km of proposed roads, 9 m to 75 m wide
—
Bypasses
Outer Bhopal-Bhauri bypass within 10 years; 60 m greenfield bypass with 50 m green zones on both sides
—
The draft also lists protection of Bhojtal (Upper Lake) and its catchment, hills, forests, ponds and tiger movement areas, and proposes an Education, Knowledge and AI city in the Bhauri area. Searches for a Bhopal master plan 2047 map usually mean these draft zone maps. Check a plot's khasra against both the plan in force and the draft, and treat any seller's claim of a '2047 zone' as unconfirmed until approval.
1acre does not host the official plan files. Madhya Pradesh development plans are issued by the Directorate of Town and Country Planning (mptownplan.gov.in), and a draft is placed in the public domain for claims and objections before approval. Ask for the notice number and date on any copy you are shown, because older drafts still circulate on messaging apps.
Document
What it contains
Status and where to get it
Bhopal Development Plan 2005
The plan in force: land use map and regulations for about 601 sq km and 146 villages
Notified June 1995; Town and Country Planning, Bhopal
Draft BDP 2031 (amended, June 2023)
Eight sub-cities, 100 m TOD band, Kerwa and Upper Lake bans
Superseded draft; useful only as history
Draft BDP 2047 (September 2026)
Proposed land use for 1,016.90 sq km and 254 villages, road network, FAR rules
Released 26 September 2026 for claims and objections; get the official notice and maps from the department
Document
What it contains
Status and where to get it
Bhopal Development Plan 2005
The plan in force: land use map and regulations for about 601 sq km and 146 villages
Notified June 1995; Town and Country Planning, Bhopal
Draft BDP 2031 (amended, June 2023)
Eight sub-cities, 100 m TOD band, Kerwa and Upper Lake bans
Superseded draft; useful only as history
Draft BDP 2047 (September 2026)
Proposed land use for 1,016.90 sq km and 254 villages, road network, FAR rules
Released 26 September 2026 for claims and objections; get the official notice and maps from the department
A search for a Bhopal master plan 2047 PDF download free download should end at the department's own notice, not a third-party file. The BDP 2005 PDF and map are the documents that still decide land use today. To see where your plot sits, find its khasra number on the 1acre map overlay, note the zone, then confirm it with the Town and Country Planning office before you pay a token.
Two regulatory traps have already caught buyers in Bhopal. Both are written into the draft BDP 2031, and neither is visible without checking the Directorate of Town and Country Planning (DTCP) zone map against the revenue record. The table below shows the four zone types most commonly misread by buyers and brokers in Bhopal.
Zone
Permitted Use
Requires Conversion?
Common Misrepresentation
Residential General (RG)
Residential; mixed use only on 18 m+ roads
Not applicable if already residential zone
Marketed as mixed-use on narrow colony roads
Low Density Residential (LDR)
Low-density residential; Floor Area Ratio (FAR) 1:0.06 (restored from 1:0.75 proposal)
No, but FAR strictly limited
Sold near Kerwa Dam as buildable; construction now banned
Green Belt / Forest
No private construction; even government structures barred near Kaliasot-Kerwa
No conversion permitted
Plots near Ratapani corridor sold as residential
TOD Corridor (100 m along metro)
Mixed use, higher FAR via Premium FAR or Transferable Development Rights (TDR)
No, but additional FAR requires Premium FAR payment or TDR
Marketed as automatic high-FAR zone without premium charge
Zone
Permitted Use
Requires Conversion?
Common Misrepresentation
Residential General (RG)
Residential; mixed use only on 18 m+ roads
Not applicable if already residential zone
Marketed as mixed-use on narrow colony roads
Low Density Residential (LDR)
Low-density residential; Floor Area Ratio (FAR) 1:0.06 (restored from 1:0.75 proposal)
No, but FAR strictly limited
Sold near Kerwa Dam as buildable; construction now banned
Green Belt / Forest
No private construction; even government structures barred near Kaliasot-Kerwa
No conversion permitted
Plots near Ratapani corridor sold as residential
TOD Corridor (100 m along metro)
Mixed use, higher FAR via Premium FAR or Transferable Development Rights (TDR)
No, but additional FAR requires Premium FAR payment or TDR
Marketed as automatic high-FAR zone without premium charge
The first trap is the Kerwa Dam green belt reversal. The draft BDP 2031 initially proposed 51.66 hectares near Kerwa Dam as Low Density Residential. The amended 2031 draft reversed this, retaining it as green belt. Anyone who purchased based on the draft zoning now holds land with zero construction potential. The second trap is agricultural diversion. Buying agricultural land in Bhopal and converting it to residential requires a No Objection Certificate from DT&CP, payment of diversion charges under Section 172(1) of the MP Land Revenue Code 1959, and confirmation that the plot's zone in the masterplan is designated for residential use. Brokers routinely skip the masterplan check and push diversion as a formality. If the zone is green belt or forest, diversion approval will not be granted. Check the DTCP zone map before you sign anything. The 2047 draft, released on 26 September 2026, again lists the protection of Bhojtal and its catchment, forests and tiger movement areas, but its zones remain proposals until the plan is approved. Check the khasra against both the plan in force and the 2047 draft, and expect diversion to be refused wherever either shows green belt, forest or water body.
Two categories of corridor exist in the draft BDP 2031 map: sub-city expansion zones with genuine residential demand, and metro-adjacent TOD corridors where land prices have already moved ahead of infrastructure delivery. The table below shows the five corridors where BDP 2031 zone classification directly drives or restricts land value.
Corridor / Locality
BDP 2031 Zone
Growth Driver
Known Risk
Misrod towards Mandideep
New sub-city designation
Industrial demand from Govindpura, Bagroda, Mandideep within 15 km
Agricultural diversion required before residential development
Karond (Orange Line metro corridor)
TOD Corridor, 100 m either side of metro
Orange Line Priority Corridor (AIIMS to Subhash Nagar, 6.225 km) commercial ops 21 Dec 2025; full Orange Line (14.99 km to Karond) under construction, Phase 1 completion expected 2027; guideline rates proposed up from Rs 15,000 to Rs 50,000 per sq m near metro
Premium FAR payment required for density; not automatic
Narsinghgarh (Airport) Road
New sub-city designation
Airport proximity; new sub-city status in BDP 2031
Infrastructure delivery timeline uncertain
Chola Road corridor
New sub-city designation
Expansion zone between existing BHEL Extension and Misrod sub-cities
Currently underdeveloped; no confirmed infrastructure schedule
Kerwa / Upper Lake buffer
Green Belt / Forest / Wetland
None for residential buyers
Hard construction ban; BDP 2005 LDR reclassification reversed; NTCA flagged tiger corridor status
Corridor / Locality
BDP 2031 Zone
Growth Driver
Known Risk
Misrod towards Mandideep
New sub-city designation
Industrial demand from Govindpura, Bagroda, Mandideep within 15 km
Agricultural diversion required before residential development
Karond (Orange Line metro corridor)
TOD Corridor, 100 m either side of metro
Orange Line Priority Corridor (AIIMS to Subhash Nagar, 6.225 km) commercial ops 21 Dec 2025; full Orange Line (14.99 km to Karond) under construction, Phase 1 completion expected 2027; guideline rates proposed up from Rs 15,000 to Rs 50,000 per sq m near metro
Premium FAR payment required for density; not automatic
Narsinghgarh (Airport) Road
New sub-city designation
Airport proximity; new sub-city status in BDP 2031
Infrastructure delivery timeline uncertain
Chola Road corridor
New sub-city designation
Expansion zone between existing BHEL Extension and Misrod sub-cities
Currently underdeveloped; no confirmed infrastructure schedule
Kerwa / Upper Lake buffer
Green Belt / Forest / Wetland
None for residential buyers
Hard construction ban; BDP 2005 LDR reclassification reversed; NTCA flagged tiger corridor status
The most misunderstood corridor is the metro TOD zone. The BDP 2031 established a 100 m TOD corridor on both sides of metro rail tracks, covering 514.25 hectares. Buyers interpret this as blanket permission for high-density commercial development. It is not. Any FAR above the base residential level in the TOD zone requires either a Premium FAR payment to the authority or TDR credits. Neither is free. Factor that cost before comparing TOD-adjacent land prices with other residential plots. The 2047 draft would change this map if approved. It widens the TOD band to 500 m on either side of metro corridors and adds a 51 km growth corridor from Narmadapuram Road to Indore Road, with mixed use up to 300 m on each side of a 75 m road. Mandideep and Misrod buyers should check both drafts, and treat neither as an entitlement until the plan is notified.
This page is based on official records of the Madhya Pradesh planning process and on established news reports of the September 2026 draft, read in October 2026. The status of BDP 2005 and the earlier drafts comes from the Comptroller and Auditor General's audit of town and country planning. Provisions of the 2047 draft come from news reports of the released draft, because the department's website could not be read for this update. Where a fact could not be confirmed, it was left out.
* Comptroller and Auditor General of India, Report No. 5 of 2025, Management of Town and Country Planning, Madhya Pradesh: BDP 2005 notified June 1995 and still prevailing, draft 2021 (August 2009), 2047 direction * The Pioneer and New Kerala (September 2026): release of the 2047 draft on 26 September 2026, Supreme Court order of 22 September 2026, claims and objections stage * Indian Masterminds (September 2026): area, villages, population and key features of the 2047 draft * Free Press Journal (September and October 2026): TOD width, growth corridor, zones, phases, FAR rules, road network and lake catchment in the 2047 draft; 2020 presentation of the 2031 draft * Free Press Journal (February and July 2024, July 2026) and The Hitavada (June 2023, June 2024): history of the 2031 draft and the shift to 2047 * Plutus IAS current affairs (September 2026): next Supreme Court hearing date
For Land Owners & Agents
I want to sell my land in Madhya Pradesh
10:32
Plz share your Land's location - We will list it on 1acre map, for Free.
10:32

250 Sq yds
2.5 Acres
For Land Buyers
Every listing goes through our Preliminary Verification Process.

View Mandideep Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Mandideep Master ...

View Pithampur Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Pithampur masterp...

View Agra - Gwalior Expressway alignment as a live map overlay – check land acquisition risk and plot proximity free on ...

View Mandideep Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Mandideep Master ...

View Pithampur Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Pithampur masterp...

View Agra - Gwalior Expressway alignment as a live map overlay – check land acquisition risk and plot proximity free on ...
Go to mptownplan.gov.in, enter your survey number and tehsil, and download your land use certificate. Cross-check it against the plan in force (BDP 2005) and the 2047 draft zone map before signing anything, because the BDP 2031 was never notified. For a visual overlay, verify your plot's zone on the 1acre Premium map (1acre.in/subscribe).
Honestly, nothing good for buyers. That land is Green Belt in the amended BDP 2031 draft; the residential classification in the earlier draft was reversed. No construction is permitted there. If a broker is pitching it as residential, ask for a current DTCP certificate first.
Many buyers assume it does, and that's where they get caught. Higher FAR in the metro corridor requires either Premium FAR payment or TDR credits. Without those, only base residential FAR applies. Get the numbers before you get excited about a metro-adjacent plot.
Not easily. The Bhoj Wetland Rules 2022 impose a strict 250-metre buffer around the catchment, and village expansion is capped at 100 metres from existing settlements. Before buying anything near Upper Lake, verify the FTL boundary, surprises here are expensive.
You'll need a No Objection Certificate (NOC) from DT&CP and diversion charges under Section 172(1) of the MP Land Revenue Code. But here's what brokers often skip, if your plot sits in a Green Belt or Forest zone on the masterplan, diversion simply won't happen. Check the zone first, always.
The Orange Line Priority Corridor (AIIMS to Subhash Nagar, 6.225 km) opened for commercial operations in December 2025. The full Orange Line extending to Karond (14.99 km total) is under construction with full Phase 1 completion expected by 2027. Collector guideline rates near Karond have jumped from ₹15,000 to ₹50,000 per sq m. TOD reclassification is doing real work on valuations, but the Karond end of the line remains unbuilt.
Yes, and it tripped up a lot of buyers who assumed mixed-use was freely permitted. The amended BDP 2031 draft required at least an 18-metre road width for any commercial activity in Residential General zones. The earlier 12-metre draft rule was specifically amended to protect colonies like Arera Colony and Vijay Nagar. The 2047 draft also ties mixed use and FAR to road width, so check the road shown in front of the plot.
No, and it will not become official. The amended draft came out in June 2023, but final statutory notification under the MP Nagar Tatha Gram Nivesh Adhiniyam 1973 never happened, and the state released a new draft, the Bhopal Development Plan 2047, on 26 September 2026. As of October 2026 that draft is at the claims and objections stage. Don't base a transaction on zone classifications without confirming the current status directly with DT&CP Bhopal.
TNCP Bhopal is the common name for the Directorate of Town and Country Planning, Madhya Pradesh, headquartered in Bhopal. Under the MP Nagar Tatha Gram Nivesh Adhiniyam 1973 it prepares development plans, including the Bhopal master plan, and its offices issue land use information for a plot. Its website is mptownplan.gov.in. The Bhopal Development Authority does not prepare the master plan.
Official development plans are issued by the Directorate of Town and Country Planning (mptownplan.gov.in) and its Bhopal office; 1acre does not host them. The plan in force is the BDP 2005, notified in June 1995. The draft BDP 2047 was released on 26 September 2026 for claims and objections. Check the notice number and date on any PDF you are sent, since older drafts still circulate.
It is the draft Bhopal Development Plan 2047, released by the state government on 26 September 2026. It covers 1,016.90 sq km and 254 villages, plans for about 45 lakh people, widens the metro TOD band to 500 m on each side and adds a 51 km growth corridor from Narmadapuram Road to Indore Road. It is a draft at the claims and objections stage, not an approved plan.
BDP 2005 is the last notified plan, approved in June 1995 for a horizon of 2005 and still applied because no newer plan has been approved. BDP 2031 was a draft: presented in 2020, amended in June 2023, and never notified. Its 100 m TOD band, sub-cities and Kerwa reclassification never became law. The state has now replaced it with the 2047 draft.
No. There is no plan with a 2026 horizon. In 2026 Bhopal still follows the BDP 2005, and the two later drafts, for 2031 and 2047, have not been approved. The newest is the draft BDP 2047, released on 26 September 2026. When someone quotes a 'new master plan 2026' zone, ask which document it comes from and check the notice date.
Source
Official Directorate of Town and Country Planning (DTCP), Madhya Pradesh documents
Official Website
mptownplan.gov.in
Coordinate Reference System
EPSG:4326 (WGS 84)
Geometry Type
Polygon / MultiPolygon
Data Format
Raster Tiles (from GeoTIFF)
Last Verified
April 2026
Status
Active
