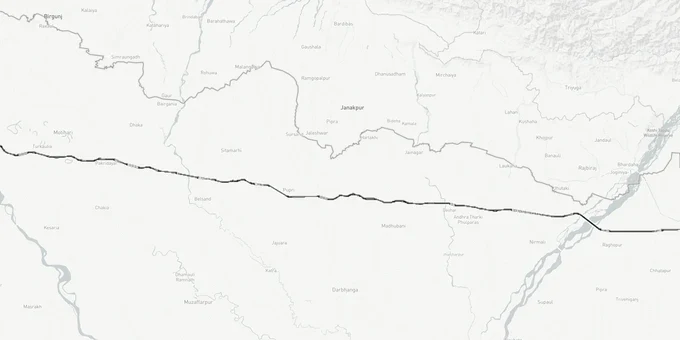

Gorakhpur Siliguri Expressway Preview
Try the Gorakhpur - Siliguri Expressway on the map
Sign in once and explore the layer for a full day.

Gorakhpur Siliguri Expressway Preview
Try the Gorakhpur - Siliguri Expressway on the map
Sign in once with your mobile number and explore the layer for a full day.
The Gorakhpur-Siliguri Expressway is a 525.5-km greenfield corridor under Bharatmala Pariyojana, connecting Gorakhpur in Uttar Pradesh to Siliguri in West Bengal through nine Bihar districts. NHAI (National Highways Authority of India) is the executing authority; LN Malviya Infra Projects prepared the DPR. Gazette notifications for land acquisition are active across all three states. Bihar tenders were floated in September 2025. Full-scale construction is expected to commence 2026 across Bihar packages. Phase 1 (UP to Bihar border) is furthest advanced. Target completion remains 2028. This Premium layer on 1acre maps the alignment as submitted in the DPR. Use it to verify whether a plot sits inside or outside the notified corridor before any transaction.
A route revision in October 2025 incorporated a 72 km stretch through Kishanganj district. Buyers near Kishanganj must verify their khasra number against the revised alignment — not the original DPR — before any transaction.
The Right of Way for this expressway is 100 meters. That band is under compulsory acquisition under the National Highways Act, 1956. In Bihar, NHAI has formally gazetted acquisition across four districts as the first wave. In Uttar Pradesh, acquisition began in May 2022 across 111 villages in Gorakhpur, Deoria, and Kushinagar. Any plot inside this corridor is not a purchase; it becomes a government compensation claim at rates assessed by the District Land Acquisition Officer.
The table below shows what the notified NHAI DPR alignment corridor covers across each state:
State
Stretch
Districts in ROW
ROW Width
Acquisition Status
Uttar Pradesh
84.3 km
Gorakhpur, Deoria, Kushinagar
60-100 m
Active since May 2022
Bihar
~417 km
W. Champaran, E. Champaran, Sheohar, Sitamarhi, Madhubani, Supaul, Araria, Kishanganj
100 m
NHAI Gazette issued
West Bengal
~19 km
Darjeeling (Siliguri)
100 m
Under process
State
Stretch
Districts in ROW
ROW Width
Acquisition Status
Uttar Pradesh
84.3 km
Gorakhpur, Deoria, Kushinagar
60-100 m
Active since May 2022
Bihar
~417 km
W. Champaran, E. Champaran, Sheohar, Sitamarhi, Madhubani, Supaul, Araria, Kishanganj
100 m
NHAI Gazette issued
West Bengal
~19 km
Darjeeling (Siliguri)
100 m
Under process
The most consequential problem for buyers is this: NHAI has not published the DPR alignment map online. There is no downloadable, village-level survey map on any official NHAI portal. Brokers selling plots in Sitamarhi, Darbhanga, or Kushinagar as "adjacent to the expressway" cannot confirm whether a specific khasra number falls inside or outside the 100-meter notified band without an official Section 3D notice under the National Highways Act. Approximately 87.5 percent of all land being acquired is agricultural, and once a gazette notification is served on a survey number, that land cannot be legally resold by the original owner. Cross-check the 1acre alignment layer against your plot's coordinates and demand the Section 3D notice before signing any agreement.
The alignment runs through agricultural territory parallel to the India-Nepal border. The opportunity outside the ROW is real, but the timeline is not confirmed. Construction has not commenced on most Bihar packages as of 2025. Buying farmland in Supaul or Forbesganj based on a 2028 opening is a speculative position; the Kushinagar and Gorakhpur stretches in UP, where acquisition is furthest along, carry the most credible near-term signal.
The following table covers the principal micro-markets along the Gorakhpur Siliguri Expressway route and what each district offers for land buyers:
District / Locality
State
Connectivity Gain
Land Market Signal
Gorakhpur (Chaurichaura tehsil)
UP
Junction with NH-27 and Purvanchal network
Near-term; infrastructure active
Kushinagar (Hata, Tamukhiraj tehsils)
UP
Tourism corridor plus expressway intersection
Land-use change possible; monitor
Deoria
UP
Entry point to Bihar stretch
Agricultural base; limited near-term driver
Darbhanga
Bihar
Breaks isolation of Mithila belt
High speculative interest; no construction yet
Sitamarhi
Bihar
Near Nepal border; cross-border trade benefit
Early stage; long horizon
Forbesganj, Kishanganj
Bihar
Bihar-Bengal junction
Undeveloped; high-risk for short-term buyers
Siliguri (Darjeeling district)
West Bengal
Existing trade hub; expressway terminus
Established market; incremental uplift only
District / Locality
State
Connectivity Gain
Land Market Signal
Gorakhpur (Chaurichaura tehsil)
UP
Junction with NH-27 and Purvanchal network
Near-term; infrastructure active
Kushinagar (Hata, Tamukhiraj tehsils)
UP
Tourism corridor plus expressway intersection
Land-use change possible; monitor
Deoria
UP
Entry point to Bihar stretch
Agricultural base; limited near-term driver
Darbhanga
Bihar
Breaks isolation of Mithila belt
High speculative interest; no construction yet
Sitamarhi
Bihar
Near Nepal border; cross-border trade benefit
Early stage; long horizon
Forbesganj, Kishanganj
Bihar
Bihar-Bengal junction
Undeveloped; high-risk for short-term buyers
Siliguri (Darjeeling district)
West Bengal
Existing trade hub; expressway terminus
Established market; incremental uplift only
Darbhanga draws the most investor attention in current coverage, and for logical reasons: the Mithila belt has been connectivity-starved for decades. But that same logic has been used to sell speculative farmland there for two years before a single package goes to construction. The Kushinagar and Deoria exits are closer to confirmed activity and connect into the broader UP expressway network, making them the more grounded choice for buyers who need a shorter investment window.
For Land Owners & Agents
I want to sell my land in Bihar
10:32
Plz share your Land's location - We will list it on 1acre map, for Free.
10:32

250 Sq yds
2.5 Acres
For Land Buyers
Every listing goes through our Preliminary Verification Process.

View Patna Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Patna masterplan land...

Package 4 runs 42.21 km from Balbhadarpur to Bela Nawada on NH-119D. Gazette status and the Darbhanga land checks that m...

82.4 km NHAI greenfield corridor from Mokama to Munger via Lakhisarai. Acquisition status, Bihar mutation checks and val...

View Patna Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Patna masterplan land...

Package 4 runs 42.21 km from Balbhadarpur to Bela Nawada on NH-119D. Gazette status and the Darbhanga land checks that m...

82.4 km NHAI greenfield corridor from Mokama to Munger via Lakhisarai. Acquisition status, Bihar mutation checks and val...
It passes through Gorakhpur, Deoria, and Kushinagar in UP; nine Bihar districts including West Champaran, Sitamarhi, Darbhanga, Madhubani, Supaul, and Kishanganj; and terminates in Siliguri in West Bengal's Darjeeling district. Bihar accounts for roughly 417 of the 525 km.
Only outside the notified 100-meter ROW. Land inside the corridor is under compulsory acquisition. Demand the Section 3D NHAI notification for your specific khasra number. No official alignment map is publicly available from NHAI's website.
Use 1acre's Premium map layer (https://1acre.in/subscribe) to cross-check the alignment against your plot's coordinates before demanding the Section 3D notice.
The expressway is 525.5 km long. As per 2025 NHAI estimates, total project cost is Rs 38,645 crore. Land acquisition alone covers 5,503 hectares at an estimated Rs 12,094 crore. Civil cost, excluding GST, is Rs 22,547 crore.
NHAI targets 2028. Bihar tenders were floated in September 2025 and full-scale construction is expected to commence 2026. A route revision in October 2025 incorporated a 72 km stretch through Kishanganj — verify against the revised alignment, not the original DPR. Completion timelines for greenfield projects of this scale routinely extend beyond initial targets.
The notified ROW is 100 meters. In UP, acquired land widths varied between 60 and 100 meters depending on the section. Roughly 87.5 percent of all land required across the alignment is classified as agricultural.
Yes. The Gorakhpur Siliguri Expressway is part of Bharatmala Pariyojana Phase 2, proposed by the Ministry of Road Transport and Highways in 2021. NHAI is the executing authority. EPC (Engineering, Procurement and Construction) mode construction is planned across five packages.
LN Malviya Infra Projects Private Limited, a Bhopal-based firm, prepared the Detailed Project Report. NHAI has not released this DPR for public download, which is a key gap for buyers trying to verify plot positions against the alignment.
West Champaran, East Champaran, Sheohar, and Sitamarhi were the first four Bihar districts for which NHAI formally issued gazette notifications. Araria, Supaul, Madhubani, and Kishanganj follow in subsequent acquisition packages.
