Overview

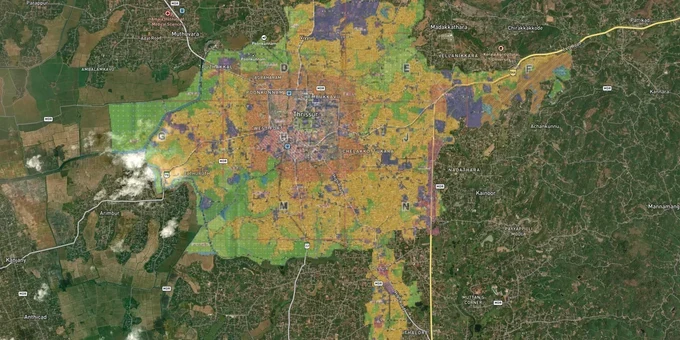

Thrissur Masterplan 2039, prepared under the Kerala Town and Country Planning Act 2016, was sanctioned by the Government vide GO(MS) 59/2021/LSGD and gazetted on 26 February 2021. Governing a 101.42 sq km Municipal Corporation area administered through five zones, Ayyanthole, Vilvattom, Ollukkara, Ollur and Koorkanchery, the plan introduces zone classifications including commercial core zone, decongestion core zone and residential zone. A separate AMRUT-funded update was approved by the Corporation Council in October 2023 and awaits final government sanction.

Why Thrissur's Unrevoked DTP Schemes Can Block Your Building Permit Even Under the 2039 Plan

The biggest trap in Thrissur is not knowing that two planning regimes operate simultaneously. The master plan gazetted on 26 February 2021 did not expressly cancel the older Detailed Town Planning (DTP) Schemes. This creates a situation confirmed in Kerala High Court WPC 3573/2024, where a property falling under commercial core zone in the 2021 master plan was still being blocked by the Corporation citing an older residential zone classification under a pre-existing DTP Scheme. The Court directed the Corporation to reconsider the permit using the sanctioned 2021 plan, not the superseded DTP Scheme.

This conflict is not a one-off. The Court in WP(C) 19523/2013 had found that DTP Schemes drawn up decades earlier were being used to deny building permits despite the schemes never being implemented, and properties in the area having developed commercially in the interim. The Supreme Court and Kerala High Court have both held that refusing permits on the basis of unimplemented, obsolete DTP Schemes violates constitutional principles. Even so, the Corporation offices continue applying DTP zones unless a buyer pushes back with the correct documents. The table below sets out the key zone categories in the Thrissur Masterplan 2039 and what matters in each.

Zone

Nature

Key Rule

Conflict Risk

Commercial Core Zone

Central commercial area, Swaraj Round vicinity

Commercial use permitted; DTP restrictions must not override

High: old DTP Schemes show parts as residential

Decongestion Core Zone

Fringe of commercial core, mixed use

Mixed use allowed; decongestion proposals in Chapter 29 of plan

Medium

Residential Zone

General residential areas across the corporation

Residential construction primary; check DTP overlay

Medium

Paddy Zone (legacy DTP)

Marked in older DTP Schemes over wetlands

Building may be restricted or require clearance from local agriculture committee

High: frequently invoked to deny permits

Before any purchase inside Thrissur Municipal Corporation, ask the vendor for two documents: the zone in the gazetted 2021 master plan and the DTP Scheme classification if the property falls inside a legacy DTP area. If those two conflict, you will face a building permit dispute even if the master plan allows your intended use.

Ayyanthole, Punkunnam and Koorkanchery: Where Masterplan 2039 Zones Meet Thrissur's Fastest-Appreciating Corridors

Thrissur Municipal Corporation manages its 55 wards through five administrative zones. The real estate market mirrors that structure precisely. Ayyanthole, the zone containing the District Town Planner's office, is among the highest-demand localities, with luxury housing priced between Rs 8,000 and Rs 12,000 per sq ft in 2025. Punkunnam and Swaraj Round are the primary commercial core areas, with commercial property prices ranging from Rs 10,000 to Rs 15,000 per sq ft. Koorkanchery and East Fort deliver strong rental returns on commercial plots.

The table below maps the key corridors against their position in the Masterplan 2039 and the primary buyer risk in each.

Locality / Corridor

Corporation Zone

Masterplan 2039 Classification

Primary Risk

Swaraj Round / East Fort

Central

Commercial core zone

Legacy DTP overlay may still restrict specific plots

Punkunnam

Ayyanthole zone

Commercial / residential fringe

DTP scheme conflict in pockets; verify both documents

Ayyanthole

Ayyanthole zone

Predominantly residential zone

High land scarcity; limited large-scale development

Koorkanchery

Koorkanchery zone

Mixed: residential and commercial

AMRUT 2039 update may shift zone boundaries

Ollukkara / Mannuthy

Ollukkara zone

Residential zone

Paddy zone classifications under legacy DTP in parts

Ollur (Vilvattom fringe)

Ollur / Vilvattom

Residential zone

Paddy zone / wetland DTP restrictions active

The most misunderstood corridor is Punkunnam. Buyers see it as a commercial zone because of the density of retail and business activity. But parts of Punkunnam sit in areas where older DTP Schemes retain residential classifications. The Kerala High Court has dealt with exactly this situation in Punkunnam-area petitions involving Kalyan Jewellers. The High Court held in WP(C) 36069/2016 that corporations cannot use an unimplemented 28-year-old DTP Scheme to block a permit in an area that has demonstrably developed commercially. Even so, the Corporation does invoke it. Get the zone under both the 2021 gazette and the applicable DTP Scheme, and if they conflict, have your architect flag it before the sale agreement is signed.

Was this layer helpful?

Anything wrong, outdated, or missing we want to hear it.

For Land Owners & Agents

Looking to sell your land in Kerala?

I want to sell my land in Kannur

10:32

Plz share your Land's location - We will list it on 1acre map, for Free.

10:32

For Land Buyers

Browse all verified lands & plots in Kerala

View on Map

Every listing goes through our Preliminary Verification Process.

Frequently Asked Questions
