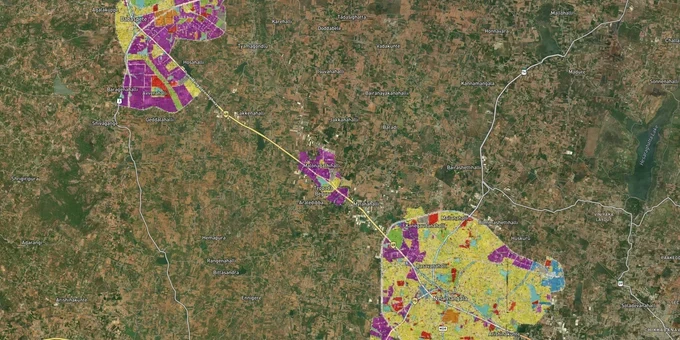

Nelamangala Masterplan Preview
Try the Nelamangala Masterplan 2031 on the map
Sign in once and explore the layer for a full day.

Nelamangala Masterplan Preview
Try the Nelamangala Masterplan 2031 on the map
Sign in once with your mobile number and explore the layer for a full day.
The Nelamangala LPA masterplan zone governs all land use in one of Bengaluru's fastest-growing western corridors. The Nelamangala LPA Masterplan 2031, provisionally approved by the Bangalore Metropolitan Region Development Authority under G.O. No. UDD 150 BMR 2013, divides the local planning area into nine use zones, each with distinct permitted uses, FAR limits, and conversion requirements under the Karnataka Town and Country Planning Act, 1961. This page covers the zone classification system, the regulatory traps that catch buyers in this corridor, and the micro-markets where the plan creates or destroys land value.
Nelamangala is a taluk headquarters north-west of Bengaluru on NH-48, the Bengaluru-Tumakuru highway. In July 2025 the Karnataka cabinet approved renaming Bengaluru Rural district, which includes the taluk, as Bengaluru North. The Nelamangala map that matters for a land purchase is not the road map but the approved land use map of the Nelamangala LPA Masterplan 2031.
The masterplan map has three layers of information a buyer needs to read together:
Map element
What it shows
What to check
Land use zones
Residential, commercial, industrial, agricultural, parks and other zones, each in its own colour
The formal zone name for your survey number, not the colour a broker describes
Phasing
Land planned for development in Phase I and Phase II
Phase II land cannot receive a non-agricultural NOC in the current plan period
Proposed road network
Existing and proposed roads, including ring road and bypass links, with planned widths
Whether a proposed road crosses the plot and how much land it reserves
Map element
What it shows
What to check
Land use zones
Residential, commercial, industrial, agricultural, parks and other zones, each in its own colour
The formal zone name for your survey number, not the colour a broker describes
Phasing
Land planned for development in Phase I and Phase II
Phase II land cannot receive a non-agricultural NOC in the current plan period
Proposed road network
Existing and proposed roads, including ring road and bypass links, with planned widths
Whether a proposed road crosses the plot and how much land it reserves
The road map view helps with access: whether the plot sits on NH-48, on a feeder road or on a proposed road that does not exist on the ground yet. Road width also sets FAR, so the planned width shown on the masterplan affects what can be built.
On the 1acre map, the Nelamangala Masterplan layer can be viewed over satellite imagery with the survey number layer, so the zone, phase and road reservation for a survey number can be read in one place. Treat the overlay as a guide and confirm the zone with a certified extract from the Nelamangala Planning Authority before payment.
The single most expensive mistake buyers make in the Nelamangala LPA is treating every yellow-colored parcel on a broker's map as immediately buildable. The masterplan is unambiguous: no change of land use is permissible in the Agricultural Zone under Section 14-A of the KTCP Act, 1961, and no approvals for development or no-objection certificates for conversion to non-agricultural use are permissible in Phase II urbanizable areas, which cover land planned for development only between 2021 and 2031. A broker showing you a site inside Phase II as "ready for layout" is showing you something that does not legally exist yet.
This is not a theoretical risk. In August 2025, the Karnataka Revenue Department identified approximately 30,340 suspected illegal layout cases statewide. Investigations confirmed that officials collaborated with landowners to bypass conversion requirements by using 11E maps issued without actual conversion, later patched through land record corrections called "phodi durasthi." Several officials have been suspended. Separately, a Karnataka housing cooperative was implicated in a Rs 316-crore scam with announced layouts in Nelamangala, Varthur, and Devanahalli. And in W.P. No. 21648 of 2024, the Karnataka High Court found that converted land not forming part of an approved layout cannot receive an e-Khata, even if the owner holds a conversion order and has paid property tax for years.
The table below summarises the Nelamangala LPA Masterplan 2031 zone codes and what a buyer can and cannot do in each.
Zone
Permitted as-of-right
Requires DC conversion?
Key restriction
Residential
Plots, villas, apartments, group housing (min. 1 ha)
Yes, from agriculture
Hospitals need min. 750 sq m and 12 m road
Commercial
All residential uses plus offices, retail, warehouses, multiplexes
Yes, from agriculture
Mezzanine permitted on commercial only
Industrial
All industries including IT/BT; 40% residential quarters allowed for 10+ ha sites
Yes, from agriculture
KSPCB clearance required for obnoxious industries
Agricultural (Phase I)
Farmhouses up to 200 sq m plinth within 1.2 ha minimum plot
Not required for agricultural use
No layout or CLU in this zone
Agricultural (Phase II)
Agriculture only
No NOC for any non-agricultural development permitted
Do not purchase for residential/industrial development
Parks and Open Spaces
Parks, playgrounds; ancillary uses max 5% of area, G+1 only
N/A
30 m no-development buffer around lakes of 10 ha and above; 9 m around Raj Kaluves
Zone
Permitted as-of-right
Requires DC conversion?
Key restriction
Residential
Plots, villas, apartments, group housing (min. 1 ha)
Yes, from agriculture
Hospitals need min. 750 sq m and 12 m road
Commercial
All residential uses plus offices, retail, warehouses, multiplexes
Yes, from agriculture
Mezzanine permitted on commercial only
Industrial
All industries including IT/BT; 40% residential quarters allowed for 10+ ha sites
Yes, from agriculture
KSPCB clearance required for obnoxious industries
Agricultural (Phase I)
Farmhouses up to 200 sq m plinth within 1.2 ha minimum plot
Not required for agricultural use
No layout or CLU in this zone
Agricultural (Phase II)
Agriculture only
No NOC for any non-agricultural development permitted
Do not purchase for residential/industrial development
Parks and Open Spaces
Parks, playgrounds; ancillary uses max 5% of area, G+1 only
N/A
30 m no-development buffer around lakes of 10 ha and above; 9 m around Raj Kaluves
DC conversion for non-agricultural use is mandatory under Section 95 of the Karnataka Land Revenue Act. Under the 2025 amendments to that Act, misuse of conversion orders now attracts cancellation, land confiscation, and fines of up to Rs 1 lakh plus Rs 2,500 per day, recorded as an encumbrance on the RTC extract. If a seller cannot show you a dated conversion order cross-referenced against the actual survey number on the masterplan map, the transaction is not ready to proceed.
The masterplan shapes value very differently across the LPA. Three corridors account for most of the legitimate buyer activity in Nelamangala today.
The NH-48 (Tumkur Road) corridor running through Arasinakunte and Adarsh Nagar carries the highest concentration of BMRDA and NPA-approved residential layout activity. Most developer projects here are in the Residential Zone, priced between Rs 3,649 and Rs 6,099 per sq ft as of late 2025. The FAR for residential use on roads over 9 m and up to 12 m wide is 1.75, rising to 2.0 on roads over 12 m. Group housing on plots above 1 ha requires a minimum 12 m approach road, 15% civic amenity reservation, and FAR calculated only on net area after deducting that reservation.
The Industrial Zone along NH-48 near Dobbaspet attracts logistics, warehousing, and manufacturing buyers. Industrial plots here were listed at Rs 2.5 crore per 10,000 sq ft unit as of 2024. The plan permits IT/BT industries on plots above 5 ha in the Industrial Zone to allocate 30% of area to residential apartments for employees, subject to KSPCB clearance. The Chennai-Bangalore-Chitradurga Industrial Corridor, where it falls within the LPA, is explicitly recognised in the masterplan as a permitted development.
The third corridor is the STRR alignment. The 288-km Bengaluru Satellite Town Ring Road (NH-948A) lists Nelamangala as a node. The 80-km Dobbaspet-Hoskote section was inaugurated by PM Modi on 11 March 2024, with tolling operational from June 2024. Land along the Dobbaspet-Nelamangala-Bidadi stretch, a 43-km STRR section, is attracting logistics and land banking interest. Land prices in Nelamangala are reported to be growing at 22% year-on-year, with entry-level site pricing around Rs 5,500 per sq ft, the lowest among the STRR nodes. A proposed airport on the Nelamangala-Kunigal Road, if confirmed, could produce a sharp step-change in values, but as of March 2026 no official notification has been issued.
Corridor
Zone classification
Current price range
Infrastructure & economic drivers
Key risk
Arasinakunte / Adarsh Nagar (NH-48)
Residential
Rs 3,600–6,100/sq ft
BMRDA-approved plotted development
Unsanctioned layouts adjacent to approved ones
Dobbaspet industrial belt
Industrial
Rs 2–2.5 Cr per 10,000 sq ft
Logistics, warehousing, STRR node
KSPCB clearances; agricultural zone parcels intermixed
NH-48/STRR junction
Mixed (residential and agricultural phase I transition)
Rs 5,500/sq ft average
STRR connectivity, proposed airport
Phase II land sold as buildable; visit site in monsoon to check drainage
Corridor
Zone classification
Current price range
Infrastructure & economic drivers
Key risk
Arasinakunte / Adarsh Nagar (NH-48)
Residential
Rs 3,600–6,100/sq ft
BMRDA-approved plotted development
Unsanctioned layouts adjacent to approved ones
Dobbaspet industrial belt
Industrial
Rs 2–2.5 Cr per 10,000 sq ft
Logistics, warehousing, STRR node
KSPCB clearances; agricultural zone parcels intermixed
NH-48/STRR junction
Mixed (residential and agricultural phase I transition)
Rs 5,500/sq ft average
STRR connectivity, proposed airport
Phase II land sold as buildable; visit site in monsoon to check drainage
The Nelamangala-Sondekoppa Road corridor is emerging, with layouts citing its expressway-like upgrade, but civic infrastructure on feeder roads varies sharply by exact location. Do not evaluate a Nelamangala site from satellite imagery alone: roads that look developed in summer can reveal flooding and drainage failures in the monsoon.
Searches for the Nelamangala bypass and the Nelamangala ring road plan cover two different kinds of road: proposals drawn on the masterplan, and national highway projects that carry through traffic around the town. They have very different legal weight for a buyer.
The town ring road and bypass links on the Nelamangala LPA Masterplan 2031 are planning proposals. A proposed road on the masterplan reserves a corridor of a set width, and building permission inside that width can be refused. A proposal on the plan is not a land acquisition notice, a sanctioned project or a construction contract.
The national highway projects around Nelamangala are at different stages:
Road
What it is
Status
Nelamangala town ring road and bypass (masterplan)
Proposed roads in the LPA Masterplan 2031
Plan proposals; check the alignment and width on the approved map
NH-48 Nelamangala-Tumakuru
Widening of the 44.04-km highway announced in November 2022, about ₹844 crore
Announced under Bharatmala Pariyojana; confirm current progress with NHAI
STRR (NH-948A) Dobbaspet-Hoskote
80-km eastern section
Inaugurated in March 2024
STRR (NH-948A) Obalapura (Nelamangala taluk) to Kunigal
79-km six-lane section
On NHAI's list of projects awaiting award, as on 1 March 2026
STRR (NH-948A) Dobbaspet to Magadi
46.3-km four-lane package
On NHAI's list of projects awaiting award, as on 1 March 2026
Road
What it is
Status
Nelamangala town ring road and bypass (masterplan)
Proposed roads in the LPA Masterplan 2031
Plan proposals; check the alignment and width on the approved map
NH-48 Nelamangala-Tumakuru
Widening of the 44.04-km highway announced in November 2022, about ₹844 crore
Announced under Bharatmala Pariyojana; confirm current progress with NHAI
STRR (NH-948A) Dobbaspet-Hoskote
80-km eastern section
Inaugurated in March 2024
STRR (NH-948A) Obalapura (Nelamangala taluk) to Kunigal
79-km six-lane section
On NHAI's list of projects awaiting award, as on 1 March 2026
STRR (NH-948A) Dobbaspet to Magadi
46.3-km four-lane package
On NHAI's list of projects awaiting award, as on 1 March 2026
For a plot near any of these, check two things. First, whether a proposed masterplan road crosses the survey number, because the reserved strip cannot be built on. Second, whether a highway project has reached land acquisition, because a notified plot will be acquired at the government rate. The ring road plan PDF that searchers ask for is part of the approved masterplan maps held by the Nelamangala Planning Authority.
The Nelamangala Planning Authority (NPA) is the local planning authority for the Nelamangala Local Planning Area. It is one of the planning authorities that work under the Bangalore Metropolitan Region Development Authority (BMRDA). There is no separate Nelamangala development authority: buyers searching for one usually mean the NPA.
The NPA prepares and enforces the Nelamangala LPA Masterplan 2031 under the Karnataka Town and Country Planning Act, 1961. In practice, the NPA handles:
Function
What it means for a buyer
Masterplan and zoning
Certifies which zone and phase a survey number falls in
Layout approval
Approves residential and other layouts within the LPA
Change of land use
Processes requests to change a zone where the rules allow it
Building plan approval
Approves building plans where it is the sanctioning authority
Function
What it means for a buyer
Masterplan and zoning
Certifies which zone and phase a survey number falls in
Layout approval
Approves residential and other layouts within the LPA
Change of land use
Processes requests to change a zone where the rules allow it
Building plan approval
Approves building plans where it is the sanctioning authority
Land along the Satellite Town Ring Road can sit with a different body. BMRDA has a separate Satellite Town Ring Road Planning Authority (STRRPA); in the neighbouring Anekal LPA, 47 villages were transferred to it. Before relying on the Nelamangala masterplan, confirm whether your village is planned by the NPA or the STRRPA.
To get the Nelamangala master plan 2031 PDF or the CDP plan, ask the NPA office for the approved land use map, the zoning regulations and the approval order. Many buyers and officials still call the masterplan the CDP (Comprehensive Development Plan). A certified extract for your survey number is more useful in a transaction than a full-plan PDF downloaded from an unofficial site.

Boundaries and numbers come from published state cadastral records. See all map layers.

View Anekal Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Anekal masterplan zo...

View Bengaluru Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Bengaluru BDA mas...

View Bengaluru Masterplan - Roads alignment as a live map overlay – check road corridor and land impact free on 1acre.in...

View Anekal Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Anekal masterplan zo...

View Bengaluru Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Bengaluru BDA mas...

View Bengaluru Masterplan - Roads alignment as a live map overlay – check road corridor and land impact free on 1acre.in...
The Nelamangala LPA Masterplan 2031 is provisionally approved by BMRDA under the Karnataka Town and Country Planning Act, 1961. The Nelamangala Planning Authority handles layout approvals and zoning queries. BMRDA handles appeals. Gram panchayats have no authority here. Check your survey number's zone on 1acre Premium.
Agricultural land in a Residential or Commercial zone on the Nelamangala Masterplan 2031 map is automatically treated as converted for non-agricultural use under the Karnataka Land Revenue (Amendment) Rules, 2025 — the owner can proceed directly to layout approval from the Nelamangala Planning Authority without a separate DC conversion step. Land classified in the Agricultural Zone (non-urbanisable areas) cannot be converted at all; no layout or CLU application will succeed here. Phase II land on the phasing map cannot receive any non-agricultural NOC during the current plan period. Always verify which zone and which phase your specific survey number falls in before any commitment.
Verify the RTC extract, DC conversion order (note: for plots already in a residential or commercial zone on the masterplan map, automatic conversion under the Karnataka Land Revenue (Amendment) Rules, 2025 may apply — verify with the Nelamangala Planning Authority), layout approval from BMRDA or the Nelamangala Planning Authority, A-Khata or e-Khata from the local body, and an encumbrance certificate going back at least 15 years from the sub-registrar.
FAR ranges from 1.50 on roads up to 9 m wide to 2.50 on roads over 24 m under the Nelamangala LPA Masterplan 2031 zoning regulations — FAR scales directly with the width of the approach road abutting the plot. Group housing is permitted on plots of 1 ha or more; a minimum 12 m approach road is required for group housing access, and FAR applies as per the standard road-width table. Always confirm the actual road width at the time of sanction, not the proposed width.
The Dobbaspet–Hoskote STRR section opened in March 2024. The Dobbaspet node is zoned Industrial and Logistics in the Nelamangala LPA Masterplan 2031 — not residential — so buyers expecting residential appreciation in this specific corridor should check their survey number carefully before proceeding. Agricultural and Phase II land adjacent to the node is actively mislabelled by brokers as buildable; the zone classification of the exact survey number is the only reliable indicator. Check your survey number's zone on 1acre Premium.
It is informal broker terminology for the Residential Zone on the masterplan colour map. It has no legal standing. The KTCP Act uses zone names, not colours. Always confirm the formal zone name in the official zoning regulations document.
Under the Karnataka Land Revenue (Amendment) Rules, 2025 (notified 17 September 2025), penalties include conversion order cancellation, land forfeiture, fines up to Rs 1 lakh plus Rs 2,500 per day for continued violations, and potential criminal prosecution under the Bharatiya Nyaya Sanhita 2023.
Yes. On the 1acre map, you can load the Nelamangala Masterplan layer and the Survey Number layer together. This lets you see, at any location, both the masterplan zone and the individual survey numbers overlaid on satellite imagery — so you know exactly which zone your survey number falls in before committing. Both layers are available with a Premium subscription. Subscribe to 1acre Premium.
The approved Nelamangala LPA Masterplan 2031 maps and zoning regulations are held by the Nelamangala Planning Authority, which works under BMRDA. Ask the NPA office for the land use map, phasing map and zoning regulations, or for a certified zone extract for your survey number. Copies on property websites may be outdated or incomplete, so do not rely on them in a transaction.
CDP stands for Comprehensive Development Plan, a term still widely used for the masterplan in Karnataka. For Nelamangala, it refers to the Nelamangala LPA Masterplan 2031 prepared under the Karnataka Town and Country Planning Act, 1961. It sets the land use zone, phasing and planned road widths for every survey number in the local planning area.
No. The planning body for Nelamangala is the Nelamangala Planning Authority (NPA), one of the local planning authorities under BMRDA. It prepares and enforces the masterplan and approves layouts in the local planning area. Some villages along the Satellite Town Ring Road may be planned by the separate STRR Planning Authority instead, so confirm which body covers your village.
Only in part. The 80-km Dobbaspet-Hoskote section opened in March 2024. As on 1 March 2026, NHAI listed the Obalapura (Nelamangala taluk) to Kunigal section and the Dobbaspet to Magadi package among projects still awaiting award. Land near these sections is a long-term bet, and plots inside a notified alignment will be acquired.
Source
Official Nelamangala Local Planning Authority (under BMRDA) documents
Official Website
nelamangala.tpa.gov.in
Coordinate Reference System
EPSG:4326 (WGS 84)
Geometry Type
Polygon / MultiPolygon
Data Format
Vector (GeoJSON) + Raster Tiles
Last Verified
April 2026
Status
Active
Anything wrong, outdated, or missing we want to hear it.
