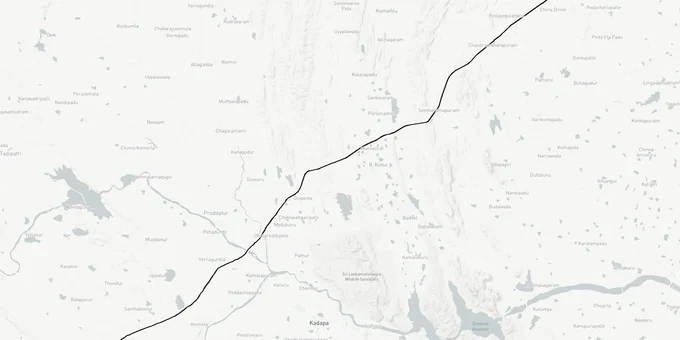

The Bengaluru Vijayawada Expressway (NH-544G) spans a total of 624 km, comprising a 343 km greenfield core from Kodikonda to Addanki and approximately 281 km of brownfield upgrades connecting Bengaluru and Vijayawada at either end. It is a 4-6 lane access-controlled greenfield-plus-brownfield highway notified as NH-544G under Bharatmala Pariyojana Phase I. It runs from Kodikonda on NH-44 in Sri Sathya Sai district to Addanki on NH-16 in Bapatla district, with a 343 km greenfield core from Kodikonda to Addanki across Anantapur, YSR Kadapa, SPS Nellore, and Prakasam. NHAI (National Highways Authority of India) awarded all 14 construction packages by February 2023. Prime Minister Modi laid the foundation stone on 11 March 2024 and the project is targeted for completion by 2026/27. This page plots the alignment as per the DPR. Its start and end points, the route in order and the latest dated update for each stretch, as of October 2026, are set out below. In January 2026, the contractor Rajpath Infracon began a set of Guinness World Record attempts on Package 2, between Vanavolu and Vankarakunta near Puttaparthi in Andhra Pradesh, including a continuous 52 km bituminous stretch laid over seven days. In October 2026 it presented the memento for four Guinness World Records, achieved while building the corridor, to the Sri Sathya Sai district collector. The project is also known as the BKV (Bengaluru-Kadapa-Vijayawada) Expressway.
NH-544G starts at Kodikonda (Kodur) on NH-44 in Sri Sathya Sai district of Andhra Pradesh, where a trumpet interchange at km 0+280 links it to the Bengaluru-Hyderabad highway near Koduru Thopu. The greenfield expressway ends at Muppavaram near Addanki, at km 343.24, where it meets NH-16. Bengaluru and Vijayawada are reached over the existing national highways at either end. The table gives the Bangalore to Vijayawada express highway route map in order, using the package sections NHAI awarded in 2023. For the Vijayawada to Bangalore route, read it from the bottom up.
Order
Point or section
District
Road
1
Bengaluru
Bengaluru, Karnataka
Existing NH-44 north
2
Chikkaballapur
Chikkaballapura, Karnataka
Existing NH-44
3
Kodikonda (Kodur), km 0
Sri Sathya Sai, AP
NH-544G starts; interchange with NH-44
4
Vanavolu to Vankarakunta, km 24.3 to 45.7
Sri Sathya Sai
Package 2, near Puttaparthi
5
Vankarakunta to Kavulakuntla, km 45.7 to 196.0
YSR Kadapa
Packages 3 to 8
6
Kavulakuntla to Narayanampet, km 196.0 to 203.5
SPS Nellore
Package 9
7
Narayanampet to Somavarappadu, km 203.5 to 314.6
Prakasam
Packages 10 to 13
8
Somavarappadu to Muppavaram, km 314.6 to 343.24
Prakasam (end near Addanki)
Package 14; meets NH-16
9
Chilakaluripet and Guntur
Andhra Pradesh
Existing NH-16 north
10
Vijayawada
NTR, AP
End of the corridor
Order
Point or section
District
Road
1
Bengaluru
Bengaluru, Karnataka
Existing NH-44 north
2
Chikkaballapur
Chikkaballapura, Karnataka
Existing NH-44
3
Kodikonda (Kodur), km 0
Sri Sathya Sai, AP
NH-544G starts; interchange with NH-44
4
Vanavolu to Vankarakunta, km 24.3 to 45.7
Sri Sathya Sai
Package 2, near Puttaparthi
5
Vankarakunta to Kavulakuntla, km 45.7 to 196.0
YSR Kadapa
Packages 3 to 8
6
Kavulakuntla to Narayanampet, km 196.0 to 203.5
SPS Nellore
Package 9
7
Narayanampet to Somavarappadu, km 203.5 to 314.6
Prakasam
Packages 10 to 13
8
Somavarappadu to Muppavaram, km 314.6 to 343.24
Prakasam (end near Addanki)
Package 14; meets NH-16
9
Chilakaluripet and Guntur
Andhra Pradesh
Existing NH-16 north
10
Vijayawada
NTR, AP
End of the corridor
To see the NH-544G route map against village boundaries and survey numbers, view the alignment on the 1acre map layer, which plots it as per the DPR. A route line on any map shows the corridor, not the acquisition boundary: only the 3A and 3D notifications fix which parcels are taken.
All 14 greenfield packages were awarded by February 2023 and the foundation stone was laid on 11 March 2024. The table lists the latest dated public report for each stretch as of October 2026. Where a stretch has no recent report, confirm progress with the NHAI project implementation unit before relying on an opening date.
Stretch
Section
Latest dated report
Package 1
Kodur to Vanavolu, km 0 to 24.3
June 2025: the Sri Sathya Sai collector inspected works, including the trumpet interchange at km 0+280, and asked officials to expedite them
Package 2
Vanavolu to Vankarakunta, km 24.3 to 45.7
January 2026: Guinness World Record attempts launched near Puttaparthi; October 2026: memento for four records presented to the collector
Packages 3 to 9
Vankarakunta to Narayanampet, km 45.7 to 203.5 (Kadapa, Nellore)
No stretch-specific report in the sources listed; check with NHAI
Prakasam stretch, about 110 km
Within packages 10 to 14
September 2025: at a review near Talluru, NHAI officials said land acquisition was complete; target completion May 2026
Stretch
Section
Latest dated report
Package 1
Kodur to Vanavolu, km 0 to 24.3
June 2025: the Sri Sathya Sai collector inspected works, including the trumpet interchange at km 0+280, and asked officials to expedite them
Package 2
Vanavolu to Vankarakunta, km 24.3 to 45.7
January 2026: Guinness World Record attempts launched near Puttaparthi; October 2026: memento for four records presented to the collector
Packages 3 to 9
Vankarakunta to Narayanampet, km 45.7 to 203.5 (Kadapa, Nellore)
No stretch-specific report in the sources listed; check with NHAI
Prakasam stretch, about 110 km
Within packages 10 to 14
September 2025: at a review near Talluru, NHAI officials said land acquisition was complete; target completion May 2026
Whether the May 2026 target for the Prakasam stretch was met, and when the full corridor will open to traffic, had not been confirmed in an official update at the time of this revision. Searches for the BKV expressway status and the NH-544G completion date should treat 2026/27 as the target, not an opening date. For land near the alignment, completion matters less than notification: check the 3A and 3D status of the survey number first.
Land acquisition Section 3A 3D notifications under the National Highways Act 1956 are the only legal trigger that fixes a parcel inside the alignment. Anything sold to you on the basis of a "DPR map" or a "proposed alignment" without 3A/3D publication has no acquisition status and offers no compensation entitlement. The DPR itself flagged a real example: at the Kodikonda start point, the Enforcement Directorate had notice boards declaring that Lepakshi Knowledge Hub Pvt Ltd plots were attached in a money laundering case. The fact-pack on what each acquisition stage permits, drawn from the NHAI DPR and NH Act 1956.
Acquisition Stage
What It Means
Can Land Be Sold?
Compensation Trigger?
Commonly Misrepresented?
Pre-DPR / Feasibility
NHAI surveying alignment options
Yes, freely
No
Sold as "guaranteed alignment"
DPR finalised
Alignment fixed in report
Yes; price premium begins
No
Sold at 3-5x with no notification
Section 3A notified
Intent to acquire published in Gazette
Restricted; transactions risky
Triggers competent authority hearings
"Almost notified" framing used
Section 3D notified
Final acquisition declared
No; vests in NHAI
Yes, under NHAI award
Plot already government property
Award published
Compensation amount fixed
No
Compensation paid to owner of record
Late entrants chase original owners
Possession taken
NHAI takes physical possession
No
Already determined
Squatters claim "occupant" status
Acquisition Stage
What It Means
Can Land Be Sold?
Compensation Trigger?
Commonly Misrepresented?
Pre-DPR / Feasibility
NHAI surveying alignment options
Yes, freely
No
Sold as "guaranteed alignment"
DPR finalised
Alignment fixed in report
Yes; price premium begins
No
Sold at 3-5x with no notification
Section 3A notified
Intent to acquire published in Gazette
Restricted; transactions risky
Triggers competent authority hearings
"Almost notified" framing used
Section 3D notified
Final acquisition declared
No; vests in NHAI
Yes, under NHAI award
Plot already government property
Award published
Compensation amount fixed
No
Compensation paid to owner of record
Late entrants chase original owners
Possession taken
NHAI takes physical possession
No
Already determined
Squatters claim "occupant" status
The Andhra Pradesh-specific trap is the brokerage of agricultural plots in Sri Sathya Sai YSR Kadapa Prakasam revenue villages along the proposed alignment, where 3A is yet to be published. Buyers assume they will be acquired at 4x rural market value under the 2013 Act. The reality: NHAI uses the NH Act 1956 award process, and the rate per acre depends on the registered Sub-Registrar value, not market rate. If the broker shows you only a "DPR sketch" without a 3A Gazette reference, walk away.
The expressway is split between a 343 km Kodikonda to Addanki greenfield core (64% of the project) and brownfield upgrades on connecting segments (36%). The DPR alignment passes existing reserved forests (Amagondapalem, Kottakota, Errokota, Nagidi, Kokkarajukonda, Dorigallu) and PGCIL high-voltage corridors. Plot demand is concentrated within 2-5 km of proposed interchanges, where the brokerage premium is highest and the regulatory risk is most concentrated. The corridors most asked about, mapped against the DPR alignment.
Corridor / Locality
District
Project Section
Investment Driver
Kodikonda, Settipalli, Kodur
Sri Sathya Sai
NH-44 takeoff
Bengaluru-Hyderabad Highway junction
Pulivendula, Mydukur
YSR Kadapa
Greenfield core
Mid-section interchange demand
Yerraguntla, Proddutur, Kadapa
YSR Kadapa
Greenfield \+ town link
Cement belt \+ administrative hub
Porumamilla, Darsi, Chendrasekhara Puram
Prakasam
Greenfield
Reserved forest crossings
Kanigiri, Podili, Chemakurthi
Prakasam
Greenfield \+ Bapatla link
NH-565 connectivity, granite belt
Addanki
Bapatla
NH-16 endpoint
Coastal corridor merger
Corridor / Locality
District
Project Section
Investment Driver
Kodikonda, Settipalli, Kodur
Sri Sathya Sai
NH-44 takeoff
Bengaluru-Hyderabad Highway junction
Pulivendula, Mydukur
YSR Kadapa
Greenfield core
Mid-section interchange demand
Yerraguntla, Proddutur, Kadapa
YSR Kadapa
Greenfield \+ town link
Cement belt \+ administrative hub
Porumamilla, Darsi, Chendrasekhara Puram
Prakasam
Greenfield
Reserved forest crossings
Kanigiri, Podili, Chemakurthi
Prakasam
Greenfield \+ Bapatla link
NH-565 connectivity, granite belt
Addanki
Bapatla
NH-16 endpoint
Coastal corridor merger
The most misunderstood corridor is the Pulivendula Kadapa Podili Addanki belt where speculative agricultural plot sales have surged since DPR publication. NHAI's DPR Alternative III recommendation explicitly avoided commercial land in Kodur village (70-80% costlier than Settipalli) and HT line shifting. Buyers chasing 5-acre plots near proposed interchanges should verify whether the parcel sits in the recommended Alternative III alignment, in a discarded alternative, or outside the corridor entirely. Three different alignment options were studied; not all parcels marketed as "expressway frontage" actually fall on the awarded alignment.
This page combines NHAI's project facts as reported at contract award and at the foundation stone with dated district reviews and contractor events reported by The Hans India, read in October 2026. NHAI's own project pages could not be read in full, so package sections and chainages follow the NHAI package names as published in contract-award reports, and they should be read with that caveat. Facts that could not be confirmed were left out.
* The Hans India, 5 June 2025: Package 1 inspection, trumpet interchange at km 0+280 near Koduru Thopu on NH-44 * The Hans India, 26 September 2025: Prakasam stretch review, land acquisition complete, May 2026 target * The Hans India, 6 January 2026: Rajpath Infracon record attempts on Package 2 near Puttaparthi * The Hans India, 4 October 2026: memento for four Guinness World Records presented to the Sri Sathya Sai collector * Contract-award reports, January and February 2023: the 14 packages and their chainages from Kodur to Muppavaram * The Hindu BusinessLine, 11 March 2024: foundation stone for national highway projects

Boundaries and numbers come from published state cadastral records. See all map layers.

View Bengaluru Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Bengaluru BDA mas...

View Bengaluru Masterplan - Roads alignment as a live map overlay – check road corridor and land impact free on 1acre.in...

View STRR alignment as a live map overlay – check road corridor and land impact free on 1acre.in. Bengaluru STRR land bu...

View Bengaluru Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Bengaluru BDA mas...

View Bengaluru Masterplan - Roads alignment as a live map overlay – check road corridor and land impact free on 1acre.in...

View STRR alignment as a live map overlay – check road corridor and land impact free on 1acre.in. Bengaluru STRR land bu...
Bengaluru Vijayawada Expressway runs 624 km in total from Kodikonda on NH-44 in Sri Sathya Sai district to Addanki on NH-16 in Bapatla district, with a 343 km greenfield core and approximately 281 km of brownfield connections. It connects via existing national highways to Bengaluru and Vijayawada cities at both ends.
NH-544G passes through Sri Sathya Sai, Anantapur, YSR Kadapa, SPS Nellore, Prakasam, and Bapatla in Andhra Pradesh. Connecting brownfield sections involve Karnataka districts toward Bengaluru. The greenfield core covers Sri Sathya Sai YSR Kadapa Prakasam primarily.
The PM laid the foundation stone on 11 March 2024 after all 14 packages were awarded by February 2023. NHAI is targeting 2027 for completion. In January 2026, the project set four Guinness World Records for rapid construction speed near Puttaparthi, and the contractor presented the record memento to the Sri Sathya Sai collector in October 2026. In September 2025, the Prakasam stretch was targeted for May 2026. Construction is under Hybrid Annuity Model with phased package delivery.
The BKV Expressway is 624 km in total, with 343 km as greenfield (Kodikonda to Addanki) and approximately 281 km as brownfield connections. The full NH-544G greenfield expressway is part of Bharatmala Pariyojana Phase II at an estimated cost of Rs 19,320 crore.
Historically, land within 2-5 km of NHAI interchanges sees price appreciation post-completion. However, plots inside the acquired right-of-way will be taken over under NH Act 1956. Only parcels outside the 3D notification stand to gain.
Land acquisition began in December 2022. NHAI has acquired over 4,000 hectares, and in September 2025 NHAI officials said acquisition was complete in Prakasam district. 3A and 3D notifications are published district-wise on the Bhoomi Rashi portal; verify your specific survey number there, or use 1acre's Premium map layer (https://1acre.in/subscribe) to overlay the acquisition boundary on your plot instantly.
Yes for parcels outside the notified right-of-way, subject to standard AP land conversion and revenue rules. Plots inside the acquired alignment vest in NHAI. The DPR avoids reserved forests and commercial land per Alternative III.
The expressway is access controlled toll road with limited interchanges at Kodikonda, near Pulivendula, Kadapa, Podili, Addanki and connecting state highways. Exact interchange schedule appears in the executed contracts under Hybrid Annuity Model NHAI packages awarded February 2023.
NH-544G starts at Kodikonda (Kodur) on NH-44 in Sri Sathya Sai district, Andhra Pradesh, where a trumpet interchange at km 0+280 joins the Bengaluru-Hyderabad highway. The greenfield section ends at Muppavaram near Addanki, at km 343.24, on NH-16. Bengaluru is reached over NH-44 to the south-west and Vijayawada over NH-16 to the north.
Yes. The route in order, from Bengaluru through Kodikonda, the Kadapa and Prakasam packages and Muppavaram to Vijayawada, is in the route table on this page, and the alignment is plotted on the map layer as per the DPR. A route line shows the corridor only; the acquisition boundary is fixed by the 3A and 3D notifications for each village.
All 14 greenfield packages are under construction. The latest dated reports are a June 2025 inspection of Package 1 at the NH-44 interchange, Guinness World Record work on Package 2 near Puttaparthi in January 2026, confirmed in October 2026, and a September 2025 review in Prakasam that reported acquisition complete with a May 2026 target. No full-corridor opening date has been officially confirmed.
From Vijayawada, take NH-16 south through Guntur and Chilakaluripet towards Addanki, join NH-544G at Muppavaram, and follow it west through Prakasam, Nellore, Kadapa and Sri Sathya Sai districts to Kodikonda. There it meets NH-44, which runs south through Chikkaballapur to Bengaluru. Use the greenfield section only where it has been opened to traffic.
Source
Official National Highways Authority of India (NHAI) documents
Official Website
www.nhai.gov.in
Coordinate Reference System
EPSG:4326 (WGS 84)
Geometry Type
LineString / MultiLineString
Data Format
Vector (GeoJSON) + Raster Tiles
Last Verified
May 2026
Status
Active
