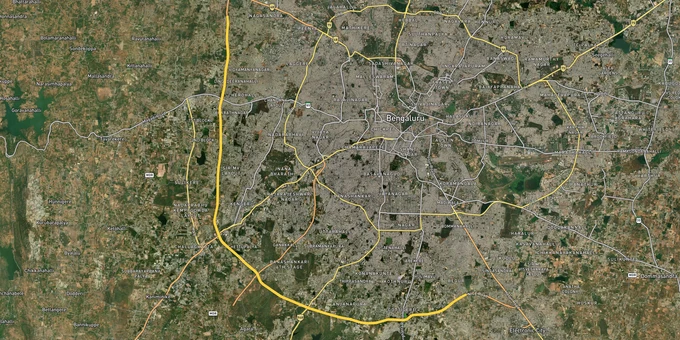

NICE Road is the 41 km tolled outer peripheral road built by Nandi Infrastructure Corridor Enterprises, connecting Hosur Road near Electronic City in the southeast to Tumkur Road in the northwest. As of 2024, over 100,000 vehicles use it daily. It functions as a semi-ring connecting South and West Bengaluru outside the BDA development area. For land buyers, the road creates two distinct questions. First, the operative NICE Road section is real, tolled, and carrying traffic. Second, the broader Bengaluru-Mysuru Infrastructure Corridor project, for which over 20,000 acres were earmarked, is legally fractured: in July 2025, a single-judge bench of the Karnataka High Court led by Justice R. Devdas quashed all land acquisition notifications issued between 1998 and 2009 under Section 28 of the KIAD Act, citing 23 years of inaction and zero compensation paid to farmers. On 29 July 2026, a High Court division bench upheld that ruling and dismissed the appeals filed by NICE and KIADB. Any land along the NICE Road corridor that sits within an unresolved acquisition zone is not a clean title. This page covers the NICE Road map and route, its key facts, the latest expansion and legal status as of October 2026, what that means for buyers, where the real growth corridors are, and what documents actually confirm a safe transaction.
NICE Road is the peripheral road of the Bangalore Mysore Infrastructure Corridor (BMIC), built and run by Nandi Infrastructure Corridor Enterprises (NICE). It forms a semi-ring around south and west Bengaluru, running about 41 km from Hosur Road at Electronic City in the southeast to Tumkur Road near BIEC in the northwest. A separate link road of about 8 km runs from the corridor towards the city. The junctions below are listed in order from the Hosur Road end. Each is an entry and exit point, and each is where most land and layout activity along the road is concentrated.
Order
Junction
Road it meets
1
Electronic City
Hosur Road
2
Gottigere
Bannerghatta Road
3
Talaghattapura
Kanakapura Road
4
Clover Leaf interchange
Link road towards the city and the BMIC expressway towards Mysuru
5
Hosakerehalli, near Nayandahalli
Hosakerehalli toll plaza area
6
Kengeri
Mysuru Road
7
Gollarahatti
Magadi Road
8
Near BIEC
Tumkur Road
Order
Junction
Road it meets
1
Electronic City
Hosur Road
2
Gottigere
Bannerghatta Road
3
Talaghattapura
Kanakapura Road
4
Clover Leaf interchange
Link road towards the city and the BMIC expressway towards Mysuru
5
Hosakerehalli, near Nayandahalli
Hosakerehalli toll plaza area
6
Kengeri
Mysuru Road
7
Gollarahatti
Magadi Road
8
Near BIEC
Tumkur Road
At Gottigere, a 100-metre bridge opened in July 2012 closed a long-standing gap at the Bannerghatta Road junction. Before that, traffic from Electronic City had to leave the road at Bannerghatta Road and rejoin it. Navigation apps give live directions to the nearest junction from your location. To see the alignment against survey numbers and planning zones, view the NICE Road layer on the 1acre map.
The table below sets out the basic facts about NICE Road as published by the operator's parent company, court records and news reports up to October 2026.
Fact
Detail
What it is
The peripheral road of the Bangalore Mysore Infrastructure Corridor (BMIC) project
Length
About 41 km of peripheral road (40.8 km in July 2026 toll reports), plus a link road of 8.1 km
Route
Hosur Road at Electronic City to Tumkur Road near BIEC
Type
Private tolled road under a Build-Own-Operate-Transfer (BOOT) framework
Built and operated by
Nandi Infrastructure Corridor Enterprises Ltd (NICE), a subsidiary of BF Utilities
Key agreements
Framework Agreement, 3 April 1997; Toll Concession Agreement with the Governor of Karnataka, 4 September 2000
Opening
A section of the peripheral road was ready to open by June 2006; the Gottigere bridge closing the Bannerghatta Road gap opened in July 2012
Tolls
Based on 1998 rates with increases capped at 10% a year, compounded; latest revision from 1 July 2026
Planning authority
BMICAPA (Bangalore Mysuru Infrastructure Corridor Area Planning Authority)
Land notified
About 20,193 acres in total under acquisition notifications issued from 1998 to 2009 for the whole BMIC project
Wider project
A 111 km Bengaluru-Mysuru expressway, link roads and five townships; about 5 km of the expressway built as of July 2026
Project information
Published by BF Utilities at bfutilities.com
Fact
Detail
What it is
The peripheral road of the Bangalore Mysore Infrastructure Corridor (BMIC) project
Length
About 41 km of peripheral road (40.8 km in July 2026 toll reports), plus a link road of 8.1 km
Route
Hosur Road at Electronic City to Tumkur Road near BIEC
Type
Private tolled road under a Build-Own-Operate-Transfer (BOOT) framework
Built and operated by
Nandi Infrastructure Corridor Enterprises Ltd (NICE), a subsidiary of BF Utilities
Key agreements
Framework Agreement, 3 April 1997; Toll Concession Agreement with the Governor of Karnataka, 4 September 2000
Opening
A section of the peripheral road was ready to open by June 2006; the Gottigere bridge closing the Bannerghatta Road gap opened in July 2012
Tolls
Based on 1998 rates with increases capped at 10% a year, compounded; latest revision from 1 July 2026
Planning authority
BMICAPA (Bangalore Mysuru Infrastructure Corridor Area Planning Authority)
Land notified
About 20,193 acres in total under acquisition notifications issued from 1998 to 2009 for the whole BMIC project
Wider project
A 111 km Bengaluru-Mysuru expressway, link roads and five townships; about 5 km of the expressway built as of July 2026
Project information
Published by BF Utilities at bfutilities.com
NICE Road is not a government road. The state acquired land for it through KIADB, but the road was built with private funds and NICE collects the toll under its concession. The peripheral road and the link road are the only parts of the BMIC project that are substantially complete.
Searches for NICE Road expansion usually mean the unbuilt part of the BMIC project: the 13 km expressway stretch to Bidadi and the rest of the 111 km road to Mysuru. As of October 2026, no new construction on either has been announced, and the project's future is tied up in court and in a political dispute over tolls.
Date
Update
June 2024
NICE proposed merging its expressway at Hemmigepura with NH 275 near Bidadi
November 2024
The state weighed releasing 13,418 acres notified for BMIC and reclaiming about 2,351 acres of excess land
July 2025
A single judge of the Karnataka High Court quashed BMIC acquisitions notified from 1998 to 2009 for the petitioning landowners
January 2026
A High Court division bench asked the state to re-look at the project and discard the old plan
February 2026
The Supreme Court stayed the parts of that judgment suggesting the project be scrapped
1 July 2026
NICE Road tolls rose by at least 10%
29 July 2026
A division bench upheld the July 2025 ruling and dismissed the appeals of NICE and KIADB
4 September 2026
The state Cabinet approved sites for 1,453 farmers who lost land to BMIC
August to October 2026
Union Minister H.D. Kumaraswamy demanded a state takeover and an end to toll collection; the Chief Minister said the state would act as per law
Date
Update
June 2024
NICE proposed merging its expressway at Hemmigepura with NH 275 near Bidadi
November 2024
The state weighed releasing 13,418 acres notified for BMIC and reclaiming about 2,351 acres of excess land
July 2025
A single judge of the Karnataka High Court quashed BMIC acquisitions notified from 1998 to 2009 for the petitioning landowners
January 2026
A High Court division bench asked the state to re-look at the project and discard the old plan
February 2026
The Supreme Court stayed the parts of that judgment suggesting the project be scrapped
1 July 2026
NICE Road tolls rose by at least 10%
29 July 2026
A division bench upheld the July 2025 ruling and dismissed the appeals of NICE and KIADB
4 September 2026
The state Cabinet approved sites for 1,453 farmers who lost land to BMIC
August to October 2026
Union Minister H.D. Kumaraswamy demanded a state takeover and an end to toll collection; the Chief Minister said the state would act as per law
For buyers, the practical point is that the road itself is operating while the land around the unbuilt sections remains legally unsettled. Treat any claim that an extension is coming, or that notified land has been released, as unconfirmed until it appears in a gazette notification or a court order.
The legal complexity around NICE Road is not theoretical. It is documented in Karnataka High Court orders, Supreme Court orders, Deccan Herald investigations, and state Cabinet proceedings. Buyers who skip this context and focus only on highway proximity are the ones ending up with titles that cannot be registered or resold.
### Trap 1: Unresolved acquisition notifications that nobody told you about
Between 1998 and 2009, the state government issued multiple land acquisition notifications for the BMIC project under the KIAD Act. No compensation was paid. Farmers continued farming. Some of those parcels entered the secondary land market and were sold by original owners who had been neither compensated nor formally dispossessed. On July 7-8, 2025, the Karnataka HC quashed all those notifications and directed fresh awards within three months based on April 2019 land values. On 29 July 2026, a division bench of the High Court upheld that order and dismissed the appeals of NICE and KIADB. As of May 2026, over 374 court cases stemming from BMIC land disputes remain pending. Buying any parcel whose survey number appears in KIADB's old acquisition schedule without confirming it has been formally released or re-notified puts the buyer inside active litigation.
### Trap 2: The 13,000-acre denotification pending in Cabinet
As of November 2024, the Karnataka state government was preparing to table a proposal in Cabinet to denotify approximately 13,000 acres originally notified for the NICE Road extension toward Mysuru. As of October 2026, no gazette notification completing that denotification has been reported. Land in those 13,000 acres sits in a grey zone: technically still under acquisition notification but practically abandoned. Some brokers market these parcels as investment-grade land released from acquisition. They are not released until the Cabinet notification is gazetted and the KIADB formally denotifies each survey number.
### Trap 3: BMICAPA jurisdiction without DC conversion
The operative NICE Road corridor, along with interchange zones and the Peripheral Road belt, falls under the planning jurisdiction of BMICAPA, the Bangalore Mysuru Infrastructure Corridor Area Planning Authority. This is a separate planning authority from BDA and BMRDA. Layout approvals from BDA or BMRDA do not automatically apply within BMICAPA's jurisdiction. Additionally, any land that carries an agricultural classification in the revenue record requires a formal DC conversion order under the Karnataka Land Revenue Act before any construction is permitted. Buying agricultural land on the NICE Road corridor without DC conversion and a BMICAPA layout approval means no building plan sanction, no Khata, and no home loan. The mandatory document checklist before any payment on a NICE Road corridor plot:
Document
What to Confirm
Where to Verify
KIADB Acquisition Status
Survey number not in active or pending BMIC acquisition schedule
KIADB office, Nrupathunga Road, Bengaluru
BMICAPA Layout Approval
Layout sanctioned by BMICAPA under KTCP Act, 1961
bmicapa.tpa.gov.in
DC Conversion Order
Agricultural land formally converted; order number on revenue record
Taluk office / Revenue department
E-Khata
Local body recognition for the specific plot number
BBMP or Gram Panchayat
Encumbrance Certificate
No prior charge, mortgage, or court attachment on the survey number
Sub-Registrar, 13-year search
RERA Registration
Developer registered under Karnataka RERA for plotted projects
rera.karnataka.gov.in
Document
What to Confirm
Where to Verify
KIADB Acquisition Status
Survey number not in active or pending BMIC acquisition schedule
KIADB office, Nrupathunga Road, Bengaluru
BMICAPA Layout Approval
Layout sanctioned by BMICAPA under KTCP Act, 1961
bmicapa.tpa.gov.in
DC Conversion Order
Agricultural land formally converted; order number on revenue record
Taluk office / Revenue department
E-Khata
Local body recognition for the specific plot number
BBMP or Gram Panchayat
Encumbrance Certificate
No prior charge, mortgage, or court attachment on the survey number
Sub-Registrar, 13-year search
RERA Registration
Developer registered under Karnataka RERA for plotted projects
rera.karnataka.gov.in
One site-specific trap runs along the Mysuru Road to Hosakerehalli and Sunkadakatte-Kadabagere stretch. The Empowered Committee proceedings of April 2025 specifically discussed pending acquisition for this stretch. NICE dropped its HC petition after that meeting, reserving the right to refile. Land in this micro-belt carries ongoing uncertainty about whether fresh acquisition proceedings will commence. Confirm with the KIADB whether the specific survey number in this stretch is subject to any active or proposed notification before transacting.
The investment case for NICE Road land breaks into three segments with very different risk profiles.
Segment
Planning Authority
Growth Driver
Specific Risk
Electronic City to Gottigere (southeast node)
BMICAPA / BDA interface zone
Namma Metro Yellow Line operational since August 2025 (RV Road to Bommasandra, 19.15 km, 16 stations); Electronic City IT corridor employment base
NICE vs BMRCL land dispute at Beratena Agrahara and Doddathoguru villages; verify survey numbers against BMRCL acquisition schedule for Yellow Line viaduct
Gottigere to Bannerghatta Road junction (south-central)
BMICAPA jurisdiction
Bannerghatta Biological Park creates green buffer and lifestyle; Kanakapura Road adjacency; Art of Living and institutional demand
DC conversion mandatory for agricultural parcels; plots between ₹3,000-15,000 per sq ft depending on conversion status
Mysuru Road to Tumkur Road (western arc)
BMICAPA; Mysuru extension under denotification consideration
Tumkur Road industrial and warehousing growth; Bidadi township proposal (8,000 acres discussed in April 2025 Empowered Committee)
Highest concentration of unresolved acquisition notifications; 13,000-acre denotification not yet gazetted; Sunkadakatte-Kadabagere stretch in active discussion
Segment
Planning Authority
Growth Driver
Specific Risk
Electronic City to Gottigere (southeast node)
BMICAPA / BDA interface zone
Namma Metro Yellow Line operational since August 2025 (RV Road to Bommasandra, 19.15 km, 16 stations); Electronic City IT corridor employment base
NICE vs BMRCL land dispute at Beratena Agrahara and Doddathoguru villages; verify survey numbers against BMRCL acquisition schedule for Yellow Line viaduct
Gottigere to Bannerghatta Road junction (south-central)
BMICAPA jurisdiction
Bannerghatta Biological Park creates green buffer and lifestyle; Kanakapura Road adjacency; Art of Living and institutional demand
DC conversion mandatory for agricultural parcels; plots between ₹3,000-15,000 per sq ft depending on conversion status
Mysuru Road to Tumkur Road (western arc)
BMICAPA; Mysuru extension under denotification consideration
Tumkur Road industrial and warehousing growth; Bidadi township proposal (8,000 acres discussed in April 2025 Empowered Committee)
Highest concentration of unresolved acquisition notifications; 13,000-acre denotification not yet gazetted; Sunkadakatte-Kadabagere stretch in active discussion
The southeastern node near Electronic City carries the clearest current appreciation case. The Namma Metro Yellow Line began full commercial operations on August 10-11, 2025, with all 16 stations from RV Road to Bommasandra running at approximately 10-minute peak-hour frequency as of early 2026. Bommasandra station sits roughly 10 minutes by road from the Gottigere-NICE Road interchange. Residential plots within verified, BMICAPA-approved layouts in this belt are now absorbing IT workforce demand that was previously concentrated entirely in Electronic City apartments. Kanakapura Road, which intersects the NICE Road at its southeastern arc, carries its own growth momentum. Plots listed between ₹3,000 and ₹15,000 per sq ft depending on zone classification and conversion status. Projects by Prestige and Assetz are active in this corridor. Namma Metro Green Line extension to Anjanapura has reduced commute times and BMRDA-approved layouts here are seeing sustained absorption. The western arc from Mysuru Road to Tumkur Road has the longest value runway but the highest current legal risk. The Bidadi township proposal discussed in the April 2025 Empowered Committee meeting involves 8,000 acres and represents a potential long-cycle appreciation story. The problem is that the denotification of 13,000 surplus acres and the fresh acquisition of 10,000 acres for the Bengaluru-Mysuru expressway are being discussed simultaneously, and buyers cannot determine which category a specific survey number falls into without checking KIADB records directly.
This page draws on court rulings, the operator's published project details and established news reports, read in October 2026. Court rulings are taken from reports of the judgments; road lengths and junctions from the operator's parent company and toll notices. Where a fact could not be confirmed from one of these sources, it was left out.
* LiveLaw (29 July 2026): High Court division bench ruling upholding the quashing of BMIC acquisitions, bench, case number, expressway built length * Deccan Herald (12 January 2026, 19 February 2026): January 2026 High Court judgment and the Supreme Court stay * The News Minute (28 August 2026, 4 September 2026): project timeline, 4 July 2025 single-judge order, Cabinet decision on sites for 1,453 farmers * BF Utilities, NICE project page: 41 km peripheral road, link road, interchange sites, ownership * Deccan Herald and Asianet Newsable (1 July 2026): toll revision and current lengths (40.8 km and 8.1 km) * Deccan Herald (8 July 2012): Gottigere bridge * Deccan Herald (15 June 2006, via India Environment Portal): section ready to open in 2006 * The Hans India (27 September 2026, 8 October 2026): Framework Agreement and Toll Concession Agreement dates, toll terms, current political dispute * Deccan Herald (19 November 2024): Bidadi expressway proposal and 13,418-acre release proposal * Asianet Newsable (16 August 2026), The Week (7 September 2026) and UNI (3 October 2026): takeover demand and Hosakerehalli toll plaza

Boundaries and numbers come from published state cadastral records. See all map layers.

View Anekal Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Anekal masterplan zo...

View Bengaluru Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Bengaluru BDA mas...

View Bengaluru Masterplan - Roads alignment as a live map overlay – check road corridor and land impact free on 1acre.in...

View Anekal Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Anekal masterplan zo...

View Bengaluru Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Bengaluru BDA mas...

View Bengaluru Masterplan - Roads alignment as a live map overlay – check road corridor and land impact free on 1acre.in...
NICE Road is the operational 41 km tolled outer peripheral road connecting Electronic City on Hosur Road to Tumkur Road, built by Nandi Infrastructure Corridor Enterprises. The larger BMIC project, which was intended to extend toward Mysuru, is legally fractured: the Karnataka High Court quashed all 1998-2009 acquisition notifications in July 2025 for 23 years of inaction, and on 29 July 2026 a division bench upheld that ruling, dismissing the appeals of NICE and KIADB. Over 374 related court cases remain pending as of 2025.
BMICAPA, the Bangalore Mysuru Infrastructure Corridor Area Planning Authority, is the single planning authority for the entire BMIC corridor under the KTCP Act, 1961. It is separate from BDA and BMRDA. Layout approvals from BDA or BMRDA do not extend into BMICAPA jurisdiction. Any plotted layout within the NICE Road corridor must carry BMICAPA sanction, verifiable at bmicapa.tpa.gov.in, for it to have legal standing.
A single-judge bench led by Justice R. Devdas quashed all acquisition notifications issued between 1998 and 2009 under Section 28 of the KIAD Act. The court found that no compensation had been awarded despite land sitting idle for over two decades, depriving farmers of agricultural income. The court directed fresh awards within three months, computed on April 2019 land values. On 29 July 2026, a division bench of Justices D.K. Singh and T.M. Nadaf upheld the ruling and dismissed the appeals of NICE and KIADB.
As of November 2024, the Karnataka government was preparing a Cabinet proposal to denotify roughly 13,000 acres originally notified for the NICE Road extension toward Mysuru. Until a formal gazette notification denotifies specific survey numbers and KIADB confirms release, land in those acres remains under acquisition notification. Brokers claiming these parcels are free-to-transact are ahead of the official process. As of October 2026, no such gazette notification has been reported. Verify KIADB status before any transaction.
The Kanakapura Road corridor, which intersects the NICE Road arc, has plots listed between ₹3,000 and ₹15,000 per sq ft depending on zone and conversion status. The Electronic City-Gottigere belt has absorbed IT workforce demand following the Namma Metro Yellow Line becoming fully operational in August 2025. Bannerghatta Road adjacent parcels with green belt access carry a lifestyle. The western Tumkur Road arc remains the most affordable entry point with the longest value horizon.
Visit the KIADB office at Nrupathunga Road, Bengaluru, or write formally to the Special Land Acquisition Officer, KIADB (BMICP), requesting a status certificate for the specific survey numbers. Cross-check against the Karnataka High Court July 2025 order list of quashed notifications. Confirm the survey number is not part of the Mysuru Road to Hosakerehalli or Sunkadakatte-Kadabagere stretches currently under fresh acquisition discussion by the state's Empowered Committee.
DC conversion is a formal order from the Deputy Commissioner under the Karnataka Land Revenue Act that changes a parcel's classification from agricultural to residential or commercial use. Without it, constructing any structure on agricultural land near NICE Road is illegal and subject to demolition. The conversion must be recorded in the revenue register and reflected in the RTC before any BMICAPA building plan sanction will be issued.
KIADB acquisition status certificate confirming the survey number is not in any active or pending BMIC notification. BMICAPA layout approval order from bmicapa.tpa.gov.in. DC conversion order from the taluk office confirming the land classification has been changed. E-Khata from the local body recognising the specific plot number. Encumbrance certificate from the Sub-Registrar covering 13 years confirming no prior charge, mortgage, or court attachment. Karnataka RERA registration at rera.karnataka.gov.in for the plotted project. All six. Not five.
The NICE peripheral road is about 41 km long, running from Hosur Road at Electronic City to Tumkur Road near BIEC. Toll reports in July 2026 put it at 40.8 km, with a separate link road of 8.1 km towards the city. The wider project also planned a 111 km expressway to Mysuru, but only about 5 km of it had been built as of July 2026.
The project began with a Framework Agreement signed on 3 April 1997, followed by the Toll Concession Agreement on 4 September 2000. A section of the peripheral road was ready to open by June 2006, when the state asked NICE not to open it without permission. The missing link at Gottigere, a 100-metre bridge at the Bannerghatta Road junction, opened in July 2012.
NICE Road is a private toll road. Nandi Infrastructure Corridor Enterprises Ltd (NICE), a subsidiary of BF Utilities, built it and collects tolls under a Toll Concession Agreement signed with the Governor of Karnataka in 2000, on a Build-Own-Operate-Transfer basis. The state acquired the land through KIADB, and BMICAPA, a state body, is the planning authority for the corridor.
No new stretch is under construction as of October 2026. The 13 km expressway to Bidadi and the rest of the 111 km road to Mysuru remain largely unbuilt. In January 2026 the High Court asked the state to re-look at the project, and in February 2026 the Supreme Court stayed its suggestion to scrap it. In July 2026 the High Court upheld the quashing of old land acquisitions.
NICE Road runs along the southern and western edge of Bengaluru. You can join it at eight junctions: Electronic City (Hosur Road), Gottigere (Bannerghatta Road), Talaghattapura (Kanakapura Road), the Clover Leaf interchange, Hosakerehalli near Nayandahalli, Kengeri (Mysuru Road), Gollarahatti (Magadi Road) and near BIEC (Tumkur Road). A navigation app gives live directions to the nearest junction.
Project details for NICE Road are published by its parent company, BF Utilities, on bfutilities.com. Layout approvals for land along the corridor are checked on the BMICAPA site, bmicapa.tpa.gov.in, and acquisition records sit with KIADB. Toll revisions are notified through the state Public Works Department; the latest took effect on 1 July 2026.
Source
Official Nandi Infrastructure Corridor Enterprise (NICE) documents
Coordinate Reference System
EPSG:4326 (WGS 84)
Geometry Type
LineString / MultiLineString
Data Format
Vector (GeoJSON) + Raster Tiles
Last Verified
2026
Status
Active
Anything wrong, outdated, or missing we want to hear it.
