Sonipat Masterplan: Zone Check and Land Use Guide

DGTCP-2031

Masterplan

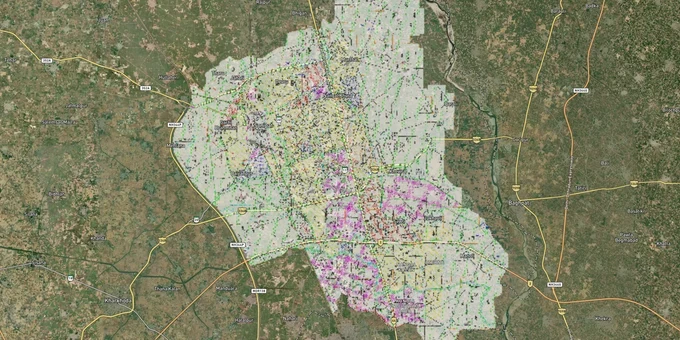

Sonipat Masterplan: Zone Check and Land Use Guide map

Overview

The Sonipat Kundli masterplan zone that covers your survey number determines whether you can build on it at all. The Sonipat-Kundli Multifunctional Urban Complex Draft Development Plan 2031, notified by the Haryana Government in Gazette Extraordinary No. 176-2020/Ext. On 25 November 2020, it governs 20,220 hectares of residential, commercial, industrial, and mixed-use land across 92 planned sectors. The plan targets a population of 25,06,600 and is administered by the Department of Town and Country Planning (DTCP), Haryana. This page covers the two legal traps most buyers overlook, the three corridors shaping investor decisions, and the exact steps to verify a parcel before signing.

The CLU trap and unregulated development risk have cost Sonipat buyers dearly.

The Sonipat-Kundli complex sits within a controlled area defined under the Punjab Scheduled Roads and Controlled Areas Restriction of Unregulated Development Act, 1963. Under this Act, any land within the controlled area requires a Change of Land Use (CLU) certificate from DTCP Haryana before any non-agricultural development begins. This is not a procedural formality. In 2025, the Supreme Court of India (2025 INSC 419) confirmed in a case involving Sonipat industrial land that construction without a valid CLU in a controlled area is a substantive violation, not a technicality, and that the absence of a CLU disqualifies any claim to regularisation.

The second trap is the history of IMT land acquisition fraud in the district. The Sonipat-Kharkhoda Industrial Model Township case established the pattern: land acquired under public interest notifications was later selectively denotified and released to private builders after sale at suppressed prices, with 418 of 600+ notified acres released in a court-condemned transaction. The Punjab and Haryana High Court in February 2014 described it as a "colourable exercise of power." Buyers in fringe villages near proposed industrial or residential sector boundaries face this risk whenever sellers claim proximity to an upcoming IMT or Sector as justification for a premium.

The table below shows the documents that must be verified for any Sonipat Kundli masterplan zone transaction.

CLU Certificate

Issuing Authority

DTCP Haryana, Sonipat

What It Confirms

Legal authorization to develop in a controlled area

Risk if Absent

Supreme Court-confirmed violation; no regularisation

DTCP Licence / Layout Approval

Issuing Authority

DTCP Haryana

What It Confirms

Plotted colony or sector layout is sanctioned

Risk if Absent

Unapproved colony, no registry, no bank loan

Jamabandi (Record of Rights)

Issuing Authority

Revenue Dept. Haryana (Jamabandi portal)

What It Confirms

Ownership, mutation, encumbrances

Risk if Absent

Title dispute, false ownership claim

RERA Haryana Registration

Issuing Authority

Haryana RERA (hrera.org.in)

What It Confirms

Project registered under the Real Estate Act 2016

Risk if Absent

No statutory delivery obligation

Sector Plan Notification

Issuing Authority

DTCP / Haryana Govt. Gazette

What It Confirms

The sector is officially notified in DDP 2031

Risk if Absent

Speculative layout with no legal backing

If a seller cannot show a DTCP Haryana CLU certificate or a licensed layout number that you can verify at tcpharyana.gov.in, the plot sits in an unregulated development and carries the risk the Supreme Court has confirmed as non-regularisable.

Kundli, Kharkhoda, and the Rai-Nathupur belt: three corridors with very different risk profiles under the Sonipat Kundli masterplan zone

Sonipat's land market has fractured into three distinct tiers, and zone classification under the DDP 2031 is the primary variable separating them.

Kundli is the most mature tier. The DDP 2031 designates significant residential and commercial land across sectors adjacent to the Kundli Industrial Zone on NH-44. Land prices in Kundli surged 190% between 2020 and 2025, reaching approximately ₹61,216 per sq. yd. according to 99acres and MagicBricks data. The DTCP-licensed sectors in this pocket have established supply from developers with formal approvals, and they are closest to the proposed Delhi Metro Yellow Line extension. On 25 March 2025, the Ministry of Housing and Urban Affairs gave in-principle approval for the 26.5-km Yellow Line extension from Samaypur Badli to Nathupur in Sonipat, covering 21 stations and targeting 50,000 daily commuters. Haryana is funding 80% of the project cost.

Kharkhoda forms the emerging second tier. The Maruti Suzuki manufacturing plant, worth ₹18,000 crore, under development in Kharkhoda, is the single largest employment anchor in the district. The DDP 2031 identifies industrial sectors in this belt, and housing demand from auto ancillary workers is driving residential plot sales in adjacent villages. The risk is that much of the available land is in villages outside notified sectors, requiring CLU before any residential development can begin.

The Rai-Nathupur belt is the third tier, directly along the KMP Expressway. The 135-km Kundli-Manesar-Palwal (KMP) Expressway connects NH-44 at Kundli to NH-48 at Manesar and NH-19 at Palwal, and warehousing, logistics, and auto-component manufacturing have clustered along its northern stretch near Rai Industrial Area and Barhi.

Kundli (NH-44 belt)

DDP 2031 Zone Status

Residential and commercial sectors; licensed layouts

Growth Driver

Metro extension, Kundli Industrial Zone

Primary Risk

Price inflation: verify DTCP licence number

Kharkhoda

DDP 2031 Zone Status

Industrial sectors; residential fringe villages

Growth Driver

Maruti Suzuki ₹18,000 cr plant

Primary Risk

CLU mandatory; fringe villages unregulated

Rai / Barhi (KMP corridor)

DDP 2031 Zone Status

Industrial zones: Barhi Textile Park

Growth Driver

KMP logistics, warehousing, Rai Industrial Area

Primary Risk

Commercial-zone land, not residential by default

Nathupur / Sector boundary

DDP 2031 Zone Status

Residential sectors in DDP 2031

Growth Driver

Metro end station; affordable price point

Primary Risk

Verify sector notification before buying

The most misunderstood corridor is the KMP belt near Rai and Barhi. Sellers describe this land as "an industrial zone with residential future value." The DDP 2031 designates over 4,940 hectares in Sonipat-Kundli as industrial. Buying industrial-zoned land expecting residential conversion requires a formal CLU, and that CLU is not guaranteed for land the plan designates as industrial.

Data Source & Verification

Source

Official Town and Country Planning Department (DGTCP), Haryana – Sonipat documents

Official Website

tcpharyana.gov.in

Coordinate Reference System

EPSG:4326 (WGS 84)

Geometry Type

Polygon / MultiPolygon

Data Format

Vector (GeoJSON) + Raster Tiles

Last Verified

2026

Status

Active

Disclaimer: Zoning and boundary information shown here is indicative. Users should verify details with Haryana Urban Development Authority (HUDA) – Sonipat-Kundli or relevant local planning authorities before any transaction or development decision.

Frequently Asked Questions

Explore Delhi Ncr on Map

Verified Lands for sale, Layers & Tools on one single map.

Go to Map

Was this layer helpful?

Anything wrong, outdated, or missing — we want to hear it.
