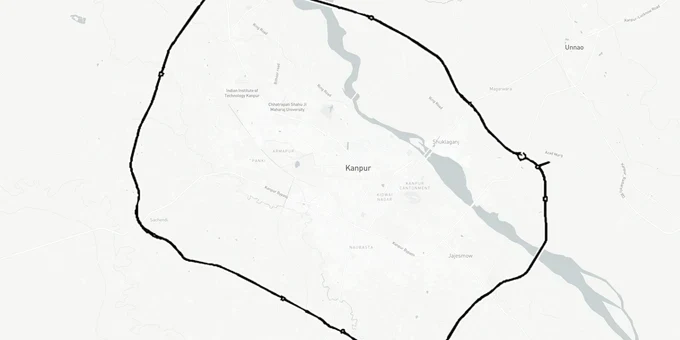

    Kanpur Ring Road map

    Overview

    The Kanpur Ring Road land corridor, officially called Udyog Path, is a 93.21-kilometre six-lane greenfield access-controlled highway encircling Kanpur city. Built by NHAI at an estimated cost of Rs 5,182 crore, it passes through three districts: Kanpur Nagar (62 km), Unnao (27 km), and Kanpur Dehat (4 km). The alignment runs from Mandhana on the Kanpur Aligarh Highway through Sachendi, Ramaipur, Chakeri Airport, Trans Ganga City, and back to Mandhana via the Ganga River crossing. Construction is active on three of five packages, with completion targeted for January 2027.

    What Buyers Near the Kanpur Outer Ring Road Must Verify Before Transacting

    NHAI has acquired 700 hectares of land for this ring road across 271 villages in Kanpur Nagar, Kanpur Dehat, and Unnao districts. Phase 1 alone, the 22.5-km Mandhana to Sachendi stretch, pulled in land from 79 villages. That scale of acquisition means one specific risk is active across the entire perimeter: farmers and landowners whose parcels fall within the notified boundary have been entering the informal sale market with adjacent plots, sometimes without disclosing that their own original land is under NHAI notification.

    The first step before any transaction near this corridor is to cross-check the khasra against the NHAI acquisition notifications for the specific package zone. The Kanpur district land records portal lists notified villages for each phase. If the khasra is in a notified village and the broker cannot show a revenue record confirming the plot sits outside the ROW, do not proceed.

    Three additional risk categories are specific to this corridor and not addressed by generic ring road guidance.

    The table below maps each risk type to the affected package zone.

    Notified village boundary overlap

    Package Zone

    All packages, 271 villages total

    Specific Issue

    Adjacent plots sold without disclosure of NHAI notification

    Verification Step

    Check khasra in Kanpur district land records against phase-wise notification

    Ganga River bridge approach

    Package Zone

    Package 2A (Mandhana-Bithoor belt)

    Specific Issue

    3.2 km Ganga bridge ROW; both banks have development buffer

    Verification Step

    Confirm plot boundary is outside bridge approach ROW

    Package 2A re-tendering gap

    Package Zone

    Mandhana to Trans Ganga City

    Specific Issue

    Package 2A tender was cancelled for technical flaws; retendering as of mid-2025

    Verification Step

    Alignment in this stretch is confirmed but construction delayed; do not buy on inflated pre-completion pricing

    Defence Corridor adjacency

    Package Zone

    Package 3 and 4 (Ramaipur to Sachendi)

    Specific Issue

    UPDIC Kanpur node proximity may create zoning restrictions

    Verification Step

    Check UPDIC node boundary before industrial or commercial land purchase

    Risk Category

    Package Zone

    Specific Issue

    Verification Step

    Notified village boundary overlap

    All packages, 271 villages total

    Adjacent plots sold without disclosure of NHAI notification

    Check khasra in Kanpur district land records against phase-wise notification

    Ganga River bridge approach

    Package 2A (Mandhana-Bithoor belt)

    3.2 km Ganga bridge ROW; both banks have development buffer

    Confirm plot boundary is outside bridge approach ROW

    Package 2A re-tendering gap

    Mandhana to Trans Ganga City

    Package 2A tender was cancelled for technical flaws; retendering as of mid-2025

    Alignment in this stretch is confirmed but construction delayed; do not buy on inflated pre-completion pricing

    Defence Corridor adjacency

    Package 3 and 4 (Ramaipur to Sachendi)

    UPDIC Kanpur node proximity may create zoning restrictions

    Check UPDIC node boundary before industrial or commercial land purchase

    The Package 2A gap is the sharpest near-term risk for buyers. The 8.765-km stretch from Mandhana to Trans Ganga City had its tender cancelled due to technical flaws and retendering was underway in 2025. Brokers are actively selling plots in this belt as if the road is already under active construction. It is not yet, in this specific package. Package 1 (Sachendi to Mandhana) and Package 4 (Jarkala to Pakri via Defence Corridor) have contractors and are building. Package 2A does not. Price your entry accordingly.

    Where Real Demand Is Building Along the Kanpur Outer Ring Road

    The Kanpur Ring Road will offload an estimated 4.5 lakh vehicles daily from city roads once operational. That volume of freight and passenger traffic creates real demand nodes, but they are not evenly distributed around the 93-km perimeter.

    The strongest commercial demand will concentrate at the three major interchange points where the ring road crosses existing national highways: NH-19 at Sachendi, NH-27 at the Trans Ganga City junction in the north, and the Hamirpur Road near Ramaipur where the Defence Corridor connection sits. Each of these points has a documented development plan attached: Sachendi connects with the Awadh Expressway near Amarsus village; Trans Ganga City already has proposed IT cities, integrated townships, and a Wellness City along its perimeter; Ramaipur feeds the UPDIC Kanpur node.

    The table below gives the investment profile for each major corridor pocket.

    Sachendi interchange

    Highway Connection

    NH-19, Awadh Expressway junction

    Primary Demand Driver

    Logistics, freight; Awadh Expressway trijunction

    Hold Period

    3-5 years

    Key Risk

    79 village acquisition notification; verify khasra

    Trans Ganga City belt

    Highway Connection

    NH-27, Lucknow Highway

    Primary Demand Driver

    IT city, integrated township, residential

    Hold Period

    3-6 years

    Key Risk

    Package 2A retendering delay; pre-completion pricing inflated

    Ramaipur / Defence Corridor

    Highway Connection

    Hamirpur Road, UPDIC node

    Primary Demand Driver

    Industrial, defence supply chain

    Hold Period

    4-7 years

    Key Risk

    UPDIC zone restrictions apply to adjacent land

    Chakeri Airport approach

    Highway Connection

    Airport link road, Prayagraj Highway

    Primary Demand Driver

    Commercial, warehousing, hospitality

    Hold Period

    4-6 years

    Key Risk

    Airport link road is proposed, not yet constructed

    Mandhana, Bithoor belt

    Highway Connection

    Kanpur Aligarh Highway

    Primary Demand Driver

    Residential; Ganga bridge corridor

    Hold Period

    3-5 years

    Key Risk

    Bridge ROW buffer on both banks of Ganga

    Corridor Pocket

    Highway Connection

    Primary Demand Driver

    Hold Period

    Key Risk

    Sachendi interchange

    NH-19, Awadh Expressway junction

    Logistics, freight; Awadh Expressway trijunction

    3-5 years

    79 village acquisition notification; verify khasra

    Trans Ganga City belt

    NH-27, Lucknow Highway

    IT city, integrated township, residential

    3-6 years

    Package 2A retendering delay; pre-completion pricing inflated

    Ramaipur / Defence Corridor

    Hamirpur Road, UPDIC node

    Industrial, defence supply chain

    4-7 years

    UPDIC zone restrictions apply to adjacent land

    Chakeri Airport approach

    Airport link road, Prayagraj Highway

    Commercial, warehousing, hospitality

    4-6 years

    Airport link road is proposed, not yet constructed

    Mandhana, Bithoor belt

    Kanpur Aligarh Highway

    Residential; Ganga bridge corridor

    3-5 years

    Bridge ROW buffer on both banks of Ganga

    Trans Ganga City is the most misread pocket on this ring road. Developers and brokers have been marketing plots in the Trans Ganga City area on the basis of planned IT cities and educational hubs. Those proposals exist in the UP government's development plan for the Kanpur Metropolitan Area. But none of them have official layout sanctions or construction timelines as of mid-2025. Agricultural land sold as "Trans Ganga City adjacent" requires an independent check: confirm the specific survey number is within a sanctioned layout, not raw agricultural land branded with a township name.

    Frequently Asked Questions

    What is the Kanpur Ring Road and what is its total length and cost?

    The Kanpur Ring Road, officially named Udyog Path, is a 93.21-km six-lane greenfield NHAI highway circling Kanpur city. Its estimated cost is Rs 5,182 crore. Construction is active across three packages with completion targeted for January 2027.

    Which districts does the Kanpur Outer Ring Road pass through?

    The ring road passes through Kanpur Nagar (62 km), Unnao (27 km), and Kanpur Dehat (4 km). Its alignment connects Mandhana, Sachendi, Ramaipur, Chakeri Airport, Trans Ganga City, and back to Mandhana via Ganga bridges, covering NH-19, NH-27, and NH-34 interchange points.

    How many villages are affected by Kanpur Ring Road land acquisition?

    Overall land will be acquired from 271 villages across the three districts. Phase 1 alone notified land from 79 villages between Mandhana and Sachendi. NHAI has acquired 700 hectares as of mid-2025. Verify any plot's khasra against the Kanpur district land records acquisition notification before transacting.

    When will the Kanpur Ring Road Udyog Path be completed?

    NHAI engineers confirmed January 2027 as the completion target, with Package 1 (Sachendi to Mandhana) expected to be operational by 2026. Package 2A is delayed due to tender cancellation and retendering. Construction is active on Packages 1, 3, and 4.

    How does the Kanpur Ring Road connect to the Awadh Expressway?

    The ring road connects to the Awadh Expressway (Lucknow Kanpur Expressway, NE-6) near Amarsus village in the Unnao section. This trijunction with the 13 toll plazas Kanpur Ring Road creates a freight and logistics hub at the Sachendi and Unnao Shuklaganj belt that is the strongest long-term demand node on the corridor.

    Is it safe to buy land near Package 2A in the Trans Ganga City belt?

    Not yet at current pricing. Package 2A (Mandhana to Trans Ganga City, 8.765 km) had its tender cancelled in 2025 due to technical flaws and retendering was underway. Brokers are pricing this belt as though active construction is happening. Verify the tender appointment date before committing.

    What landmarks does the Kanpur Ring Road alignment pass through?

    The ring road passes Sachendi (NH-19 start/end), Ramaipur (UPDIC Defence Corridor), Chakeri Airport (with a proposed airport link road), Trans Ganga City (proposed IT and residential township), and Mandhana (Kanpur Aligarh Highway junction). A 3.2-km Ganga bridge is part of Package 2 in the Mandhana Bithoor section.
