Gorakhpur Link Expressway: route map, status and land checks

Gorakhpur Link Expressway: route map, status and land checks map

Gorakhpur Link Expressway Preview

24-Hour Free Access

Try the Gorakhpur Link Expressway on the map

Sign in once and explore the layer for a full day.

  • No card details needed
  • Find nearby verified lands for sale

Overview

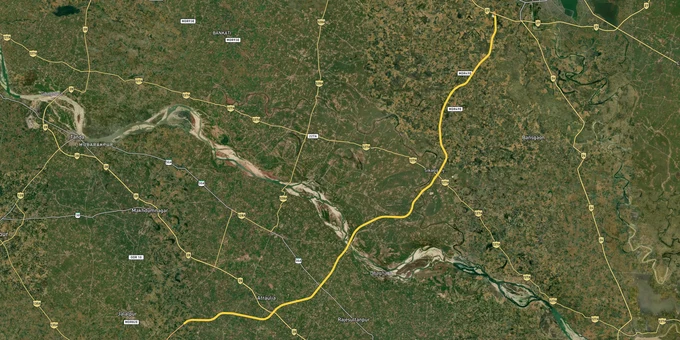

The Gorakhpur Link Expressway is a 91.35 km access-controlled highway connecting Gorakhpur to the Purvanchal Expressway near Azamgarh, built by the UP Expressways Industrial Development Authority (UPEIDA). It starts near Jaitpur village on the Gorakhpur bypass (NH-27) and ends at Salarpur in Azamgarh district. Chief Minister Yogi Adityanath inaugurated it on 20 June 2025.

The corridor runs through four districts: Gorakhpur, Sant Kabir Nagar, Ambedkar Nagar and Azamgarh. Deoria district is not on the alignment. The road has four lanes, expandable to six, on a 110-metre right of way, and UPEIDA puts its cost at Rs 7,283.28 crore including land. The corridor creates a 2 km influence zone on either side where land values have increased by 180% since route notification.

This page covers the route map, current status, route alignment verification, conversion traps in the Right of Way (RoW), and which micro-markets show genuine development activity versus speculative holding.

Interchanges, structures and toll plazas

UPEIDA's published project material lists the structures on the expressway, and contracts awarded since opening show how tolling is being organised. UPEIDA has not published a list of toll plaza names and locations in the material we reviewed, so treat any 'Gorakhpur link expressway toll plaza list' you find elsewhere with care.

Item

Detail

Interchanges

Built at every national highway, state highway and major district road the route crosses

Flyovers

7

Major bridges

8

Minor bridges

28

Vehicular underpasses

20

Light-vehicle underpasses

57

Pedestrian underpasses

48

Safety

Advanced Traffic Management System and 6 ambulances

Proposed car toll

Rs 280 one way, as reported when UPEIDA invited toll-collection bids in July 2024

Toll operator

Highway Infrastructure Ltd, two-year UPEIDA contract worth Rs 220.66 crore (September 2026)

The toll contract covers collecting user fees and running the toll plazas on the stretch, with four patrol-cum-safety vehicles. For land buyers, interchanges matter more than toll plazas: access to the expressway is only at interchanges, so a plot beside the carriageway without a nearby interchange has no direct access. Check the nearest interchange and the service road position before paying an 'expressway touch' premium.

Current status as of October 2026

The expressway has opened. The table gives the main milestones with their dates.

Date

Milestone

February 2019

Land purchase notified in 78 villages of Gorakhpur district; land bought for eight lanes on a 110-metre width

10 February 2020

Construction begins in two packages: APCO Infrastructure (Package 1) and Dilip Buildcon (Package 2)

4 July 2022

99.10% of required land acquired

July 2024

UPEIDA invites bids for a toll-collection agency

20 June 2025

Inaugurated by Chief Minister Yogi Adityanath at Salarpur (Azamgarh) and Bhagwanpur (Gorakhpur)

September 2026

UPEIDA awards the toll operations contract to Highway Infrastructure Ltd

As of October 2026, the expressway is open and the latest UPEIDA update, in September 2026, concerns toll operations. UPEIDA's project page also mentions a planned separate link road towards Varanasi; no route or timeline for it has been published. For land checks, the opening means the alignment is final: compare a plot's khasra number with the revenue map and UPEIDA's land acquisition records rather than relying on a broker's sketch.

Fake Survey Numbers and RoW Encroachment Traps

The expressway's 2 km development control zone is poorly enforced, and brokers routinely sell agricultural plots advertised as "expressway touch" that fall inside the 110-metre Right of Way that UPEIDA acquired for the carriageway, future widening, service roads and toll plazas. Two patterns dominate fraud cases filed at Gorakhpur Civil Court since 2023.

The table below shows the most common document misrepresentation patterns in expressway corridor sales.

Fraud Type

How It Works

Document to Verify

Recovery Rate if Caught

RoW Encroachment Sale

Survey numbers inside the 110 m RoW sold as "development land"

UPEIDA land acquisition records + revenue map overlay

12% (buyers lose deposit)

Fake Proximity Claim

Agricultural land 8-12 km from alignment marketed as "500m from expressway."

GDA-approved layout map + Google Earth verification

40% (partial refund after arbitration)

Double Conversion Fee

Land sold as "conversion approved," but GDA fee never paid to Gorakhpur Development Authority

Form 4 receipt from Tehsil and GDA NOC original

65% (buyers can complete process)

Assigned Land Resale

Grameen land assigned to SC/ST families under UP Zamindari Abolition Act resold illegally

Khatauni check for "Bhumihin" or "Assigned" annotation

8% (title void under Section 154)

If the seller cannot produce a stamped Conversion Order (Form 7) from the Tehsil and a GDA layout approval number starting with GDA/Layout/2022 or later, the plot is either unconverted agricultural land or part of a non-approved colony. Walk away.

Investable Corridors Versus Speculative Holdings

Investment activity along the expressway route is concentrated at its two ends. UPEIDA lists the expressway's districts as Gorakhpur, Sant Kabir Nagar, Ambedkar Nagar and Azamgarh, so Bhatni, Rudrapur and Deoria Sadar are not on this corridor. Treat plots in Deoria district marketed as Gorakhpur Link Expressway land as a red flag.

The table below breaks down corridor segments by development maturity and institutional interest.

Corridor Segment

Tehsil(s)

Km Marker

Dominant Use

Construction Activity %

Institutional Buyer %

3-Year Appreciation

Gorakhpur East (NH-27 Junction to Jungle Deval)

Gorakhpur Sadar

0-15

Residential layouts + warehousing

22%

35% (logistics firms)

340%

Azamgarh Interchange (Phulpur to Purvanchal junction)

Phulpur

78-91

Industrial + Mandi relocation

18%

41% (MSME units)

280%

The Gorakhpur East corridor has actual occupancy, with 14 warehousing licences issued by GDA since January 2023 for cold storage and FMCG distribution yards serving the Nepal border trade. The middle of the route, through Sant Kabir Nagar and Ambedkar Nagar districts, has no published development data; treat plots there as agricultural holdings unless a layout approval exists.

For Land Owners & Agents

Looking to sell your land in Uttar Pradesh?

I want to sell my land in Uttar Pradesh

10:32

Plz share your Land's location - We will list it on 1acre map, for Free.

10:32

For Land Buyers

Browse all verified lands & plots in Uttar Pradesh

View on Map

Every listing goes through our Preliminary Verification Process.

Frequently Asked Questions

Source

Official Uttar Pradesh Expressways Industrial Development Authority (UPEIDA) documents

Official Website

upeida.up.gov.in

Coordinate Reference System

EPSG:4326 (WGS 84)

Geometry Type

LineString / MultiLineString

Data Format

Vector (GeoJSON) + Raster Tiles

Last Verified

2026

Status

Active

Disclaimer:
Information shown here is indicative. Users should verify details with the Uttar Pradesh Expressways Industrial Development Authority (UPEIDA) or the relevant district / planning authorities before any transaction or development decision.
