Purvanchal Expressway Preview
Try the Purvanchal Expressway on the map
Sign in once and explore the layer for a full day.

Purvanchal Expressway Preview
Try the Purvanchal Expressway on the map
Sign in once with your mobile number and explore the layer for a full day.
The Purvanchal Expressway is a fully operational 340.824-km, six-lane access-controlled highway built by UPEIDA, connecting Chand Sarai village in Lucknow to Haidaria village in Ghazipur, 18 km from the Bihar border. Inaugurated in November 2021 at a total project cost of ₹22,494.66 crore, it passes through nine districts: Lucknow, Barabanki, Amethi, Sultanpur, Ayodhya, Ambedkar Nagar, Azamgarh, Mau, and Ghazipur. Five dedicated industrial corridors are planned alongside it. This page sets out the route, the entry and exit points and the project facts first, then the land-record traps, acquisition-zone risks, and micro-market logic a buyer must understand before committing capital along this corridor.

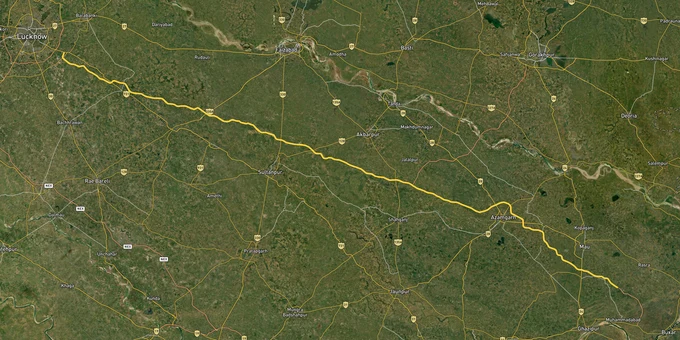

The Purvanchal Expressway runs west to east across eastern Uttar Pradesh. It starts at Chand Sarai village in Lucknow district, on the Lucknow-Sultanpur Road (NH-731), and ends at Haidaria village in Ghazipur district on NH-19, about 18 km before the Bihar border. For anyone asking about the Purvanchal Expressway direction, the road heads out of Lucknow towards Sultanpur, then continues east through Azamgarh and Mau to Ghazipur.
Two locations draw the most searches. Kurebhar, in Sultanpur district, is where the 3.2-km emergency airstrip for Indian Air Force aircraft sits on the carriageway; the expressway was inaugurated there on 16 November 2021. Chand Sarai is the western start, where traffic from Lucknow joins.
The table lists the nine districts in the order UPEIDA gives them, with a reference point for each. Use it to place land near Purvanchal Expressway, then view the alignment on the 1acre map layer.
Order
District
Reference point on the route
1
Lucknow
Start at Chand Sarai, NH-731 (Lucknow-Sultanpur Road) interchange
2
Barabanki
Sansara village; crossing of the Haidergarh-Barabanki road (SH-13)
3
Amethi
Section around Jarai Kalan village
4
Sultanpur
Kurebhar airstrip; Sultanpur-Faizabad (SH-9) and Sultanpur-Akbarpur (NH-128) interchanges
5
Ayodhya
Part of the central section of the route
6
Ambedkar Nagar
Akbarpur-Dostpur (MDR-113E) and Akbarpur-Jaunpur (SH-5) roads
7
Azamgarh
Gorakhpur Link Expressway junction at Salarpur; Azamgarh-Tanda road (NH-28)
8
Mau
Azamgarh-Mau road (SH-34)
9
Ghazipur
Mau-Ghazipur road; end at Haidaria on NH-19
Order
District
Reference point on the route
1
Lucknow
Start at Chand Sarai, NH-731 (Lucknow-Sultanpur Road) interchange
2
Barabanki
Sansara village; crossing of the Haidergarh-Barabanki road (SH-13)
3
Amethi
Section around Jarai Kalan village
4
Sultanpur
Kurebhar airstrip; Sultanpur-Faizabad (SH-9) and Sultanpur-Akbarpur (NH-128) interchanges
5
Ayodhya
Part of the central section of the route
6
Ambedkar Nagar
Akbarpur-Dostpur (MDR-113E) and Akbarpur-Jaunpur (SH-5) roads
7
Azamgarh
Gorakhpur Link Expressway junction at Salarpur; Azamgarh-Tanda road (NH-28)
8
Mau
Azamgarh-Mau road (SH-34)
9
Ghazipur
Mau-Ghazipur road; end at Haidaria on NH-19
The road is six lanes wide, with structures built for eight lanes, inside a 120-m right of way.
Searchers often look for an entry point close to a town or village. The expressway is access-controlled, so traffic can join or leave only at interchanges and slip roads. The table lists them from west to east with their approximate distance from the Chand Sarai start, as given in UPEIDA's 2018 pre-construction traffic and toll study and reproduced in public reference sources. Distances are rounded to the nearest kilometre; check the built interchange positions on the map layer.
Approx. km from Chand Sarai
Crossing road
Type
0
NH-731 (Lucknow-Sultanpur Road), Chand Sarai
Trumpet interchange, western start
37
SH-13 (Haidergarh-Barabanki Road)
Slip roads with toll booth
58
SH-31 (Inhauna-Rudauli Road)
Slip roads with toll booth
82
SH-15 (Raebareli-Faizabad Road)
Interchange with toll plaza
122
SH-9 (Sultanpur-Faizabad Road)
Interchange with toll plaza
138
NH-128 (Sultanpur-Akbarpur Road)
Interchange with toll plaza
161
MDR-113E (Akbarpur-Dostpur Road)
Slip roads with toll booth
182
SH-5 (Akbarpur-Jaunpur Road)
Slip roads with toll booth
191
Gorakhpur Link Expressway
Trumpet interchange
203
SH-124 (Ahiraula-Budhanpur Road)
Slip roads with toll booth
235
NH-28 (Azamgarh-Tanda Road)
Interchange with toll plaza
254
SH-34 (Azamgarh-Mau Road)
Slip roads with toll booth
294
SH-34 (Mau-Ghazipur Road)
Interchange with toll plaza
330
Ballia link road (planned)
Slip roads with toll booth
341
NH-19 (old NH-31), Haidaria
Trumpet interchange, eastern end
Approx. km from Chand Sarai
Crossing road
Type
0
NH-731 (Lucknow-Sultanpur Road), Chand Sarai
Trumpet interchange, western start
37
SH-13 (Haidergarh-Barabanki Road)
Slip roads with toll booth
58
SH-31 (Inhauna-Rudauli Road)
Slip roads with toll booth
82
SH-15 (Raebareli-Faizabad Road)
Interchange with toll plaza
122
SH-9 (Sultanpur-Faizabad Road)
Interchange with toll plaza
138
NH-128 (Sultanpur-Akbarpur Road)
Interchange with toll plaza
161
MDR-113E (Akbarpur-Dostpur Road)
Slip roads with toll booth
182
SH-5 (Akbarpur-Jaunpur Road)
Slip roads with toll booth
191
Gorakhpur Link Expressway
Trumpet interchange
203
SH-124 (Ahiraula-Budhanpur Road)
Slip roads with toll booth
235
NH-28 (Azamgarh-Tanda Road)
Interchange with toll plaza
254
SH-34 (Azamgarh-Mau Road)
Slip roads with toll booth
294
SH-34 (Mau-Ghazipur Road)
Interchange with toll plaza
330
Ballia link road (planned)
Slip roads with toll booth
341
NH-19 (old NH-31), Haidaria
Trumpet interchange, eastern end
For a land buyer, distance to the nearest interchange matters more than distance to the carriageway. A plot that touches the expressway boundary has no direct access to it; the nearest entry may be many kilometres away. Check the interchange position on the map layer before paying a premium for 'expressway frontage', and check the land papers set out below before any token payment.
The Purvanchal Expressway was built by the Uttar Pradesh Expressways Industrial Development Authority (UPEIDA), the state body that also plans the industrial corridors along it. It was delivered in eight construction packages on an engineering, procurement and construction (EPC) model, with contracts taking effect in October 2018. Firms awarded packages in 2018 included Gayatri Projects, Apco Infratech, GR Infraprojects, PNC Infratech and Oriental Structural Engineers.
The table brings together the project facts most often searched, including the Purvanchal Expressway project cost and budget.
Item
Detail
Length
340.824 km
Lanes
Six lanes, expandable to eight
Right of way
120 m
Start
Chand Sarai, Lucknow district (NH-731)
End
Haidaria, Ghazipur district (NH-19), about 18 km from the Bihar border
Districts
9
Built by
UPEIDA, eight EPC packages
Foundation stone
14 July 2018
Inauguration
16 November 2021, Kurebhar airstrip, Sultanpur
Project cost
₹22,494.66 crore including land (UPEIDA)
Budget split at opening
Land ₹7,380 crore; civil construction ₹12,562 crore; other costs ₹2,555 crore
Emergency airstrip
3.2 km long, Sultanpur district
Wayside facilities
402 km of service roads; fuel and CNG stations
Item
Detail
Length
340.824 km
Lanes
Six lanes, expandable to eight
Right of way
120 m
Start
Chand Sarai, Lucknow district (NH-731)
End
Haidaria, Ghazipur district (NH-19), about 18 km from the Bihar border
Districts
9
Built by
UPEIDA, eight EPC packages
Foundation stone
14 July 2018
Inauguration
16 November 2021, Kurebhar airstrip, Sultanpur
Project cost
₹22,494.66 crore including land (UPEIDA)
Budget split at opening
Land ₹7,380 crore; civil construction ₹12,562 crore; other costs ₹2,555 crore
Emergency airstrip
3.2 km long, Sultanpur district
Wayside facilities
402 km of service roads; fuel and CNG stations
The cost figures differ slightly between official documents: UPEIDA gives ₹22,494.66 crore including land, while the state's inauguration material gave a total outlay of ₹22,497 crore. Both describe the same project. For land buyers, the land acquisition share matters most: it shows that most land along the alignment was bought by the state, so plots on the corridor itself are not for sale.
The expressway is built and operational, but the land-title problem it created in Azamgarh is still unresolved and it is the single most dangerous trap for buyers along this corridor. During acquisition, more than 25 families holding sarkari patta titles (government-granted land to landless poor, processed through gram sabha, lekhpal, and sub-divisional magistrate) received zero compensation because authorities reclassified their plots as forest land. This means sarkari patta entries in Bhulekh records near the expressway alignment carry an active risk of being contested as forest land, even where families have farmed them for decades.
The table below lists the three document-level checks every buyer must complete before signing any agreement on a plot in the nine expressway districts.
Document
Portal
What to Check
Risk if Skipped
Khatauni (Record of Rights)
upbhulekh.gov.in
Owner name, Khasra number, land category, dispute status
Buying from a non-owner or a litigated plot
Bhunaksha (cadastral map)
upbhunaksha.gov.in
Plot boundaries vs. physical location on ground
Boundary disputes post-registration
Vaad Grast Status
upbhulekh.gov.in (Sale Status section)
Check if Khasra/Gata is flagged in any legal proceedings
Hidden court encumbrance on title
Document
Portal
What to Check
Risk if Skipped
Khatauni (Record of Rights)
upbhulekh.gov.in
Owner name, Khasra number, land category, dispute status
Buying from a non-owner or a litigated plot
Bhunaksha (cadastral map)
upbhunaksha.gov.in
Plot boundaries vs. physical location on ground
Boundary disputes post-registration
Vaad Grast Status
upbhulekh.gov.in (Sale Status section)
Check if Khasra/Gata is flagged in any legal proceedings
Hidden court encumbrance on title
Sarkari patta land is not the same as pucca private patta. If a seller presents an older revenue entry but cannot show an unencumbered Khatauni from the current cycle, treat it as a red flag that requires tehsil-level verification before any token payment.
The acquisition-zone risk runs in the other direction too. UPEIDA is still acquiring land along the five planned industrial corridors. Earlier reporting put the land acquired along the Purvanchal Expressway at 873 hectares, roughly 60% of the approved land. The plan behind it is larger: at the November 2021 inauguration, the state listed 21 industrial sites covering 9,171 hectares across 12 districts for the Purvanchal Expressway Industrial Corridor. In July 2024, the latest official statewide update found for this page, it reported 1,812 hectares acquired across 25 locations for the industrial corridors on all its expressways, against a target of 5,598 hectares, and said acquisition for the Purvanchal corridor had not yet started in Lucknow. Until the bainama (a local term for the sale deed in land acquisition proceedings) is complete for a given khasra, that plot's status can change. Check the UP Bhulekh dispute status for any Khasra within two to three kilometers of a known industrial corridor boundary before buying.
The expressway is operational, but the investment case is not uniform across all nine districts. The strongest signal comes from where UPEIDA is putting its own acquisition money. In Ghazipur's Mohammadabad area, a 448-hectare industrial corridor is under active land acquisition, with 83.89% of proposed land acquired in the Ghazipur Integrated Manufacturing and Logistics Cluster (IMLC) as of February 2026. That level of government commitment creates a different risk profile from speculative plots in, say, Barabanki.
The table below maps each district segment against its current activity level, the confirmed infrastructure trigger, and the primary buyer risk.
Corridor / Micro-Market
Key Driver
UPEIDA Acquisition Status
Primary Risk
Gosainganj, Lucknow (western entry)
Agra-Lucknow Expressway junction, Sultanpur Road
Entry/exit land acquisition active
Higher circle rates; limited agricultural-to-industrial conversion headroom
Sultanpur (airstrip node)
3.2-km IAF emergency airstrip at Kurebhar
Industrial interest post-airstrip
Periodic expressway closure during IAF maintenance
Azamgarh (Gorakhpur Link junction)
Gorakhpur Link Expressway connects at Salarpur village
Industrial corridor land identified; bainama underway Nov 2023
Sarkari patta dispute risk; forest land reclassification cases active
Mohammadabad, Ghazipur (eastern IMLC)
448-hectare industrial corridor; Bihar border proximity
83.89% of proposed land acquired as of Feb 2026
Remaining 16% acquisition still active; plots within boundary face government takeover at circle rates
Mau (bridge nodes)
Azamgarh-Mau and Mau-Ghazipur road (SH-34) interchanges; the NH-19 (old NH-31) end point at Haidaria is in Ghazipur district
Logistics and warehousing focus
Lower urbanisation; longer appreciation timeline
Corridor / Micro-Market
Key Driver
UPEIDA Acquisition Status
Primary Risk
Gosainganj, Lucknow (western entry)
Agra-Lucknow Expressway junction, Sultanpur Road
Entry/exit land acquisition active
Higher circle rates; limited agricultural-to-industrial conversion headroom
Sultanpur (airstrip node)
3.2-km IAF emergency airstrip at Kurebhar
Industrial interest post-airstrip
Periodic expressway closure during IAF maintenance
Azamgarh (Gorakhpur Link junction)
Gorakhpur Link Expressway connects at Salarpur village
Industrial corridor land identified; bainama underway Nov 2023
Sarkari patta dispute risk; forest land reclassification cases active
Mohammadabad, Ghazipur (eastern IMLC)
448-hectare industrial corridor; Bihar border proximity
83.89% of proposed land acquired as of Feb 2026
Remaining 16% acquisition still active; plots within boundary face government takeover at circle rates
Mau (bridge nodes)
Azamgarh-Mau and Mau-Ghazipur road (SH-34) interchanges; the NH-19 (old NH-31) end point at Haidaria is in Ghazipur district
Logistics and warehousing focus
Lower urbanisation; longer appreciation timeline
Sultanpur is the most misread market on this corridor. Brokers pitch it as an "airstrip township" zone. That airstrip is built for Indian Air Force aircraft and is used for emergency landings. It is not a civil aviation hub, and the 6-km stretch around it is periodically closed for maintenance. Any scheme selling "airport-adjacent" plots in Sultanpur deserves heightened scrutiny.
For Land Owners & Agents
I want to sell my land in Uttar Pradesh
10:32
Plz share your Land's location - We will list it on 1acre map, for Free.
10:32

250 Sq yds
2.5 Acres
For Land Buyers
Every listing goes through our Preliminary Verification Process.

View Ayodhya Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Ayodhya masterplan ...

View Lucknow Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Lucknow masterplan ...

View Varanasi Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. VDA Master Plan 20...

View Ayodhya Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Ayodhya masterplan ...

View Lucknow Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Lucknow masterplan ...

View Varanasi Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. VDA Master Plan 20...
Pull the Khatauni for the specific Khasra number at upbhulekh.gov.in before any payment. Confirm the owner's name matches the seller, land category is private (not sarkari or forest), and the vaad grast (dispute) field shows no pending litigation.
No. Sarkari patta is government-granted land to landless beneficiaries. These titles are non-alienable without Collector approval. Investigative reporting documented over 25 such cases in Azamgarh where sarkari patta holders received no acquisition compensation; buying such land risks a void deed.
Five industrial corridors are planned. In Ghazipur's Mohammadabad area, a 448-hectare corridor is under active bainama proceedings. Earlier reporting put total land acquired across the Purvanchal corridors at about 873 hectares, around 60% of approved land. The latest official statewide update found, reported in July 2024, gave 1,812 hectares acquired across 25 locations for all UPEIDA expressway corridors. As of October 2026, confirm a khasra's status with UPEIDA.
Check the district NIC portal (e.g. azamgarh.nic.in) for public acquisition notices, then cross-verify the Khasra's vaad grast status on UP Bhulekh. If the Khasra appears in any acquisition notification PDF, government acquisition at circle rates, not market rates, becomes the risk.
"Bainama" is the local term for the sale deed executed during government land acquisition. UPEIDA uses this process to purchase land from private owners. As of November 2023, identification was complete, but bainama was only partially executed in most corridors, meaning acquisition is legally ongoing in those khasra numbers.
Khasra is the survey/plot number assigned to each land parcel in a village. Khatauni (Record of Rights) is the ownership register, listing the holder's name, land area, category, and any encumbrances. For expressway corridor purchases, check both on upbhulekh.gov.in before proceeding.
UPEIDA is constructing the 91-km Gorakhpur Link Expressway connecting Jaitpur (Gorakhpur district) to Salarpur village in Azamgarh. The junction at Salarpur creates a second infrastructure trigger for Azamgarh, compounding the Purvanchal Expressway land investment thesis for that micro-market specifically.
No. The 3.2-km airstrip at Akhalkiri Karwat village near Kurebhar is an Indian Air Force emergency landing facility, not a commercial airport. Any broker using "airport proximity" as an investment argument for Sultanpur plots is misrepresenting the asset's utility.
Nine. UPEIDA lists Lucknow, Barabanki, Amethi, Sultanpur, Ayodhya, Ambedkar Nagar, Azamgarh, Mau and Ghazipur. The road starts at Chand Sarai in Lucknow district and ends at Haidaria in Ghazipur district. The planned industrial corridor covers a wider area: the state's 2021 plan listed sites in 12 districts, including Gorakhpur, Jaunpur, Ballia and Sant Kabir Nagar, which the road itself does not cross.
The Uttar Pradesh Expressways Industrial Development Authority (UPEIDA) built it. The work was split into eight EPC packages, with contracts effective from October 2018, and firms including Gayatri Projects, Apco Infratech, GR Infraprojects, PNC Infratech and Oriental Structural Engineers won packages. The foundation stone was laid on 14 July 2018 and the expressway opened on 16 November 2021.
UPEIDA gives the project cost as ₹22,494.66 crore including land. The state's November 2021 inauguration material put the total outlay at ₹22,497 crore, split into about ₹7,380 crore for land acquisition, ₹12,562 crore for civil construction and ₹2,555 crore for other costs. The small difference between the two totals comes from rounding and reporting dates.
It starts at Chand Sarai village in Lucknow district on the Lucknow-Sultanpur Road (NH-731) and ends at Haidaria village in Ghazipur district on NH-19, about 18 km before the Bihar border. The total length is 340.824 km. From Lucknow, the direction of travel is towards Sultanpur and then east through Azamgarh and Mau to Ghazipur.
Kurebhar is in Sultanpur district. It is the site of the 3.2-km emergency airstrip built into the expressway for Indian Air Force aircraft, and the Prime Minister inaugurated the expressway there on 16 November 2021. The airstrip is not a civil airport. Nearby interchanges serve the Sultanpur-Faizabad and Sultanpur-Akbarpur roads.
Source
Official Uttar Pradesh Expressways Industrial Development Authority (UPEIDA) documents
Official Website
upeida.up.gov.in
Coordinate Reference System
EPSG:4326 (WGS 84)
Geometry Type
LineString / MultiLineString
Data Format
Vector (GeoJSON) + Raster Tiles
Last Verified
2026
Status
Active
Anything wrong, outdated, or missing we want to hear it.
