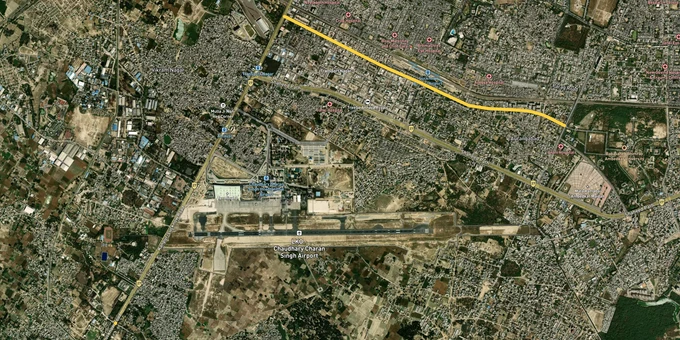

Kanpur Road Lucknow land buying decisions sit at the meeting point of three infrastructure events. The existing NH-27 Amausi corridor still carries most local traffic, the 63 km Awadh Expressway (NE-6) is in final-phase commissioning with the Lucknow package targeted for 2026, and the 104 km Outer Ring Road (NH-230) now connects Kanpur Road with Sultanpur Road, Faizabad Road and Hardoi Road. The Lucknow Development Authority (LDA) governs zoning here under the Master Plan 2031, covering 71,000 hectares and 197 villages. This page covers the zone rules, the LDA approvals that matter, and the corridors where appreciation is real versus speculative.
Two failures sink most plot deals along this belt. The first is buying outside an LDA approved layout Kanpur Road. The Master Plan 2031 has brought villages such as Banthara, Bani, Sarojini Nagar fringe and Mohanlalganj's northern edge into the wider planning area, but inclusion in the plan does not equal automatic sanction. Layout sanction, a Khasra-mapped building plan and a Completion Certificate are three separate documents. Plots advertised on Kanpur Road as "LDA approved" without quoting a sanction order number are typically panchayat or revenue-land plottings. A sub-registrar registry on its own does not confer building rights or home-loan eligibility. The LDA demolition drives across Gosainganj, Dubagga and adjoining peri-urban belts have shown that enforcement is no longer dormant.
The second trap is the agricultural conversion gap. Under the UP Zamindari Abolition and Land Reforms Act, agricultural land cannot host residential plotting without a Section 143 conversion order. Many Banthara Scooter India belt offers carry sale deeds but no conversion. Without it, the buyer holds a registry, no Khata, and no fit under the Master Plan 2031 residential zone. Cross-checking the Khasra number via UP Bhulekh, and the zone classification on the LDA GIS portal, are non-negotiable steps before paying.
Use this screen before you transfer any earnest money on a Kanpur Road plot.
Zone Code
Permitted Use
Requires LDA Approval?
Construction Allowed?
Residential (R1, R2)
Plotted housing, group housing
Yes, layout sanction
Yes, with building plan
Mixed Use
Residential plus limited commercial
Yes
Yes, FAR-bound
Industrial
Manufacturing, warehousing
Yes, plus UPSIDA where applicable
Yes
Agricultural
Farming only
Section 143 conversion needed
Construction prohibited otherwise
Green / Buffer
Canal and water-body buffer
Not for development
Layouts illegal
Transit Influence Zone
500 m on either side of metro
Higher FAR under TOD Policy 2022
Yes, with TOD norms
Zone Code
Permitted Use
Requires LDA Approval?
Construction Allowed?
Residential (R1, R2)
Plotted housing, group housing
Yes, layout sanction
Yes, with building plan
Mixed Use
Residential plus limited commercial
Yes
Yes, FAR-bound
Industrial
Manufacturing, warehousing
Yes, plus UPSIDA where applicable
Yes
Agricultural
Farming only
Section 143 conversion needed
Construction prohibited otherwise
Green / Buffer
Canal and water-body buffer
Not for development
Layouts illegal
Transit Influence Zone
500 m on either side of metro
Higher FAR under TOD Policy 2022
Yes, with TOD norms
The Awadh Expressway is access-controlled. Plots advertised as "expressway-facing" rarely connect to it directly, since entry from the Lucknow end is restricted to the Shaheed Path junction.
Not every kilometre of Kanpur Road carries the same upside. The investable pockets share three traits: location inside LDA jurisdiction with a sanctioned layout, alignment with a Master Plan 2031 scheme or an institutional anchor (Amausi airport, Scooters India, Sarojini Nagar tehsil belt), and proximity to either the Outer Ring Road interchange or the Awadh Expressway access at Shaheed Path-Bani. Speculative pockets sit on revenue land in fringe villages.
The table below maps each major Kanpur Road belt to its driver and the specific risk that follows it.
Corridor / Locality
Authority
Growth Driver
Known Risk
Aashiana / LDA Colony
LDA
Sector-wise LDA development
Settled prices, limited fresh supply
Krishna Nagar / Alambagh
LDA / Nagar Nigam
Metro Red Line, urban density
High base rates
Amausi airport belt
LDA / AAI
Airport proximity, NH-27 frontage
Possible funnel-zone height limits
Naubasta / Scooter India Chauraha
LDA
Awadh Expressway ramp junction
Construction delay near elevated section
Banthara village belt
LDA / Panchayat
Master Plan 2031 expansion edge
Revenue-land plotting common
Sarojini Nagar tehsil fringe
LDA / Tehsil
Outer Ring Road exit
Mixed sanction status
Bani / Outer Ring Road junction
LDA / NHAI
NH-230 to NE-6 trijunction
Service road access incomplete
Corridor / Locality
Authority
Growth Driver
Known Risk
Aashiana / LDA Colony
LDA
Sector-wise LDA development
Settled prices, limited fresh supply
Krishna Nagar / Alambagh
LDA / Nagar Nigam
Metro Red Line, urban density
High base rates
Amausi airport belt
LDA / AAI
Airport proximity, NH-27 frontage
Possible funnel-zone height limits
Naubasta / Scooter India Chauraha
LDA
Awadh Expressway ramp junction
Construction delay near elevated section
Banthara village belt
LDA / Panchayat
Master Plan 2031 expansion edge
Revenue-land plotting common
Sarojini Nagar tehsil fringe
LDA / Tehsil
Outer Ring Road exit
Mixed sanction status
Bani / Outer Ring Road junction
LDA / NHAI
NH-230 to NE-6 trijunction
Service road access incomplete
The most misunderstood pocket on this belt is the Banthara Scooter India belt. Buyers see the upcoming Awadh Expressway ramp at Scooter India Chauraha and the Outer Ring Road junction, and assume the upside is locked in. They miss that a 200-metre stretch near Scooter India Chauraha was a documented bottleneck, with elevated-section, ramp and toll-plaza works in the Lucknow package running into delays through 2025 and early 2026. Ramp commissioning is the value trigger, not the corridor announcement. Verify civil-works progress, not press-release timelines. The second misunderstood pocket is Bani. Acquisition for the Awadh Expressway touched 11 Lucknow villages totalling roughly 460 hectares jointly with Unnao. Plots at the village edge can sit inside the residual acquisition shadow. Demand the Bhulekh extract and the LDA zone overlay before any token.
For Land Owners & Agents
I want to sell my land in Uttar Pradesh
10:32
Plz share your Land's location - We will list it on 1acre map, for Free.
10:32

250 Sq yds
2.5 Acres
For Land Buyers
Every listing goes through our Preliminary Verification Process.

Kanpur Ring Road map: the route around the city, villages on the alignment and the latest NHAI progress by stretch, then...

View Kanpur - Kabrai Highway alignment as a live map overlay – check land acquisition risk and plot proximity free on 1a...

View Ayodhya Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Ayodhya masterplan ...

Kanpur Ring Road map: the route around the city, villages on the alignment and the latest NHAI progress by stretch, then...

View Kanpur - Kabrai Highway alignment as a live map overlay – check land acquisition risk and plot proximity free on 1a...

View Ayodhya Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Ayodhya masterplan ...
Yes. The NH-27 Amausi corridor remains the main urban frontage while the Awadh Expressway serves long-distance traffic. Residential demand on Kanpur Road has held up, particularly around Aashiana, LDA Colony, Krishna Nagar and the Outer Ring Road junction at Banthara.
The Awadh Expressway NE-6 access at the Lucknow end is targeted for opening in 2026 after delays at Scooter India Chauraha. The Unnao package is largely complete. Ramps, toll-plaza commissioning and elevated-section finishing remain pending in the Lucknow package as of early 2026.
An LDA approved layout Kanpur Road carries a sanction order number, an approved Khasra schedule and building-plan eligibility. Verification is done through the LDA Janmitra service and the GIS-based Land Use Portal. A sub-registrar registry alone does not confirm LDA sanction.
Not all of them are. Master Plan 2031 designates separate residential, mixed-use, industrial and green zones. The LDA GIS portal allows residential zone verification by Khasra. Plots in agricultural or green-buffer zones cannot host construction without Section 143 conversion.
The Sarojini Nagar tehsil Khasra check on UP Bhulekh confirms current land classification, the recorded owner and any encumbrance. It is the cheapest pre-purchase legal screen. Mismatch between brochure and Bhulekh records is the most reliable early warning signal.
Yes. A UP RERA registered project carries statutory disclosure of layout sanction, possession timeline and escrow obligations. Plotted developments of 500 sq m or more, or with eight or more plots, must register. Verification on up-rera.in takes minutes and is non-negotiable for any buyer.
Yes. The Ashiyana sector plot belt was developed under LDA sectors with sanctioned layouts, infrastructure obligations and clear title chains. Banthara village plots often rely on revenue records and panchayat approvals only, carrying higher conversion and demolition risk despite lower headline prices.
Yes. The 104 km NH-230 Outer Ring Road connects Kanpur Road with Sultanpur Road, Faizabad Road, Sitapur Road and Hardoi Road at the city periphery. The junction lifts logistics value and supports peripheral residential demand near Banthara and the Mohanlalganj fringe.
Source
Official Lucknow Development Authority (LDA) documents
Coordinate Reference System
EPSG:4326 (WGS 84)
Geometry Type
LineString / MultiLineString
Data Format
Vector (GeoJSON) + Raster Tiles
Last Verified
2026
Status
Active
Anything wrong, outdated, or missing we want to hear it.
