The Bandra Versova Sea Link land investment conversation is grounded in a real project at about 31 percent completion as of May 2026, against a scheduled 35.84 percent. MSRDC is building the 17.17 km eight-lane Bandra-Versova Sea Link (BVSL), officially gazetted as the Swatantrya Veer Savarkar Sea Link, on an EPC model at a revised cost of Rs 18,120.96 crore, with a May 2028 delivery target. The bridge runs 900 metres offshore, connecting the Bandra end of the Bandra-Worli Sea Link to Nana Nani Park in Versova, with four connectors at Bandra, Otters Club (Carter Road), Juhu Koliwada, and Versova.
The Bombay High Court has already issued one landmark ruling directly tied to this project. On 26 April 2019, a division bench of Chief Justice Pradeep Nandrajog and Justice N M Jamdar cancelled MCZMA's permission for MSRDC's casting yard on Juhu Koliwada beach. The court found the 78,392 sq meter beach plot was on the seaward side of the sandy beach and that building activity in CRZ-II is permitted only on the landward side of existing roads or existing authorized structures. That ruling sets the legal standard for any structure proposed near the corridor.
As of October 2026, the latest published progress figure for the sea link is from May 2026: about 31 percent of the work was complete, against a scheduled 35.84 percent. The completion target remains May 2028, and the revised project cost is Rs 18,120.96 crore.
In February 2026 the project was about 30 percent complete. Foundation work stood at about 40 percent, with roughly 1,200 of the 3,000 required piles installed and 3,000 of the 14,000 deck segments cast. The Bandra casting yard has to be vacated for a private development, which leaves the Malad yard for segment casting.
Date
Update
2020
Construction began
January 2022
Reliance Infrastructure exited the contractor joint venture
2024
Cost revised to Rs 18,120.96 crore
February 2026
About 30 percent complete; 1,200 of 3,000 piles, 3,000 of 14,000 segments
May 2026
About 31 percent complete against 35.84 percent scheduled
June 2026
State cabinet sub-committee clears the Rs 1,722.40 crore Bandra Fort connector
28 July 2026
Government resolution sanctions the Bandra Fort connector
May 2028
Current completion target
Date
Update
2020
Construction began
January 2022
Reliance Infrastructure exited the contractor joint venture
2024
Cost revised to Rs 18,120.96 crore
February 2026
About 30 percent complete; 1,200 of 3,000 piles, 3,000 of 14,000 segments
May 2026
About 31 percent complete against 35.84 percent scheduled
June 2026
State cabinet sub-committee clears the Rs 1,722.40 crore Bandra Fort connector
28 July 2026
Government resolution sanctions the Bandra Fort connector
May 2028
Current completion target
The deadline has already moved several times: the 2021 target was 2025. For buyers, the gap between scheduled and actual progress matters more than the headline date. Do not pay a premium that assumes the sea link opens before May 2028 unless MSRDC reports faster progress.

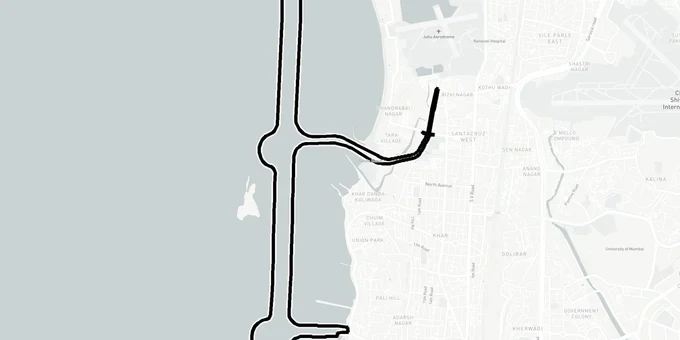

The Bandra Versova Sea Link runs about 900 metres offshore, from the Bandra end of the Bandra-Worli Sea Link to Nana Nani Park in Versova. The total length, including connectors, is 17.17 km. Four connectors bring traffic on and off the sea link, and a fifth, the Bandra Fort connector, has been sanctioned.
Connector
Where it lands
What it links to
Status
Bandra
Bandra end of the Bandra-Worli Sea Link
Bandra-Worli Sea Link and, through it, the Mumbai Coastal Road to south Mumbai
Under construction
Carter Road (Otters Club)
Carter Road, Bandra West
Bandra West
Under construction
Juhu Koliwada
Juhu Tara Road T-junction
Juhu
Under construction
Versova (Nana Nani Park)
Nana Nani Park, Versova, Andheri West
Andheri West and the Versova-Dahisar coastal road interchange
Under construction
Bandra Fort
Beside Bandra Fort, opposite Taj Lands End
Sea link toll plaza to Pali Hill, Bandra West; 3.55 km, two lanes each way
Sanctioned July 2026; tender expected
Connector
Where it lands
What it links to
Status
Bandra
Bandra end of the Bandra-Worli Sea Link
Bandra-Worli Sea Link and, through it, the Mumbai Coastal Road to south Mumbai
Under construction
Carter Road (Otters Club)
Carter Road, Bandra West
Bandra West
Under construction
Juhu Koliwada
Juhu Tara Road T-junction
Juhu
Under construction
Versova (Nana Nani Park)
Nana Nani Park, Versova, Andheri West
Andheri West and the Versova-Dahisar coastal road interchange
Under construction
Bandra Fort
Beside Bandra Fort, opposite Taj Lands End
Sea link toll plaza to Pali Hill, Bandra West; 3.55 km, two lanes each way
Sanctioned July 2026; tender expected
For Bandra sea link directions today, note that only the Bandra-Worli Sea Link is open; the Versova extension is still under construction. When it opens, travel between Bandra and Versova is expected to fall from about 45 minutes to 10 to 15 minutes. Use the connector table to check which exit will serve a property: proximity to the main bridge matters less than distance to the nearest connector.
The Bandra Versova Sea Link is the middle piece of a coastal road chain along Mumbai's western shore, which is why it is often called the Bandra Versova coastal road. The chain has four parts.
Segment
Agency
Length
Status
Mumbai Coastal Road (south), Marine Drive to Worli
BMC
10.5 km
Northbound bridge to the Bandra-Worli Sea Link opened on 26 January 2025
Bandra-Worli Sea Link
Existing
5.6 km
Open since 2009
Bandra Versova Sea Link
MSRDC
17.17 km
About 31 percent complete in May 2026; target May 2028
Versova-Dahisar coastal road
BMC
22.93 km, plus a 4.46 km connector to the Goregaon-Mulund Link Road
Letter of award issued in February 2024; four-year construction deadline
Segment
Agency
Length
Status
Mumbai Coastal Road (south), Marine Drive to Worli
BMC
10.5 km
Northbound bridge to the Bandra-Worli Sea Link opened on 26 January 2025
Bandra-Worli Sea Link
Existing
5.6 km
Open since 2009
Bandra Versova Sea Link
MSRDC
17.17 km
About 31 percent complete in May 2026; target May 2028
Versova-Dahisar coastal road
BMC
22.93 km, plus a 4.46 km connector to the Goregaon-Mulund Link Road
Letter of award issued in February 2024; four-year construction deadline
In the south, the coastal road now joins the Bandra-Worli Sea Link, and the Bandra Versova Sea Link starts at the Bandra end of that bridge. In the north, package A of the Versova-Dahisar coastal road connects to the sea link interchange at Versova and runs about 4.5 km to Bangur Nagar in Goregaon.
For coastal road Bandra to Versova travel, the sea link is the missing piece. Until it opens, the coastal road ends at the Bandra-Worli Sea Link, and traffic to Juhu and Versova still uses city roads.
The table below maps the documented CRZ constraints at each of the four VBSL connector locations, based on official clearance conditions and court proceedings.
Connector
Location
CRZ Category
Documented Constraint
Bandra connector
Bandra-Worli Sea Link junction
CRZ-II
1.17 km length; 2+2 lanes; landward building rule applies
Carter Road / Otters Club connector
Carter Road, Bandra West
CRZ-II
1.80 km; 3+3 lanes; 18-lane toll plaza
Juhu Koliwada connector
Juhu Tara Road T-junction
CRZ-II
2.80 km; 2+2 lanes; HC ruled prior yard permission illegal; 7.9 ha beach area per petitioner's filing (Bombay HC, 26 April 2019)
Versova / Nana Nani Park connector
Nana Nani Park, Versova, Andheri West
CRZ notified
1.80 km; 3+3 lanes; 18-lane toll plaza; MoEF CRZ clearance required piers on stilts in mangrove area only
Connector
Location
CRZ Category
Documented Constraint
Bandra connector
Bandra-Worli Sea Link junction
CRZ-II
1.17 km length; 2+2 lanes; landward building rule applies
Carter Road / Otters Club connector
Carter Road, Bandra West
CRZ-II
1.80 km; 3+3 lanes; 18-lane toll plaza
Juhu Koliwada connector
Juhu Tara Road T-junction
CRZ-II
2.80 km; 2+2 lanes; HC ruled prior yard permission illegal; 7.9 ha beach area per petitioner's filing (Bombay HC, 26 April 2019)
Versova / Nana Nani Park connector
Nana Nani Park, Versova, Andheri West
CRZ notified
1.80 km; 3+3 lanes; 18-lane toll plaza; MoEF CRZ clearance required piers on stilts in mangrove area only
The CRZ clearance for VBSL originally granted by MoEF expired in January 2023 and was renewed in May 2023, with the Ministry of Environment appointing the Zoological Survey of India to monitor marine life impact and IISER Pune to conserve mangroves during construction. Any land within the CRZ-II zone near the Juhu connector that a broker describes as "development-ready" must be verified against the MCZMA's notified HTL boundary and the existing road alignment. The HC ruling makes clear: seaward of the road is not buildable, period.
The VBSL's four connector exits each activate a different micro-market, and the price trajectories are already diverging. Average capital values in Versova fell to Rs 24,458 per sq ft in 2019, climbed to Rs 40,831 by 2024, hit Rs 49,458 in 2025, and touched Rs 55,727 in early 2026, a 128 percent increase over seven years. Juhu is further along in pricing: sea-facing apartments exceed Rs 1 lakh per sq ft, with average rates between Rs 60,000 and Rs 70,000 per sq ft.
The table below shows each connector exit, its current property rate range, and what the VBSL specifically adds to each location.
Sub-market
Connector
Current Property Rate (2025-26)
VBSL-Specific Driver
Known Risk
Bandra West (Bandstand, Carter Road, Otters Club)
Bandra connector + Carter Road connector
Rs 50,000 to Rs 1,00,000/sqft
Direct continuity with BWSL and Mumbai Coastal Road
Already priced in; new supply constrained by heritage and CRZ
Juhu (sea-facing belt)
Juhu Koliwada connector
Rs 60,000 to Rs 1,00,000+/sqft
Connector creates a new interchange at Juhu Tara Road; direct road to Bandra
HC CRZ ruling adds risk for any new coastal redevelopment near the connector site
Versova / Andheri West
Versova / Nana Nani Park connector
Rs 35,000 to Rs 55,727/sqft (avg, early 2026)
Final terminal point; Metro Line 2A already operational; supply constrained by redevelopment cycle
Constrained inventory; CRZ conditions at Versova connector site
Madh Island
Between Versova and Malad
Investment-driven, no published benchmark
Proposed Versova-Madh Island motor bridge (under planning)
No confirmed bridge timeline; purely speculative driver
Sub-market
Connector
Current Property Rate (2025-26)
VBSL-Specific Driver
Known Risk
Bandra West (Bandstand, Carter Road, Otters Club)
Bandra connector + Carter Road connector
Rs 50,000 to Rs 1,00,000/sqft
Direct continuity with BWSL and Mumbai Coastal Road
Already priced in; new supply constrained by heritage and CRZ
Juhu (sea-facing belt)
Juhu Koliwada connector
Rs 60,000 to Rs 1,00,000+/sqft
Connector creates a new interchange at Juhu Tara Road; direct road to Bandra
HC CRZ ruling adds risk for any new coastal redevelopment near the connector site
Versova / Andheri West
Versova / Nana Nani Park connector
Rs 35,000 to Rs 55,727/sqft (avg, early 2026)
Final terminal point; Metro Line 2A already operational; supply constrained by redevelopment cycle
Constrained inventory; CRZ conditions at Versova connector site
Madh Island
Between Versova and Malad
Investment-driven, no published benchmark
Proposed Versova-Madh Island motor bridge (under planning)
No confirmed bridge timeline; purely speculative driver
Juhu is the most misread sub-market along this corridor. Because average rates already exceed Rs 60,000 per sq ft, buyers assume the VBSL upside is fully baked in. It is not, for one specific reason: the Juhu Koliwada connector interchange at Juhu Tara Road creates a brand-new point of road entry that does not exist today. When it opens, properties within 500 metres of that interchange will have a price inflection point that is not yet in current pricing. That is the specific opportunity the general market is missing.

Boundaries and numbers come from published state cadastral records. See all map layers.

View Mumbai Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Mumbai masterplan 20...

View Nagpur Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Nagpur Metropolitan ...

View Pimpri Chinchwad Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Pimpri Chi...

View Mumbai Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Mumbai masterplan 20...

View Nagpur Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Nagpur Metropolitan ...

View Pimpri Chinchwad Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Pimpri Chi...
MSRDC's 17.17 km, eight-lane sea link connects the Bandra-Worli Sea Link to Versova via four connectors at Bandra, Carter Road, Juhu, and Versova. Construction was about 31% complete as of May 2026, against a scheduled 35.84%, with a May 2028 completion target.
The HC ruled in April 2019 that the 78,392 sq metre casting yard on Juhu Koliwada beach violated CRZ-II rules, which permit construction only on the landward side of existing roads. The MCZMA permission was quashed entirely.
CRZ-II applies along the Bandra and Juhu connector zones. Construction is permitted only landward of existing roads. The MoEF CRZ clearance, renewed in May 2023, conditions MSRDC to build piers on stilts in any mangrove-affected section at the Versova connector. For a live overlay of the CRZ-II line on any plot near the BVSL alignment, view the 1acre Premium map (https://1acre.in/subscribe).
The current target is May 2028, revised from the original June 2023 deadline. Causes include COVID-19 slowdown, Reliance Infrastructure's exit in January 2022, fishermen's objections requiring design changes, and a casting yard shift from Bandra to Malad after the Adani Realty land transfer.
Reliance Infrastructure exited the joint venture in January 2022, selling its stake to Webuild (formerly Astaldi's subsidiary). APCO Infratech, based in Gurugram, was then appointed by Webuild as its new on-ground partner. MSRDC approved both transitions.
Yes. The project was rescoped in 2022 from the Versova-Virar Sea Link to the Uttan-Virar Sea Link (UVSL), a proposed 55.12 km eight-lane elevated link at an estimated ₹58,754.71 crore, to be executed by MMRDA. It now originates at Uttan (north of the BVSL alignment) and terminates at Virar via Vasai. The DPR was approved by Government Resolution in November 2025, but construction has not started as of April 2026 — MoEFCC clearance is pending and JICA (or alternative lender) financial close has not been notified. An earlier MMRDA target of 2029 assumes both approvals close in early 2026; any delay pushes that back proportionally.
The latest reported figure, for May 2026, puts the sea link at about 31 percent complete against a scheduled 35.84 percent. MSRDC's completion target is May 2028 and the revised cost is Rs 18,120.96 crore. In July 2026 the state also sanctioned a 3.55 km connector to Bandra Fort and Pali Hill, which is yet to be tendered.
It starts at the Bandra end of the Bandra-Worli Sea Link and ends at Nana Nani Park in Versova, Andheri West. In between, connectors land at Carter Road (Otters Club) and at the Juhu Tara Road junction in Juhu Koliwada. The total length, including connectors, is 17.17 km.
Yes, through the Bandra-Worli Sea Link. The coastal road was linked to the Bandra-Worli Sea Link in January 2025, and the new sea link starts at the Bandra end of that bridge. At the northern end, BMC's Versova-Dahisar coastal road is designed to connect to the sea link interchange at Versova.
When it opens, travel between Bandra and Versova is expected to fall from about 45 minutes to roughly 10 to 15 minutes. The sanctioned Bandra Fort connector is meant to cut the trip from the sea link toll plaza to Pali Hill, which now takes 20 to 30 minutes in heavy traffic.
