Nagpur Gondia Expressway Preview
Try the Nagpur–Gondia Expressway – MSRDC 162.5 km Vidarbha Corridor on the map
Sign in once and explore the layer for a full day.

Nagpur Gondia Expressway Preview
Try the Nagpur–Gondia Expressway – MSRDC 162.5 km Vidarbha Corridor on the map
Sign in once with your mobile number and explore the layer for a full day.

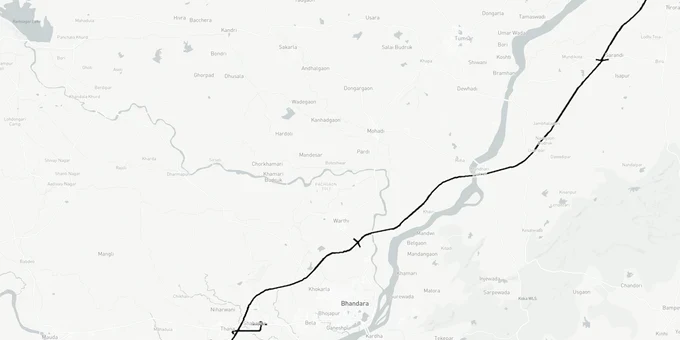

The Nagpur Gondia Expressway cuts 162.57 km through eastern Vidarbha, linking Nagpur to Gondia via Bhandara district. Maharashtra Cabinet approved the project on 26 August 2025; Government Resolution and administrative sanction were issued on 3 October 2025, putting ₹3,162 crore toward land acquisition across 115 villages. MSRDC is handling execution, and when finished, the route is expected to cut the drive from over three hours to about 90 minutes (The Live Nagpur, August 2025). In April 2026, the state's Cabinet Infrastructure Committee cleared MSRDC's HUDCO loan for land acquisition, and the state guarantee for it was approved by July 2026; as of October 2026, no construction contract has been announced. This buyer guide covers what you need to know: the latest update, the village list and where to get it, where land acquisition stands by district, which interchanges matter, how fraud works in corridor deals, and which sections carry verifiable acquisition risk and which have documented planning approvals. How Land Fraud Works Along the Expressway Route MSRDC started buying land in 2023. They need 1,600 hectares, mostly agricultural parcels spread across Nagpur, Bhandara, and Gondia. That scale attracts operators who know buyers get excited about interchange proximity and stop asking basic questions. Nagpur's Anti-Land Mafia Squad caught five separate fraud rings between September and November 2025, total haul ₹50.51 lakh. One crew in Gorewada sold 159 plots off a single 7.72-acre property using a ₹20 stamp paper power of attorney that was never registered. Another group in Shantinagar drew a fake layout on land they didn't own and collected ₹6.40 lakh before anyone checked the revenue records. Here's what actually happens on the ground:
The Nagpur Gondia expressway is at the land acquisition stage. As of October 2026, the latest published milestone is from July 2026, when the state approved its guarantee for the loan MSRDC is taking to pay for the land. No construction contract or official completion date had been announced by then.
Date
Milestone
December 2022
Project planned with MSRDC at an estimated cost of about Rs 12,000 crore
2023
MSRDC begins land acquisition notifications in Nagpur, Bhandara and Gondia districts
November 2024
Union Minister Nitin Gadkari says work on the project has begun and announces a feasibility study for an extension to Raipur
July 2025
Joint land measurement survey under way in all three districts for about 1,600 hectares; project cost reported at about Rs 21,670 crore
26 August 2025
State Cabinet approves the 162.5 km expressway, with Rs 3,162 crore for land acquisition
3 October 2025
Government Resolution and administrative sanction issued
22 April 2026
Cabinet Infrastructure Committee approves MSRDC's HUDCO loan for land acquisition
July 2026
State guarantee of Rs 3,162.18 crore approved: Rs 2,006.03 crore principal and Rs 1,156.16 crore interest, repayable over 15 years
Date
Milestone
December 2022
Project planned with MSRDC at an estimated cost of about Rs 12,000 crore
2023
MSRDC begins land acquisition notifications in Nagpur, Bhandara and Gondia districts
November 2024
Union Minister Nitin Gadkari says work on the project has begun and announces a feasibility study for an extension to Raipur
July 2025
Joint land measurement survey under way in all three districts for about 1,600 hectares; project cost reported at about Rs 21,670 crore
26 August 2025
State Cabinet approves the 162.5 km expressway, with Rs 3,162 crore for land acquisition
3 October 2025
Government Resolution and administrative sanction issued
22 April 2026
Cabinet Infrastructure Committee approves MSRDC's HUDCO loan for land acquisition
July 2026
State guarantee of Rs 3,162.18 crore approved: Rs 2,006.03 crore principal and Rs 1,156.16 crore interest, repayable over 15 years
What comes next, as reported in July 2025: MSRDC will issue tenders once land acquisition nears completion, and contractors will get 30 months to build the road. That means compensation and possession of land come before any construction on the ground. For buyers, a survey number that is notified but not yet acquired is still in the acquisition process, and it should not be bought on the expectation of a quick payout or a quick road.
The expressway acquires land in about 115 villages across Nagpur, Bhandara and Gondia districts. MSRDC has not published a consolidated village list or a village list PDF online, in English or Marathi, that could be read for this page. The verified points on the route are below.
District
Verified villages and points
Source of the detail
Nagpur
Gavsi Manapur interchange on Wardha Road near Jamtha, where the expressway starts at the Outer Ring Road, about 5 km from the Samruddhi Mahamarg start at Shivmadka
MSRDC project as reported at Cabinet approval
Bhandara
The route passes through Bhandara district; interchange locations are listed on this page
Cabinet approval and GR
Gondia
Sawari village near Gondia city, where the expressway ends; a Tiroda connector and a Gondia bypass
July 2025 project report
District
Verified villages and points
Source of the detail
Nagpur
Gavsi Manapur interchange on Wardha Road near Jamtha, where the expressway starts at the Outer Ring Road, about 5 km from the Samruddhi Mahamarg start at Shivmadka
MSRDC project as reported at Cabinet approval
Bhandara
The route passes through Bhandara district; interchange locations are listed on this page
Cabinet approval and GR
Gondia
Sawari village near Gondia city, where the expressway ends; a Tiroda connector and a Gondia bypass
July 2025 project report
The village-wise notices are issued district by district, so the full list for your area sits with the land acquisition officer for the sub-division, at the Collector's office in Nagpur, Bhandara or Gondia. These notices are usually in Marathi; searches for a "Samruddhi Mahamarg (समृद्धी महामार्ग) Nagpur to Gondia village list" refer to the same project, since the road is planned as an extension of the Samruddhi Expressway. Ask for the notification number and date for your survey number, and check whether a joint measurement has been done on it. To see whether a survey number falls on the alignment, view the Nagpur Gondia expressway layer on the 1acre map.
Land acquisition figures for this project have been published for the project as a whole, not district by district. The table sets out what has been published, with the date.
District
What has been published
Date
Nagpur
Start of the expressway at Gavsi Manapur; notifications issued; joint measurement survey under way
Notifications from 2023; survey reported July 2025
Bhandara
Notifications issued; joint measurement survey under way
Notifications from 2023; survey reported July 2025
Gondia
The largest share of the land needed; end of the expressway at Sawari; Tiroda connector and Gondia bypass
Reported July 2025
All three districts
About 1,600 hectares across about 115 villages; Rs 3,162.18 crore for land acquisition, funded by a HUDCO loan with a state guarantee
Cabinet August 2025; GR October 2025; guarantee July 2026
District
What has been published
Date
Nagpur
Start of the expressway at Gavsi Manapur; notifications issued; joint measurement survey under way
Notifications from 2023; survey reported July 2025
Bhandara
Notifications issued; joint measurement survey under way
Notifications from 2023; survey reported July 2025
Gondia
The largest share of the land needed; end of the expressway at Sawari; Tiroda connector and Gondia bypass
Reported July 2025
All three districts
About 1,600 hectares across about 115 villages; Rs 3,162.18 crore for land acquisition, funded by a HUDCO loan with a state guarantee
Cabinet August 2025; GR October 2025; guarantee July 2026
Most of the land is agricultural. Once a survey number is notified, the land can still be sold privately, but the buyer steps into the acquisition process and receives only the compensation that the award fixes for that parcel. Before buying any land within a few kilometres of the alignment, get the 7/12 extract, check it for an acquisition entry, and ask the sub-divisional office whether the survey number appears in any notification for the expressway.
If the broker says "NA order is coming" or "we have political contacts to clear it," that's your exit. The transaction should already have documentary proof, not future promises.
Fraud Type
How It Runs
What Stops It
Fake layout near interchanges
Seller claims NMRDA (Nagpur Metropolitan Region Development Authority) or NIT (Nagpur Improvement Trust) approved the subdivision, shows you a photocopy
Demand the original sanctioned layout with file number and approval date, call the authority to confirm
Cheap POA (Power of Attorney) with no registration
You get shown a ₹20 or ₹100 stamp paper saying someone can sell the land, but the registry has no record
Insist on a registered sale deed showing the full ownership chain back to the original title holder
Same plot, different buyers
Common in Bhandara villages where record-keeping is slower
Get a 7/12 extract dated within the last 15 days and an encumbrance certificate covering the past 13 years
Doctored 7/12 records
The survey number matches but the area or owner name has been altered
Collect the certified copy directly from the Tehsildar office, verify the survey number on site with GPS
Fraud Type
How It Runs
What Stops It
Fake layout near interchanges
Seller claims NMRDA (Nagpur Metropolitan Region Development Authority) or NIT (Nagpur Improvement Trust) approved the subdivision, shows you a photocopy
Demand the original sanctioned layout with file number and approval date, call the authority to confirm
Cheap POA (Power of Attorney) with no registration
You get shown a ₹20 or ₹100 stamp paper saying someone can sell the land, but the registry has no record
Insist on a registered sale deed showing the full ownership chain back to the original title holder
Same plot, different buyers
Common in Bhandara villages where record-keeping is slower
Get a 7/12 extract dated within the last 15 days and an encumbrance certificate covering the past 13 years
Doctored 7/12 records
The survey number matches but the area or owner name has been altered
Collect the certified copy directly from the Tehsildar office, verify the survey number on site with GPS
The expressway runs 72.5 km from Nagpur to Bhandara, another 72.6 km from Bhandara to Gondia, plus, according to a July 2025 project report in The Live Nagpur, a 14 km connector to Tiroda and a 4 km bypass near Gondia. MSRDC has not published these lengths in a readable official document, so confirm them with MSRDC. Eight interchanges sit at Gavasi, Pachgaon, Thana, Rotary, Panjra, Paldongri, Lohri, and Savari. What happened along the Samruddhi corridor gives you the structure for what to verify: confirm RERA (Real Estate Regulatory Authority) approval, sanctioned layout, and NA conversion before transacting. Interchange proximity alone is not a buyer-safety signal. But that's aggregate data. Individual micro-markets vary wildly depending on existing infrastructure, zoning clearances, and how far speculation has already run.
Corridor Stretch
What's There Now
Buyer-Relevant Activity
What Can Go Wrong
Gavasi to Jamtha
Gavasi interchange, 5 km from where Samruddhi begins at Shivmadka
RERA layouts, NMRDA oversight, plotted developments already moving
Prices have run ahead of delivery, confirm the NA order is final and the development plan permits residential use
Tiroda connector (14 km, July 2025 report)
Direct link to MIDC (Maharashtra Industrial Development Corporation) Growth Centre, mining and mineral logistics hub
Industrial buyers, warehouse demand, last-mile connectivity for freight
Land adjacent to forest zones needs an NOC (No Objection Certificate) from the forest department, don't assume it's coming
Bhandara to Paldongri
Agricultural belt, Rotary and Panjra interchanges, 115 villages under acquisition
Acquisition notifications issued; no change-of-use or residential zoning approved yet. Verify your survey number's notification status before transacting.
NA conversion is incomplete in most villages, tribal land sale restrictions apply in several pockets
Savari to Gondia bypass
Tribal region, mining access, a 4 km bypass near Gondia (July 2025 report) improving city entry
Logistics, industrial, some residential near Gondia interchange
Tribal land requires specific clearances, and many parcels are still classified agricultural with no approved change of use
Corridor Stretch
What's There Now
Buyer-Relevant Activity
What Can Go Wrong
Gavasi to Jamtha
Gavasi interchange, 5 km from where Samruddhi begins at Shivmadka
RERA layouts, NMRDA oversight, plotted developments already moving
Prices have run ahead of delivery, confirm the NA order is final and the development plan permits residential use
Tiroda connector (14 km, July 2025 report)
Direct link to MIDC (Maharashtra Industrial Development Corporation) Growth Centre, mining and mineral logistics hub
Industrial buyers, warehouse demand, last-mile connectivity for freight
Land adjacent to forest zones needs an NOC (No Objection Certificate) from the forest department, don't assume it's coming
Bhandara to Paldongri
Agricultural belt, Rotary and Panjra interchanges, 115 villages under acquisition
Acquisition notifications issued; no change-of-use or residential zoning approved yet. Verify your survey number's notification status before transacting.
NA conversion is incomplete in most villages, tribal land sale restrictions apply in several pockets
Savari to Gondia bypass
Tribal region, mining access, a 4 km bypass near Gondia (July 2025 report) improving city entry
Logistics, industrial, some residential near Gondia interchange
Tribal land requires specific clearances, and many parcels are still classified agricultural with no approved change of use
The stretch nobody talks about honestly: Navegaon-Nagzira. The expressway passes within 5 km of the notified tiger reserve, which triggers Category A environmental clearance under the 2006 EIA (Environmental Impact Assessment) rules. Brokers sell "eco-tourism plots" here, but forest department approval is required for any commercial activity. Most of these plots don't have it and won't get it.
This page draws on the state government's approvals for the project and established news reports of MSRDC's progress, read in October 2026. MSRDC's own project pages could not be read for this update, so each milestone is cited to the report that published it. Where a fact could not be confirmed, it was left out, and the village list gives only the villages named in published reports.
* The Live Nagpur (27 August 2025): Cabinet approval, 162.5 km length, 115 villages, eight interchanges, Gavsi Manapur start, structures * The Live Nagpur (3 July 2025): route ends, 1,600 hectares, joint measurement survey, 30-month construction period, project cost * The Live Nagpur (22 July 2026): Cabinet Infrastructure Committee decision of 22 April 2026 and the state guarantee for the HUDCO loan * The Live Nagpur (19 November 2024, 8 December 2022): early project milestones and cost estimate * Government Resolution of 3 October 2025 (as cited on this page): administrative sanction and land acquisition funding

Boundaries and numbers come from published state cadastral records. See all map layers.

View Mumbai Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Mumbai masterplan 20...

View Nagpur Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Nagpur Metropolitan ...

View Pimpri Chinchwad Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Pimpri Chi...

View Mumbai Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Mumbai masterplan 20...

View Nagpur Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Nagpur Metropolitan ...

View Pimpri Chinchwad Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Pimpri Chi...
It's 162.57 km total. That breaks into 72.5 km from Nagpur to Bhandara, 72.6 km from Bhandara to Gondia, a 3.8 km Tiroda connector, and a 13.7 km bypass around Gondia city.
Land acquisition started in 2023 and received Cabinet approval on 26 August 2025 and administrative sanction (GR) on 3 October 2025. MSRDC's contractor selection is in progress; the letter of award is pending land acquisition completion while they finish acquiring land. In April 2026, the Cabinet Infrastructure Committee approved MSRDC's HUDCO loan for land acquisition, and the state guarantee followed by July 2026. Contractors are to get 30 months once work is awarded. As of October 2026, there is no official completion date yet.
Land acquisition has ₹3,162.18 crore sanctioned: ₹2,006 crore principal and ₹1,156 crore interest, per the 3 October 2025 Government Resolution. Construction cost has not yet been publicly notified in a GR; a July 2025 report put the total project cost at about ₹21,670 crore. MSRDC will borrow from HUDCO (Housing and Urban Development Corporation) with state backing, and the state approved that guarantee in 2026.
Nagpur, Bhandara, and Gondia districts. It crosses eight talukas: Nagpur, Hingna, Mauda, Bhandara, Mohadi, Tiroda, and Gondia, touching 115 villages across those districts.
Yes. The current route via Bhandara takes three to four hours covering 161 km. The new expressway cuts that to 75 minutes. The 145 km figure refers to the main access-controlled carriageway; the total project length including the Tiroda spur (3.8 km) and Gondia bypass (13.7 km) is 162.57 km.
Yes. It starts at Gavasi village on Nagpur's Outer Ring Road, roughly 5 km from where Samruddhi begins at Shivmadka. That links Mumbai to Gondia through Nagpur in one continuous corridor.
MSRDC issued notifications across all three districts starting in 2023. Joint measurement and licensing are in progress as of early 2026. In April 2026, the Cabinet Infrastructure Committee approved the HUDCO loan for land acquisition, and by July 2026 the state had approved a guarantee of ₹3,162.18 crore. Use the 1acre Premium Nagpur–Gondia Expressway layer (https://1acre.in/subscribe) to verify your survey number's notification and acquisition status before transacting.
Eight interchanges: Gavasi, Pachgaon, Thana, Rotary, Panjra, Paldongri, Lohri, and Savari. The route also includes 26 flyovers, 15 major bridges, 63 smaller ones, and eight wildlife underpasses for the tiger reserve section.
As of October 2026, the project is at the land acquisition stage. The latest milestone, reported in July 2026, is the state's guarantee of ₹3,162.18 crore for MSRDC's HUDCO loan to buy land, after the Cabinet Infrastructure Committee approved the loan on 22 April 2026. No construction contract has been announced; tenders are to follow once acquisition nears completion.
MSRDC has not published a consolidated village list PDF online that could be verified. The project covers about 115 villages in Nagpur, Bhandara and Gondia districts, and the notices are issued district by district, usually in Marathi. Ask the land acquisition officer at the Collector's office for your district for the notification covering your village and survey number.
About 1,600 hectares, mostly agricultural land, with the largest share in Gondia district followed by Nagpur and Bhandara. The land lies in about 115 villages. The state has sanctioned ₹3,162.18 crore for land acquisition, funded by a HUDCO loan of ₹2,006.03 crore plus estimated interest, under a state guarantee approved in 2026.
It starts at the Gavsi Manapur interchange on Wardha Road near Jamtha, on Nagpur's Outer Ring Road, about 5 km from where the Samruddhi Mahamarg begins at Shivmadka. It ends at Sawari village near Gondia city, with a connector to Tiroda and a bypass around Gondia. The road is planned as an extension of the Samruddhi Expressway.
Source
Official Maharashtra State Road Development Corporation (MSRDC) documents
Official Website
msrdc.in
Coordinate Reference System
EPSG:4326 (WGS 84)
Geometry Type
Polygon / MultiPolygon
Data Format
Raster Tiles (from GeoTIFF)
Last Verified
April 2026
Status
Active
Anything wrong, outdated, or missing we want to hear it.
