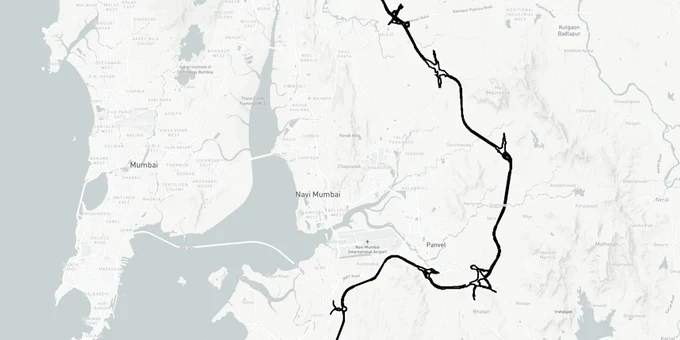

The Virar Alibaug multimodal corridor is a 126.06 km, 14-lane access-controlled expressway from Navghar in Vasai taluka to Alibaug, implemented by the Maharashtra State Road Development Corporation (MSRDC). It links JNPA port, Navi Mumbai International Airport and the Mumbai Trans Harbour Link, and is expected to cut travel time across the region by about 90 minutes. Earlier plans described road, rail and even ferry links cutting across coastal Maharashtra.
The project has moved past the DPR stage. The state cabinet approved Rs 37,013 crore in 2025, including Rs 22,250 crore for land acquisition. In November 2025 it guaranteed a Rs 2,000 crore HUDCO loan for land acquisition, and in May 2026 the Urban Development Department gave administrative approval for Phase 1 (Navghar to Balavali, 96.41 km) at Rs 31,793.47 crore. This layer marks where the route runs based on the project alignment. Land along this corridor is still sold on claims that go beyond the official record. This page tells you what's real, what's speculation, and where brokers are running outright scams.
The figures below come from state approvals reported between March 2025 and May 2026.
Item
Detail
Length
126.06 km (126.3 km in some reports)
Type
14-lane access-controlled expressway
Start and end
Navghar (Vasai taluka, Palghar district) to Alibaug (Raigad district)
Phase 1
Navghar to Balavali (Pen taluka), 96.41 km
Phase 2
Balavali to Alibaug, the remaining stretch of about 29.65 km
Villages and talukas
104 villages in 8 talukas
Implementing agency
MSRDC
Model
BOT (2025 cabinet decisions); DBFOT public-private partnership in the May 2026 Phase 1 approval
Approved outlay
Rs 37,013 crore (2025): Rs 22,250 crore land acquisition and Rs 14,763 crore interest
Phase 1 approval
Rs 31,793.47 crore, administrative approval, May 2026
Roads it crosses
NH-48, NH-848, NH-61, Mumbai-Vadodara Expressway, Mumbai-Pune Expressway, NH-66
Item
Detail
Length
126.06 km (126.3 km in some reports)
Type
14-lane access-controlled expressway
Start and end
Navghar (Vasai taluka, Palghar district) to Alibaug (Raigad district)
Phase 1
Navghar to Balavali (Pen taluka), 96.41 km
Phase 2
Balavali to Alibaug, the remaining stretch of about 29.65 km
Villages and talukas
104 villages in 8 talukas
Implementing agency
MSRDC
Model
BOT (2025 cabinet decisions); DBFOT public-private partnership in the May 2026 Phase 1 approval
Approved outlay
Rs 37,013 crore (2025): Rs 22,250 crore land acquisition and Rs 14,763 crore interest
Phase 1 approval
Rs 31,793.47 crore, administrative approval, May 2026
Roads it crosses
NH-48, NH-848, NH-61, Mumbai-Vadodara Expressway, Mumbai-Pune Expressway, NH-66
Status as of October 2026: the latest verifiable update is the May 2026 administrative approval for Phase 1. Reports from September 2025 expected physical work to start by early 2026, with priority on the section that overlaps NHAI's Vadodara-Mumbai Expressway. No public report read for this page confirms that main construction has started, so treat the corridor as approved and in land acquisition. View the alignment on the 1acre map layer to see how close a plot sits to the route, then confirm with the official notification.
The full corridor passes through 104 villages across eight talukas in three districts. The village-wise list with survey numbers is published in the land acquisition notifications for each taluka; no single official list for all 104 villages was available to read in October 2026.
District
Taluka
Villages named in approvals
Palghar
Vasai
Navghar (start of Phase 1)
Thane
Bhiwandi
See the taluka notification
Thane
Kalyan
See the taluka notification
Thane
Ambernath
See the taluka notification
Raigad
Panvel
See the taluka notification
Raigad
Uran
See the taluka notification
Raigad
Pen
Balavali (end of Phase 1)
Raigad
Alibaug
End of the corridor
District
Taluka
Villages named in approvals
Palghar
Vasai
Navghar (start of Phase 1)
Thane
Bhiwandi
See the taluka notification
Thane
Kalyan
See the taluka notification
Thane
Ambernath
See the taluka notification
Raigad
Panvel
See the taluka notification
Raigad
Uran
See the taluka notification
Raigad
Pen
Balavali (end of Phase 1)
Raigad
Alibaug
End of the corridor
How to check whether your village is on the list:
Palghar and Dahanu talukas are not among the eight talukas in the approved route, so villages there, such as Manor and Mahim, are not on this corridor.
Land acquisition is the stage the corridor is in now. These are the dated updates that could be verified:
Date
Update
March 2025
MSRDC secured funding commitments of Rs 21,500 crore from lenders, including REC (Rs 10,000 crore), NaBFID (Rs 3,000 crore) and IIFCL (Rs 3,000 crore)
June 2025
Cabinet approved Rs 37,013 crore, of which Rs 22,250 crore is for land acquisition; the project moved from EPC to BOT after EPC bids came in above estimates
September 2025
MSRDC said land acquisition would be fast-tracked; work was expected to start by early 2026
November 2025
Cabinet approved a state guarantee for a Rs 2,000 crore HUDCO loan to MSRDC for land acquisition
May 2026
Administrative approval for Phase 1 (Navghar to Balavali) at Rs 31,793.47 crore
Date
Update
March 2025
MSRDC secured funding commitments of Rs 21,500 crore from lenders, including REC (Rs 10,000 crore), NaBFID (Rs 3,000 crore) and IIFCL (Rs 3,000 crore)
June 2025
Cabinet approved Rs 37,013 crore, of which Rs 22,250 crore is for land acquisition; the project moved from EPC to BOT after EPC bids came in above estimates
September 2025
MSRDC said land acquisition would be fast-tracked; work was expected to start by early 2026
November 2025
Cabinet approved a state guarantee for a Rs 2,000 crore HUDCO loan to MSRDC for land acquisition
May 2026
Administrative approval for Phase 1 (Navghar to Balavali) at Rs 31,793.47 crore
Compensation and price lists. No official per-acre or per-guntha rate list for the corridor was published in the sources reviewed. Compensation for land taken compulsorily is fixed by the competent authority for each notified survey number, not by a broker's quote. If someone shows you a "land acquisition price list" or a "land acquisition PDF", ask for the notification number, date and issuing office, and check it at the collector's office before you act on it. For land just outside the footprint, check the final alignment and any service road or interchange land in the same notification.
Brokers love this corridor because buyers rarely check the official record. The DPR doesn't list specific survey numbers.
You'll see printouts showing your plot falls right in the alignment path. Most of these maps are fabricated. Earlier DPR descriptions split the route into three segments: Virar to Panvel at 52 km, Panvel to Revdanda at 48 km, and Revdanda to Alibaug at 26 km. The approved project now runs in two phases: Phase 1 from Navghar to Balavali (96.41 km) and Phase 2 from Balavali to Alibaug. Land acquisition is funded, so the test for any plot is simple: a survey number is affected only if it appears in an official acquisition notification. If a broker shows you a map with your survey number circled in red, ask for the acquisition notification number. If they don't have it, the map proves nothing.
Fraud Pattern
What Brokers Claim
What's Actually True
Alignment certainty
This survey number is confirmed in the route
Only an acquisition notification confirms a survey number
Influence zone pricing
Land within 300 meters gets automatic value jump
No official influence zone defined in any government document
Approval status
Project is approved, just waiting for funds
Phase 1 got administrative approval in May 2026 and land acquisition is funded; check environmental and coastal clearances for your section with MSRDC
Compensation rates
Government will pay 4x market rate for acquisition
Compensation is fixed by the competent authority for each notified survey number; no published rate list or fixed multiple
Fraud Pattern
What Brokers Claim
What's Actually True
Alignment certainty
This survey number is confirmed in the route
Only an acquisition notification confirms a survey number
Influence zone pricing
Land within 300 meters gets automatic value jump
No official influence zone defined in any government document
Approval status
Project is approved, just waiting for funds
Phase 1 got administrative approval in May 2026 and land acquisition is funded; check environmental and coastal clearances for your section with MSRDC
Compensation rates
Government will pay 4x market rate for acquisition
Compensation is fixed by the competent authority for each notified survey number; no published rate list or fixed multiple
The worst scam involves something called the influence zone. Brokers claim any land within 300 meters of the proposed route will see automatic appreciation. There is no such zone in the DPR or any official notification. If someone uses this term, you're being misled.
Five areas are seeing serious land speculation. Only two make sense if the corridor never happens.
Virar East and Vasai East already have trains running to Mumbai. Land there has other reasons to hold value. Manor and Mahim in Palghar are pure bets on the corridor with zero backup plan. Pen and Revdanda face coastal regulation nightmares that could kill parts of the project before a single brick gets laid. If you're buying in Manor and the corridor gets shelved, you own agricultural land with no conversion path and no connectivity.
Area
What Works Today
Why People Are Buying
The Catch
Virar East
Suburban trains to Churchgate
Spillover demand from Vasai
Already priced high, limited upside left
Vasai East
Western Railway plus IT park coming up
Job creation independent of corridor
Conversion applications backlogged 18 months
Manor
Nothing
Believed to be corridor midpoint
No masterplan coverage, agricultural use only
Pen
State Highway 4 access
Believed to be equidistant from both ends
CRZ buffer could block alignment changes
Revdanda
Small ferry service to Gateway
Proposed waterway terminal location
Terminal site is in CRZ-I restricted zone
Area
What Works Today
Why People Are Buying
The Catch
Virar East
Suburban trains to Churchgate
Spillover demand from Vasai
Already priced high, limited upside left
Vasai East
Western Railway plus IT park coming up
Job creation independent of corridor
Conversion applications backlogged 18 months
Manor
Nothing
Believed to be corridor midpoint
No masterplan coverage, agricultural use only
Pen
State Highway 4 access
Believed to be equidistant from both ends
CRZ buffer could block alignment changes
Revdanda
Small ferry service to Gateway
Proposed waterway terminal location
Terminal site is in CRZ-I restricted zone
Revdanda is where the project could collapse. The ferry terminal they're planning sits in a CRZ-I zone where construction is mostly banned. The clearance application has been pending since 2023 with no movement. Anyone buying land in Revdanda betting on that terminal is gambling on an approval that coastal regulators rarely give.
One correction for buyers: the May 2026 approval lists eight talukas on the route (Vasai, Bhiwandi, Kalyan, Ambernath, Panvel, Uran, Pen and Alibaug). Manor and Mahim are in Palghar taluka, which is not on that list, so land there is not a corridor play at all.
Searchers often ask how far Virar is from Alibaug. The corridor itself is 126.06 km long from Navghar, near Virar, to Alibaug, and the state expects it to cut travel time across the region by about 90 minutes once open. Today's road distance depends on the route you take (through Thane and Panvel, or across the Mumbai Trans Harbour Link), so check a live map from your exact start point.
Alibaug coastal link. The corridor is an inland expressway. A separate MSRDC project, a 2.04 km four-lane bridge over Dharamtar Creek between Revas and Karanja in Raigad district, was reported in February 2023 to be at award stage. That report said it would cut the JNPT to Alibaug driving distance from about 55 km to 30 km, and the Revas to Karanja crossing from about two hours to about 10 minutes. Check MSRDC for its current status before relying on it for a plot near Alibaug.
Link
Length
What it connects
Latest report
Virar Alibaug corridor
126.06 km
Navghar (Vasai) to Alibaug
Phase 1 approved, May 2026
Revas-Karanja bridge
2.04 km
Revas and Karanja across Dharamtar Creek
Award stage, February 2023
Link
Length
What it connects
Latest report
Virar Alibaug corridor
126.06 km
Navghar (Vasai) to Alibaug
Phase 1 approved, May 2026
Revas-Karanja bridge
2.04 km
Revas and Karanja across Dharamtar Creek
Award stage, February 2023

Boundaries and numbers come from published state cadastral records. See all map layers.

View Mumbai Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Mumbai masterplan 20...

View Nagpur Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Nagpur Metropolitan ...

View Pimpri Chinchwad Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Pimpri Chi...

View Mumbai Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Mumbai masterplan 20...

View Nagpur Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Nagpur Metropolitan ...

View Pimpri Chinchwad Masterplan as a live map overlay – check any plot's land use zone for free on 1acre.in. Pimpri Chi...
A 126.3 km access-controlled expressway connecting Navghar (near Virar) to Alibaug via Bhiwandi, Kalyan, Panvel, and Pen. The Maharashtra Cabinet approved the project on a build-operate-transfer (BOT) model in 2025, with Rs 37,013 crore sanctioned and land acquisition fast-tracked by MSRDC. Phase 1 (Navghar-Balavali, 96.41 km) targets completion by 2030.
Phase 1 (Navghar to Balavali, 96.41 km) targets completion by 2030, with groundwork expected to begin in 2026 following Cabinet approval in 2025. Phase 2 (Balavali to Alibaug, 29.9 km) timeline depends on Phase 1 progress. Land acquisition delays remain a risk even with approvals in place.
The 126.3 km corridor passes through Vasai, Bhiwandi, Kalyan, Ambernath, Panvel, Uran, Pen, and Alibaug, with connections to JNPT and the upcoming Navi Mumbai International Airport. Virar and Vasai already have rail links so their upside is connectivity-driven. Bhiwandi, Pen, and the Alibaug belt are more dependent on the corridor for value realisation.
Prices along the corridor rose 40-60% after the DPR announcement in 2023. Cabinet approval and land acquisition sanction in 2025 add a fundamental basis to those gains, but acquisition notifications for specific plots are still being issued. Verify whether your survey number has received a Section 19B notice before purchasing.
Yes. The Maharashtra Cabinet approved the corridor on a build-operate-transfer (BOT) model in June 2025, with Rs 37,013 crore approved, including Rs 22,250 crore for land acquisition. In November 2025 the state guaranteed a Rs 2,000 crore HUDCO loan for land acquisition, and in May 2026 Phase 1 received administrative approval at Rs 31,793.47 crore. Some forest and CRZ clearances for specific sections may still be outstanding, so verify current status for your plot's section with MSRDC.
The 126.3 km corridor follows this alignment: Navghar (near Virar) → Vasai → Bhiwandi → Kalyan → Ambernath → Panvel → Uran → Pen → Alibaug.
Yes, but first verify that your survey number has not received a Section 19B acquisition notice — land inside the corridor footprint will be compulsorily acquired at government-determined rates. Outside the footprint, the investment now has legitimate fundamentals following Cabinet approval and Rs 37,013 crore in funding. Use the 1acre Premium layer to cross-reference your plot against the corridor alignment before committing.
The primary risk is now compulsory acquisition: land inside the 120-metre corridor footprint will be acquired by MSRDC at government-determined rates, not market value. Secondary risks: coastal and forest clearance delays for specific sections could force alignment shifts. Brokers continue to use fake survey-number maps not referenced in official documents, so verify your survey number against the official acquisition notification and with MSRDC before purchasing.
The corridor passes through 104 villages in eight talukas: Vasai, Bhiwandi, Kalyan, Ambernath, Panvel, Uran, Pen and Alibaug. Phase 1 runs from Navghar in Vasai taluka to Balavali in Pen taluka. The village-wise list with survey numbers is in the land acquisition notification for each taluka, available from the collector's offices of Palghar, Thane and Raigad.
As of October 2026, the latest verified update is the May 2026 administrative approval for Phase 1 (Navghar to Balavali, 96.41 km) at Rs 31,793.47 crore. Before that, the state guaranteed a Rs 2,000 crore HUDCO loan for land acquisition in November 2025, and set aside Rs 22,250 crore for land acquisition in June 2025. Check your taluka's notification for plot-level status.
The corridor is 126.06 km from Navghar, near Virar, to Alibaug, and is expected to cut regional travel time by about 90 minutes once open. Today's road distance depends on the route, through Thane and Panvel or across the Mumbai Trans Harbour Link, so check a live map from your exact start point. The corridor is not yet open to traffic.
The Maharashtra State Road Development Corporation (MSRDC) is the implementing agency in the 2025 and 2026 state approvals. The project was earlier planned through MMRDA, which is why older maps and pages carry MMRDA's name. For land acquisition questions, deal with MSRDC and the collector's office of your district, not with the agency named on an old map.
No official rate list for the corridor was published in the sources reviewed for this page. Compensation is fixed by the competent authority for each notified survey number. Treat any 'price list' or 'land acquisition PDF' shared by brokers as unverified until it carries a notification number, date and issuing office that you have checked at the collector's office.
