Uttan Virar Sea Link

MMRDA

Road

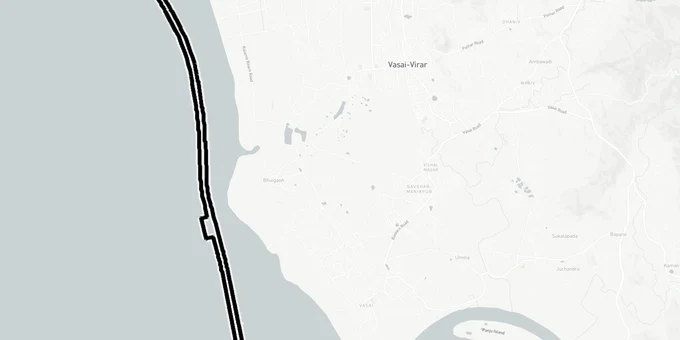

Uttan Virar Sea Link map

Overview

The Uttan Virar Sea Link land investment story picked up real weight on 25 November 2025, when the Maharashtra government approved the DPR and released a Government Resolution committing Rs 58,754.71 crore for Phase 1. Implemented by MMRDA, the 55.12 km corridor comprises a 24.35 km sea bridge and 30.77 km of approach roads across Uttan, Vasai, and Virar. Originally proposed as the Versova-Virar Sea Link and rescoped to the current Uttan-Virar alignment in 2022.

Mangrove and CRZ Traps Buyers Are Missing Near the Uttan and Virar Connector Routes

The three connectors are where land buyers face the most danger, not the sea bridge itself. MMRDA is acquiring 208.6 hectares of private land for the connectors alone, and the alignment directly impacts 15.39 hectares of mangrove forest and 2.5 hectares of reserved forest inside the Tungareshwar Wildlife Sanctuary eco-sensitive zone near the Virar connector. Any plot sitting on or adjacent to that acquisition footprint is either already subject to a compensation award or legally restricted from development under Maharashtra's Coastal Regulation Zone rules.

The table below shows the three connector segments where private land acquisition is active or likely.

Uttan connector

Length

9.32 km

Starting Point

Interchange near Uttan Beach, links to Dahisar-Bhayandar Link Road

Known Impact

8.71 ha mangroves affected

Vasai connector

Length

2.5 km

Starting Point

Vasai interchange

Known Impact

Least CRZ exposure of the three

Virar connector

Length

18.95 km

Starting Point

Arnala beach, links to Delhi-Mumbai Expressway via 1.2 km Arnala Fort tunnel

Known Impact

6.68 ha mangroves affected; Tungareshwar eco-sensitive zone nearby

The mangrove boundary is the single most misrepresented fact in plots marketed near the Uttan and Virar connectors. Maharashtra law prohibits any construction within mangrove boundaries notified by the state government, and the Bombay High Court has historically been strict on mangrove encroachment. Before you pay any advance near Uttan beach or Arnala, verify the plot's distance from notified mangrove patches using the MCZMA official maps, not a broker's sketch. MCZMA cleared the UVSL project on 11 July 2025, with Union Ministry of Environment, Forests and Climate Change approval still pending as of April 2026.

Virar East, Naigaon, and Vasai Road: Which Pockets Are Most Directly Activated by the UVSL Corridor

The Virar connector is the longest at 18.95 km and ties directly into the Delhi-Mumbai Expressway at Virar interchange. That single connection is what drives Virar East's investment case, not sentiment. Naigaon and Vasai Road sit along the proposed Metro Line 13 (Purple Line) alignment, which is planned to run 23 km from Shivaji Chowk (Mira Road) to Virar. Line 13 remains at DPR stage; treat it as a planned, not active, driver.

The table below maps the four sub-markets most directly activated by the UVSL corridor, based on connector alignment and existing infrastructure.

Virar East

UVSL Relevance

Direct endpoint, 18.95 km Virar connector terminating here

Additional Driver

Delhi-Mumbai Expressway interchange

Key Risk

Mangrove and eco-sensitive zone proximity near Arnala

Uttan / Bhayandar

UVSL Relevance

Origin point of sea bridge, 9.32 km Uttan connector

Additional Driver

Dahisar-Bhayandar Link Road

Key Risk

Active private land acquisition underway, 208.6 ha total

Vasai Road

UVSL Relevance

2.5 km Vasai connector on alignment

Additional Driver

Bullet Train station at Virar, Metro Line 13

Key Risk

Least CRZ exposure; verify 7/12 for any creekside parcels

Naigaon

UVSL Relevance

Mid-corridor, benefits from Metro Line 13 stations

Additional Driver

Multiple under-construction residential projects

Key Risk

No direct connector; price run already partially baked in

Virar East is the most misread pocket in this corridor. Buyers assume proximity to Arnala beach is a pure upside. The 18.95 km Virar connector starts precisely at Arnala beach, meaning land directly in that zone faces acquisition risk, not appreciation. Virar East parcels further inland, along the Delhi-Mumbai Expressway interchange approach where the connector terminates, sit outside the notified acquisition footprint based on current MMRDA notifications.

Data Source & Verification

Source

Official Mumbai Metropolitan Region Development Authority (MMRDA) documents

Official Website

mmrda.maharashtra.gov.in

Coordinate Reference System

EPSG:4326 (WGS 84)

Geometry Type

Polygon / MultiPolygon

Data Format

Vector (GeoJSON) + Raster Tiles

Last Verified

April 2026

Status

Active

Disclaimer: Information shown here is indicative. Users should verify details with Mumbai Metropolitan Region Development Authority (MMRDA) or relevant authorities before any transaction or development decision.
